Initial Inspection & Site Condition

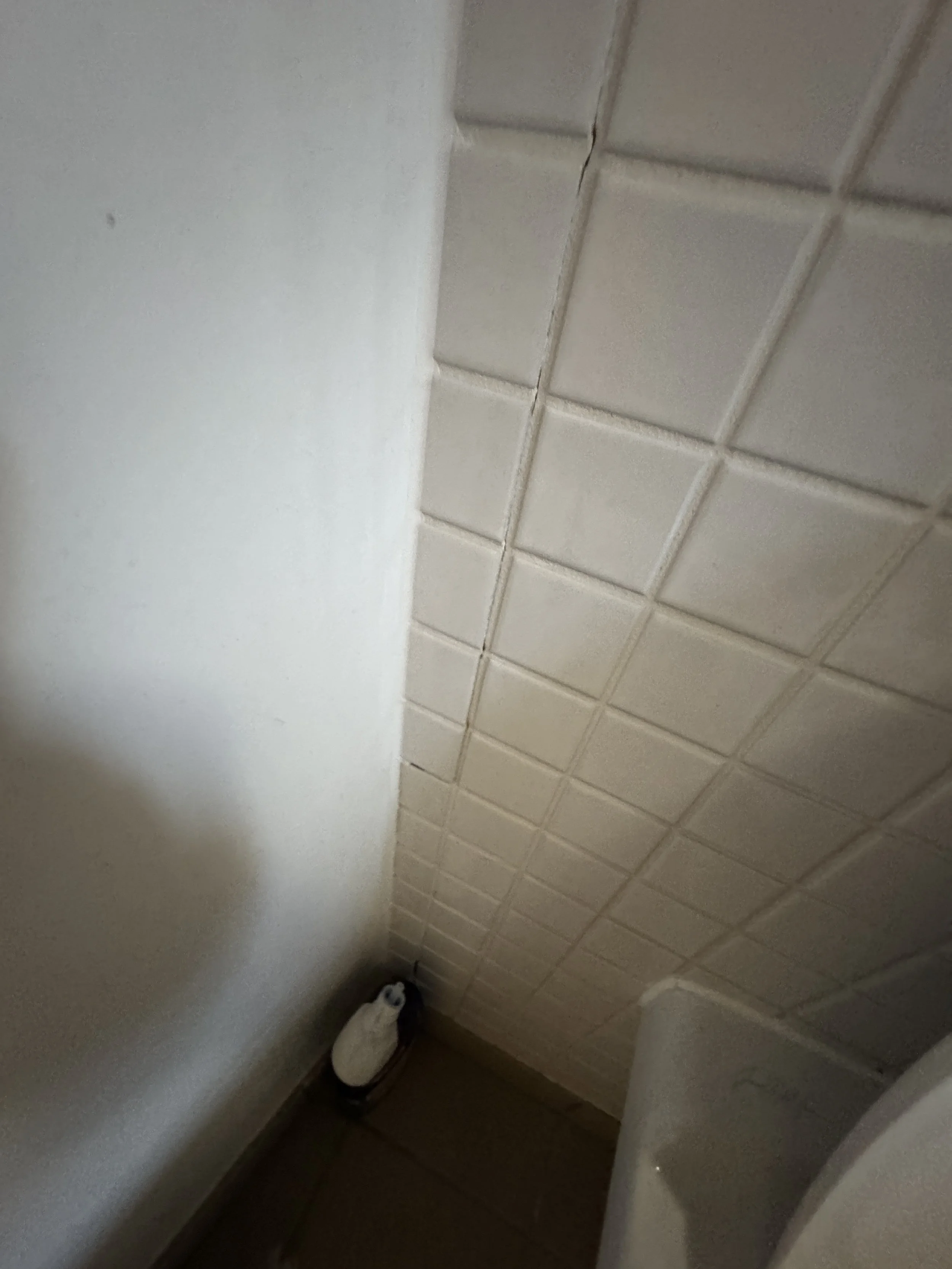

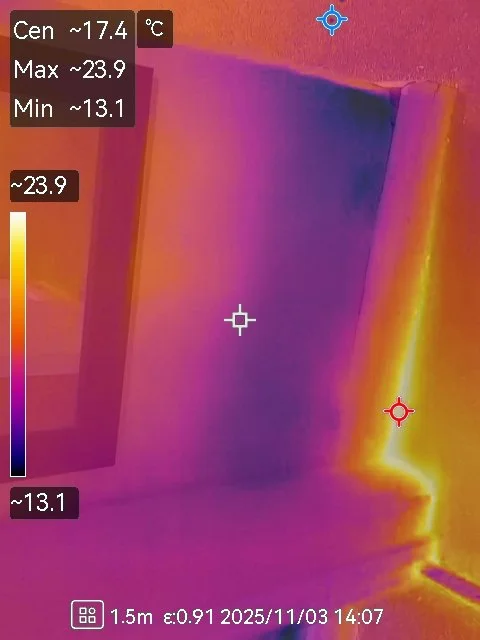

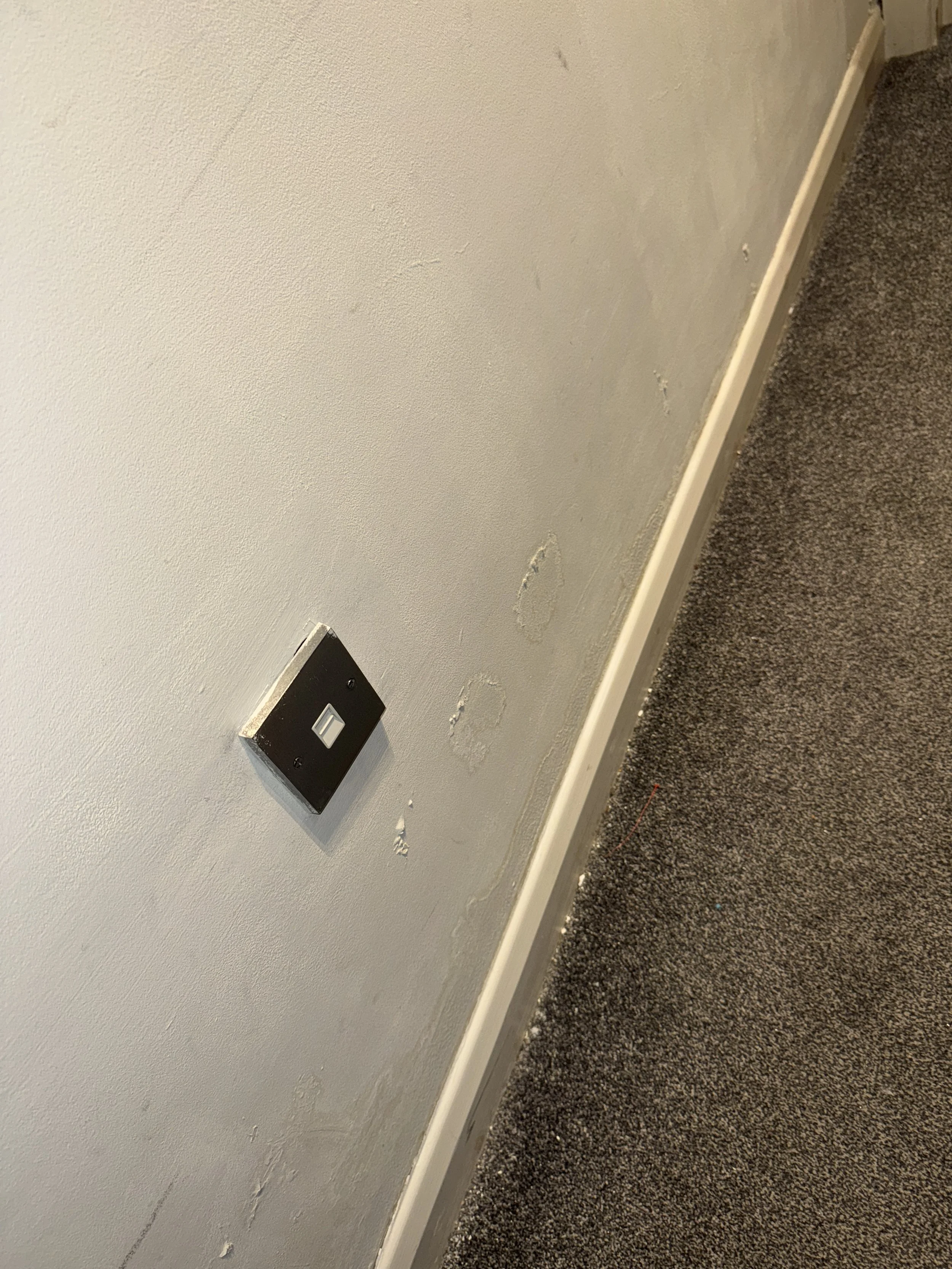

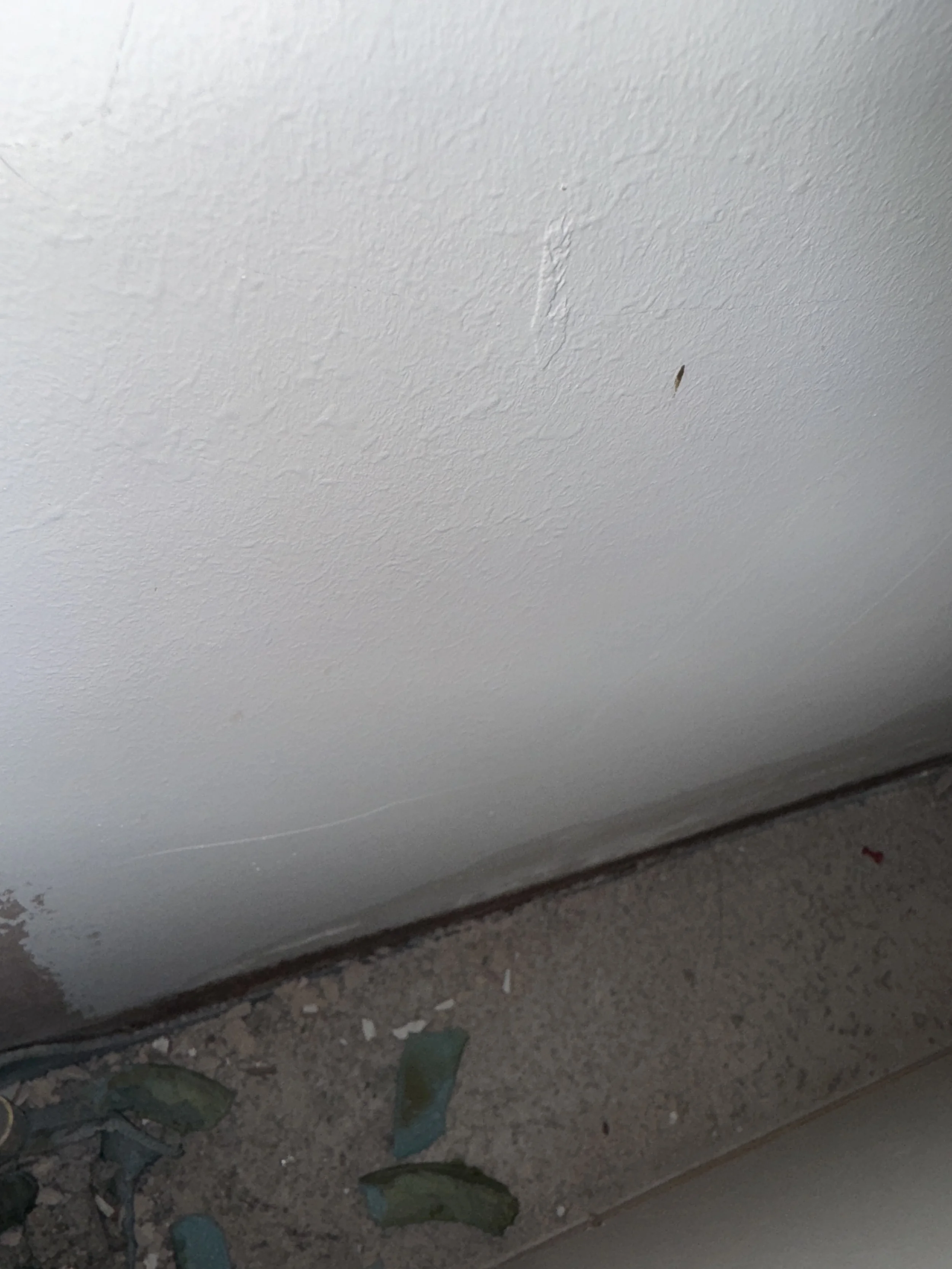

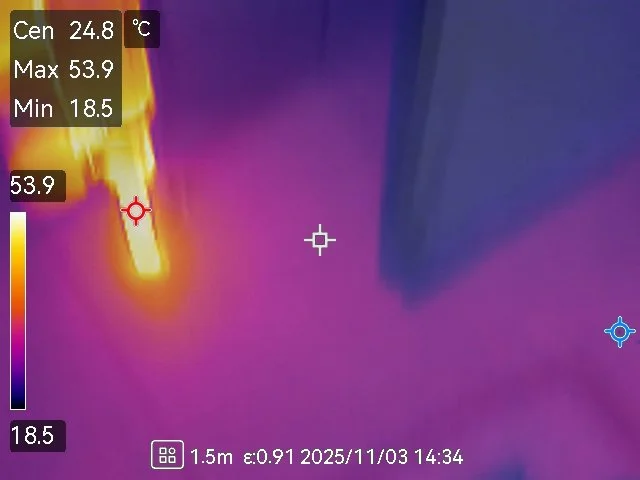

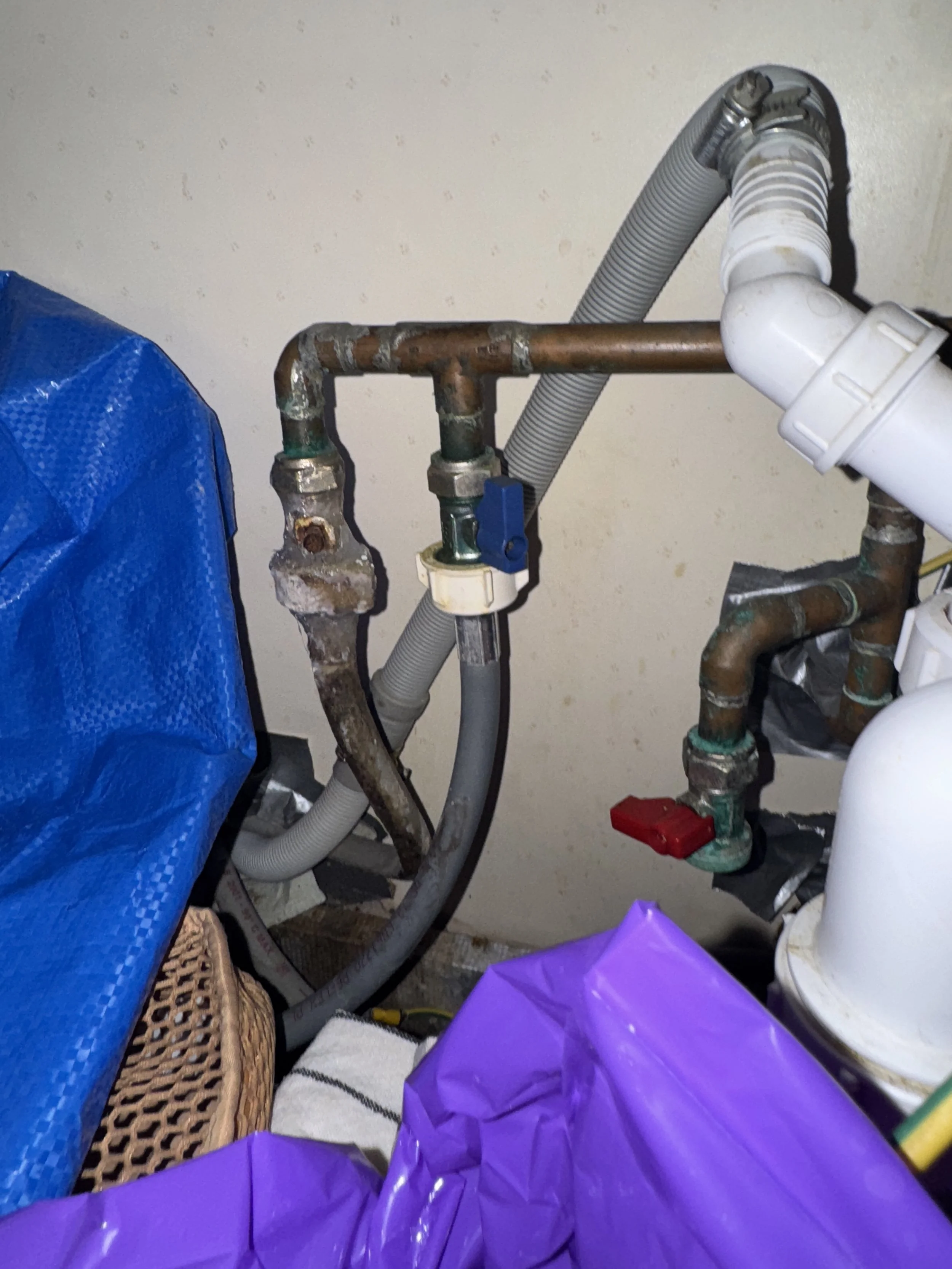

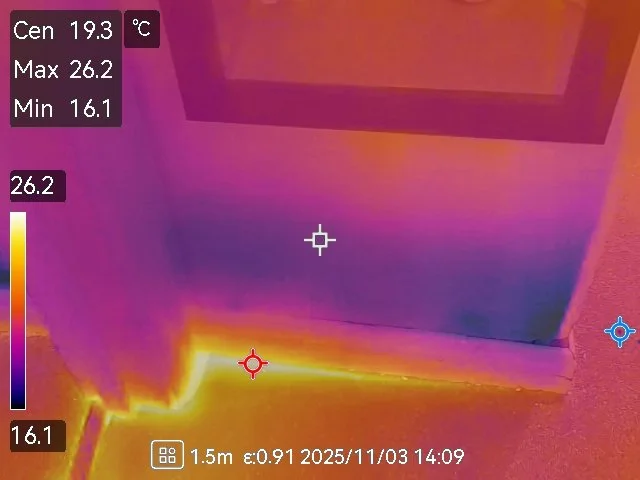

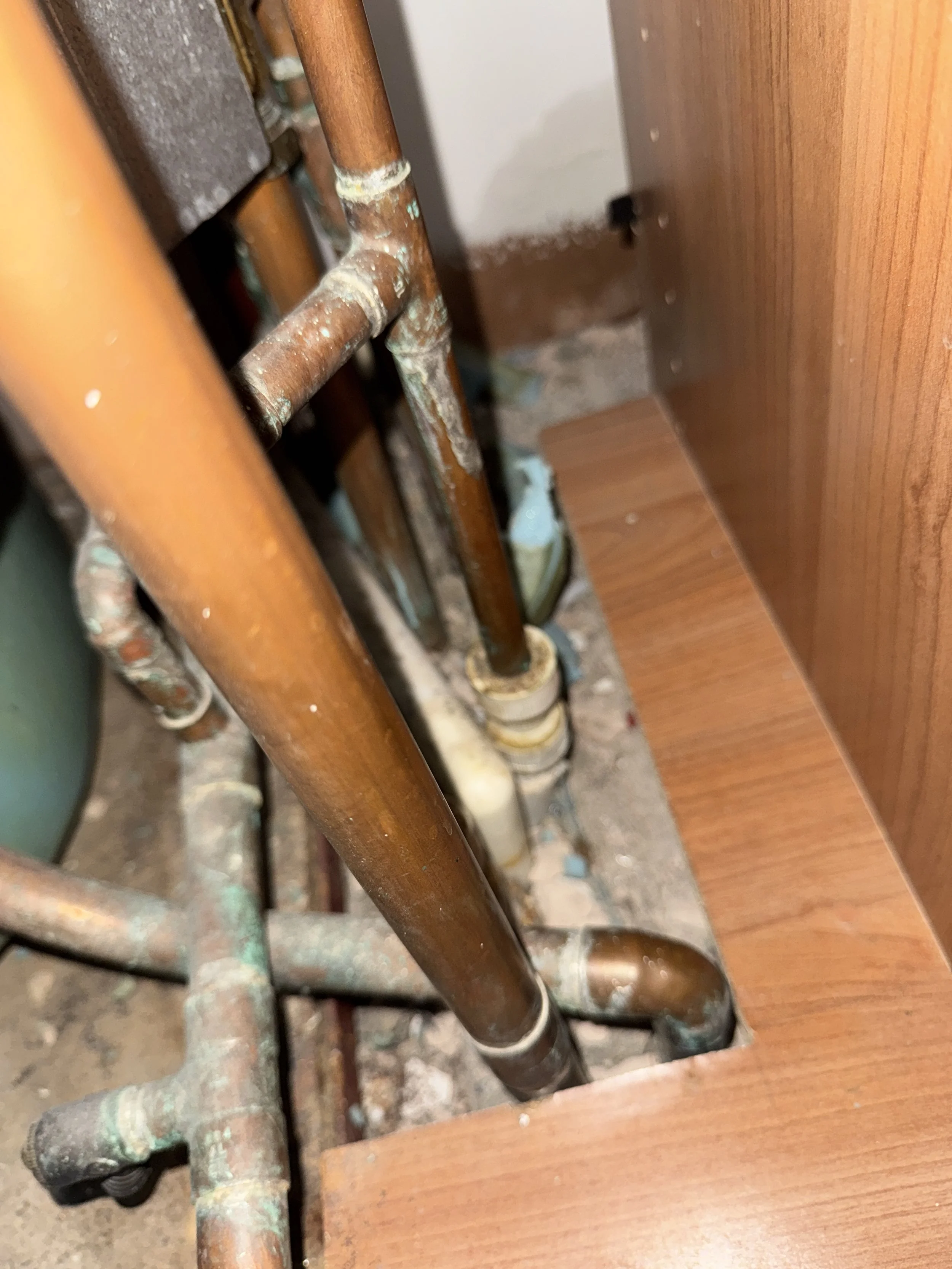

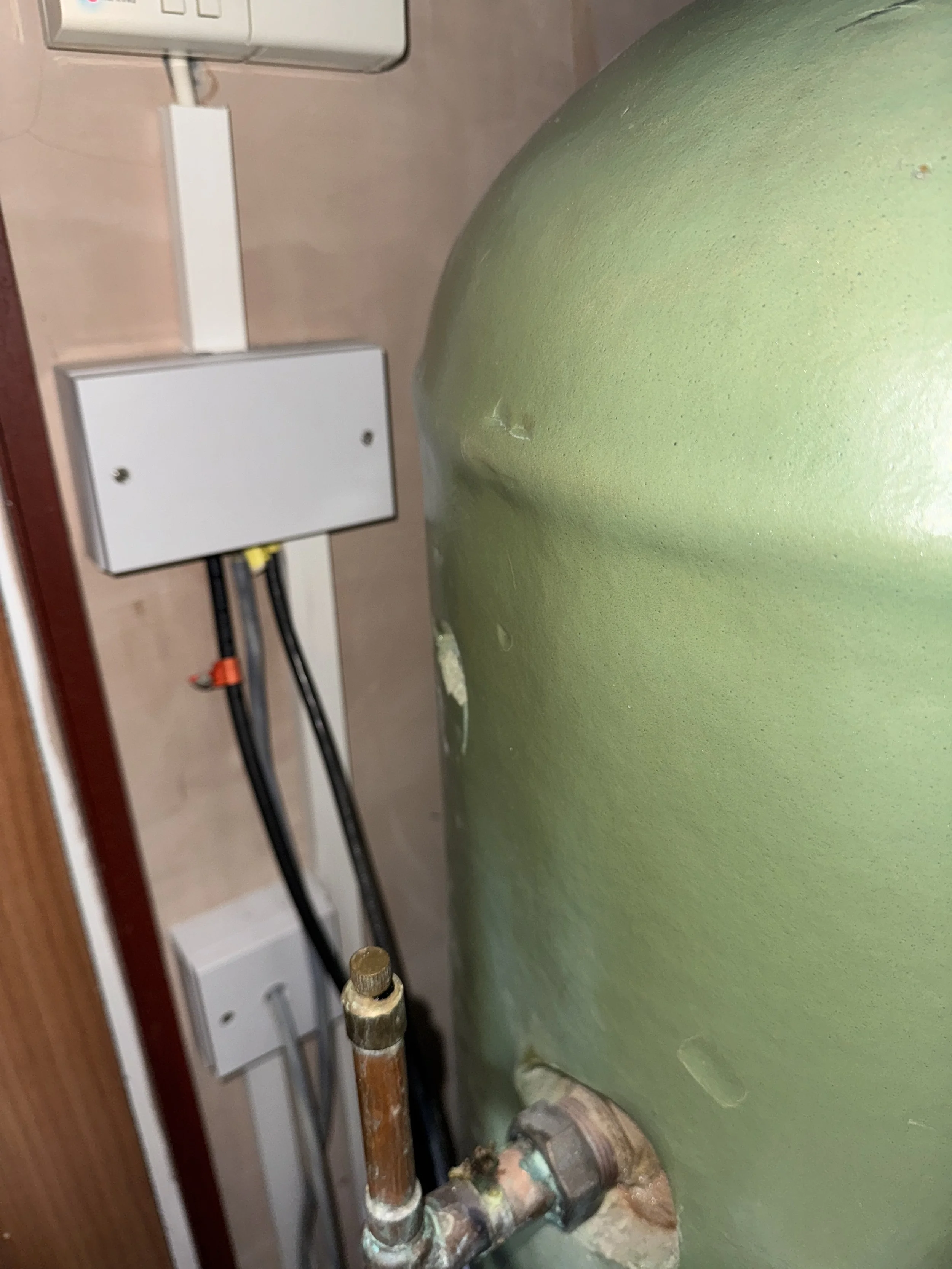

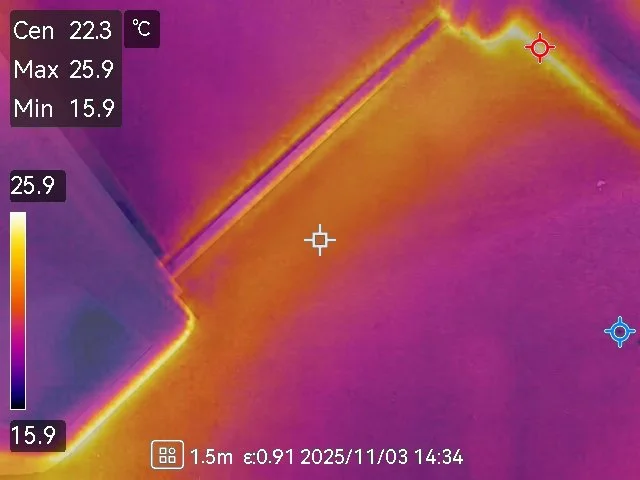

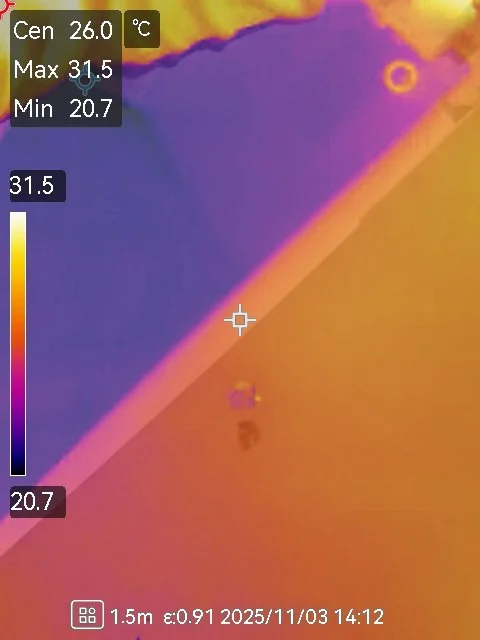

What initially appeared to be a minor bathroom leak quickly raised concerns during our first visit.

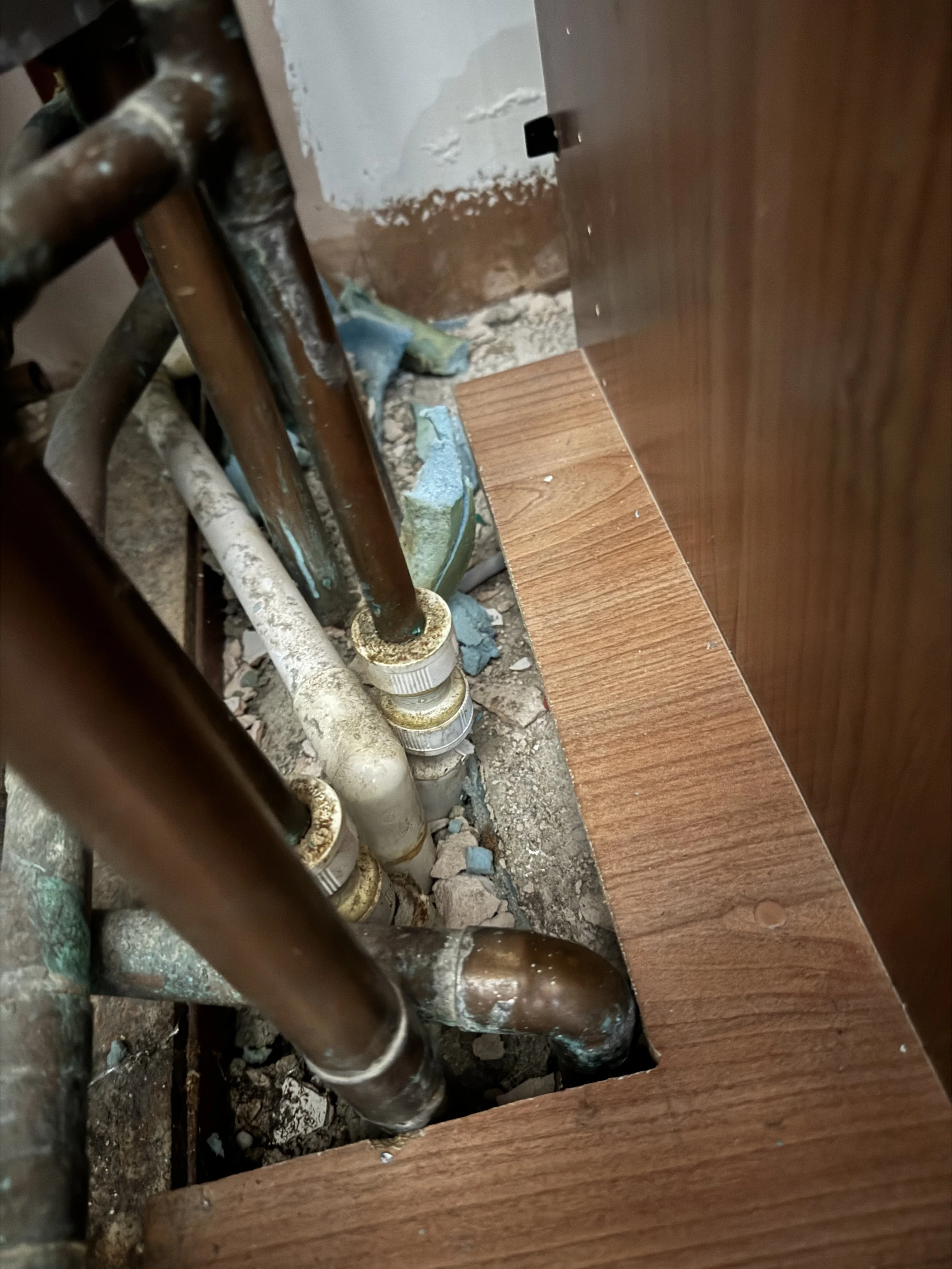

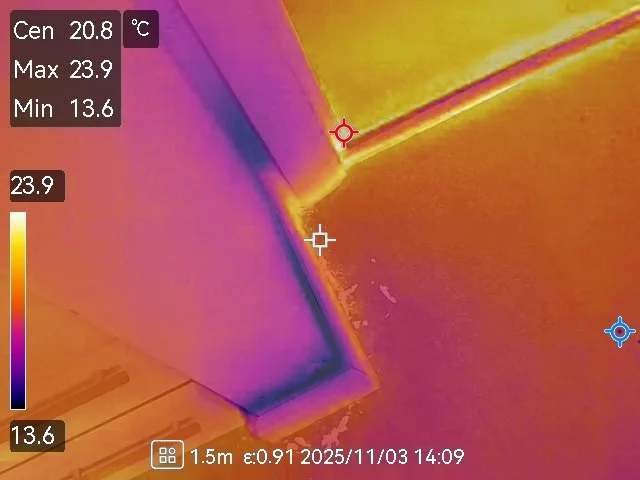

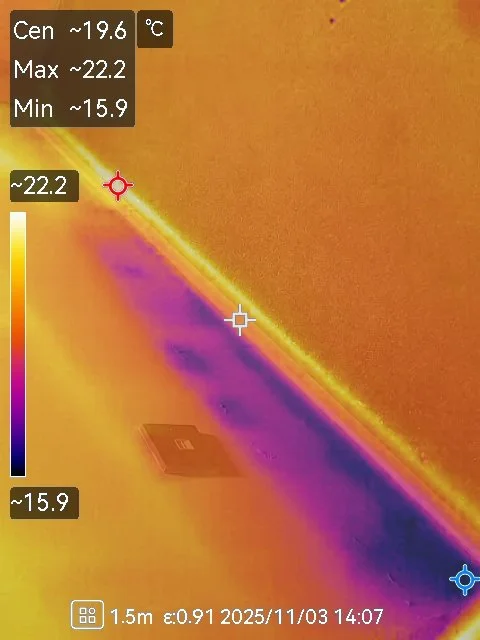

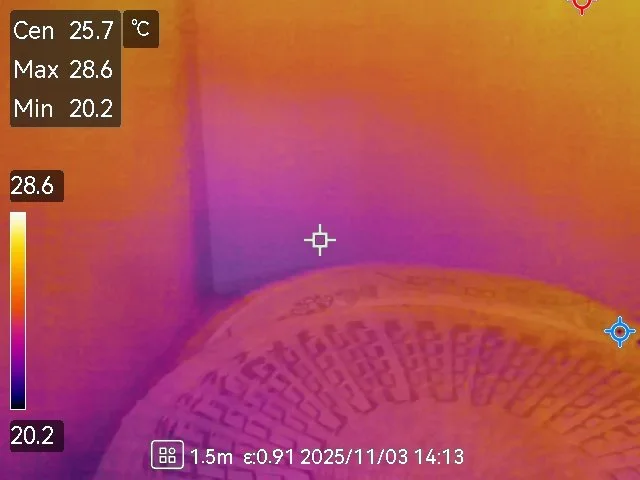

These images capture the condition of the property at the time of inspection — where visible moisture, concealed pipework, and early signs of system stress indicated that the issue extended far beyond a simple leak.

Decommissioning & Strip-Out

Following our findings, it became clear that the issue extended beyond a localised leak and required a full system intervention.

A proposal was presented to isolate and remove the active leak, upgrade the entire plumbing system, and reconstruct the bathroom to a proper standard.

Upon client approval, a structured 5-week programme was initiated.

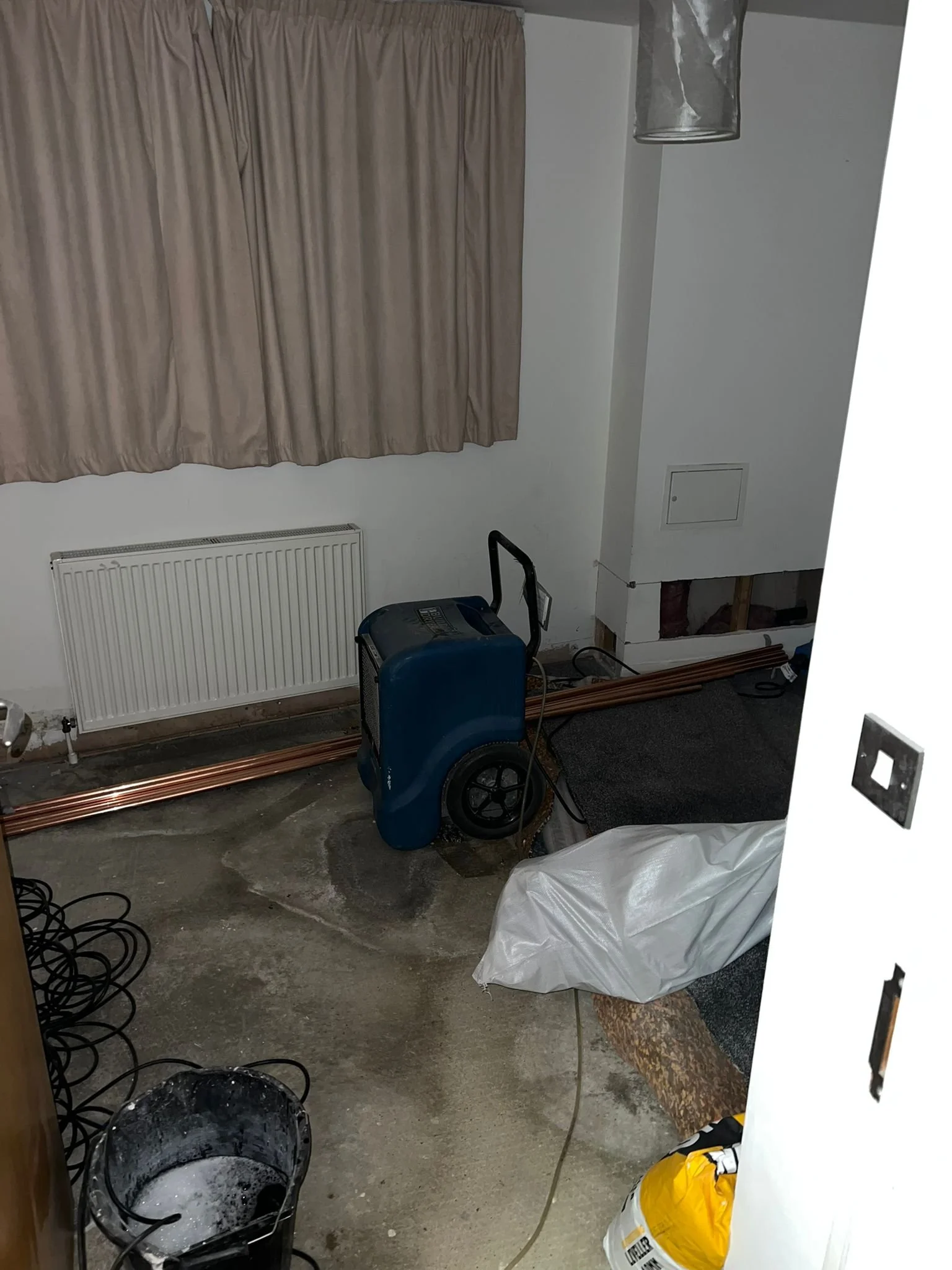

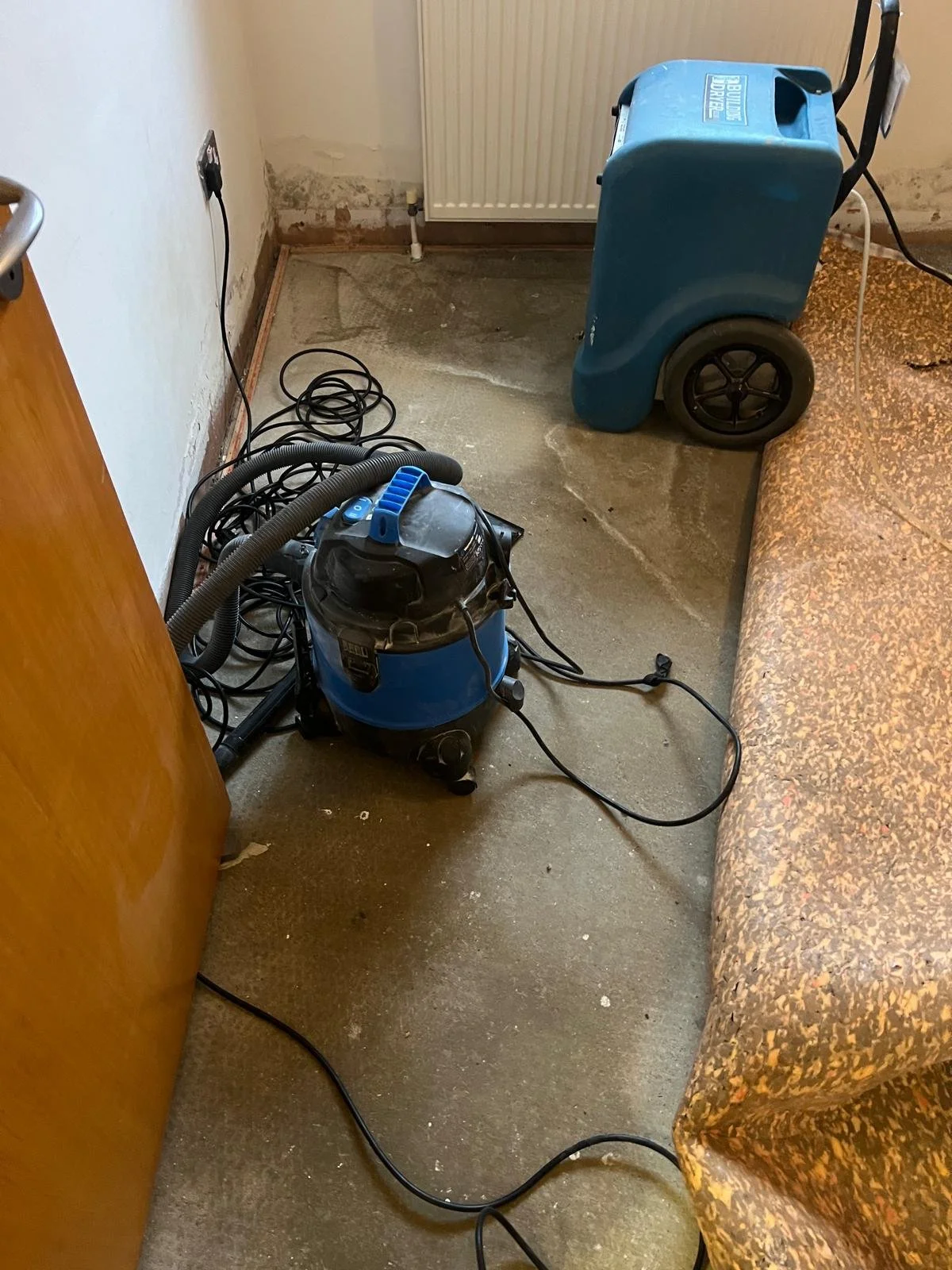

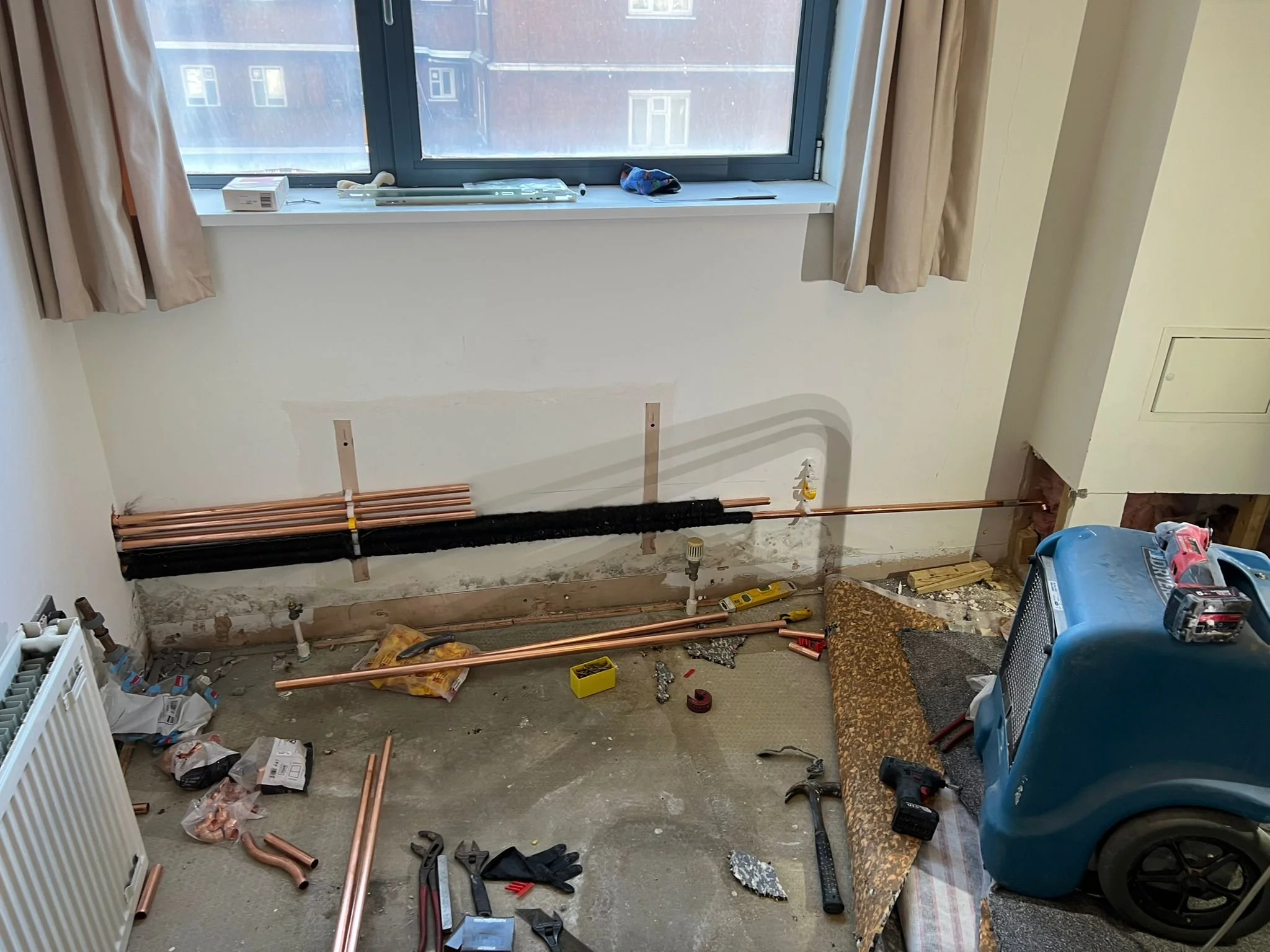

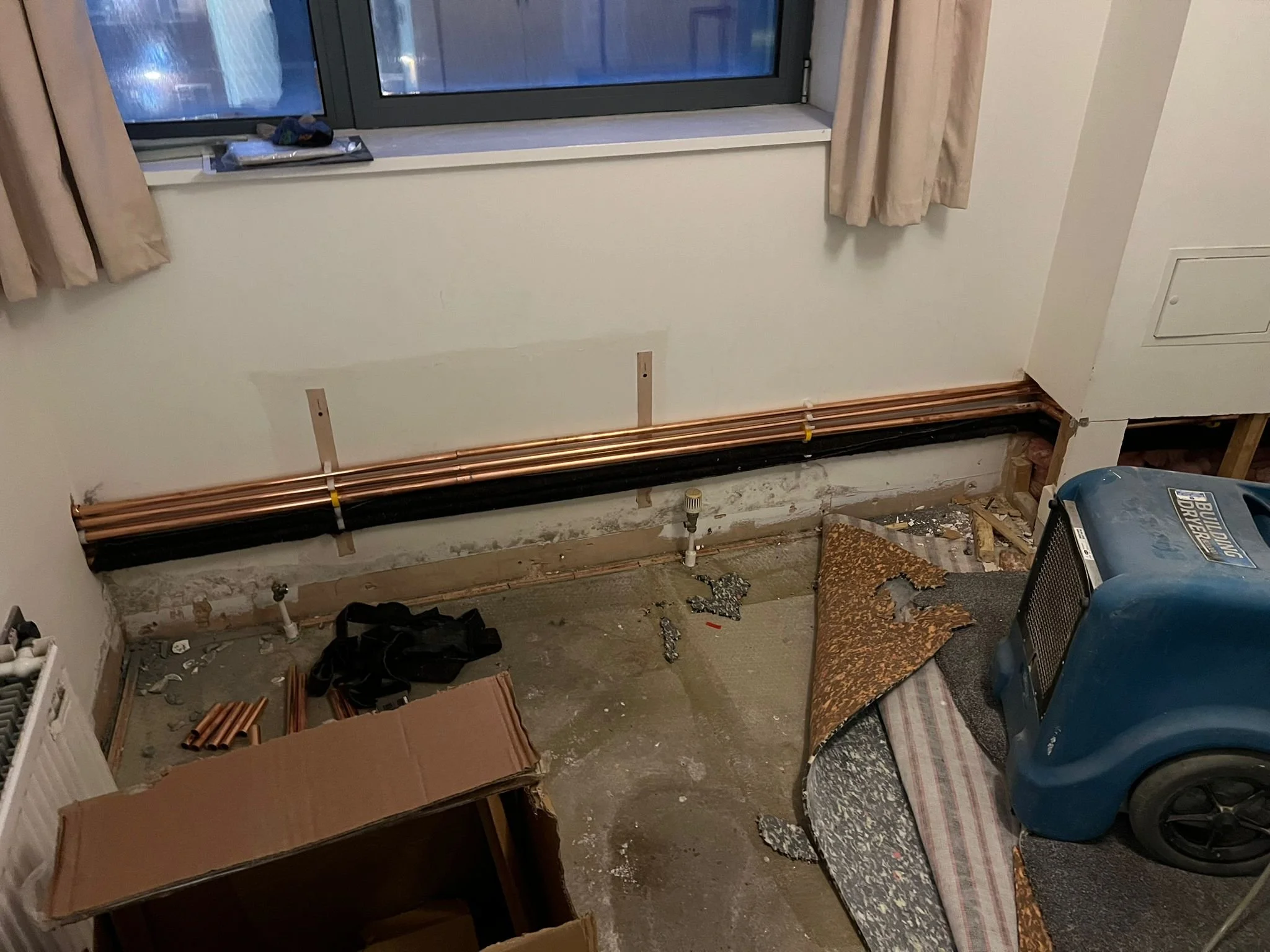

As a first step, we deployed a dehumidification system to stabilise the environment, followed by the decommissioning of the hot water cylinder and existing boiler.

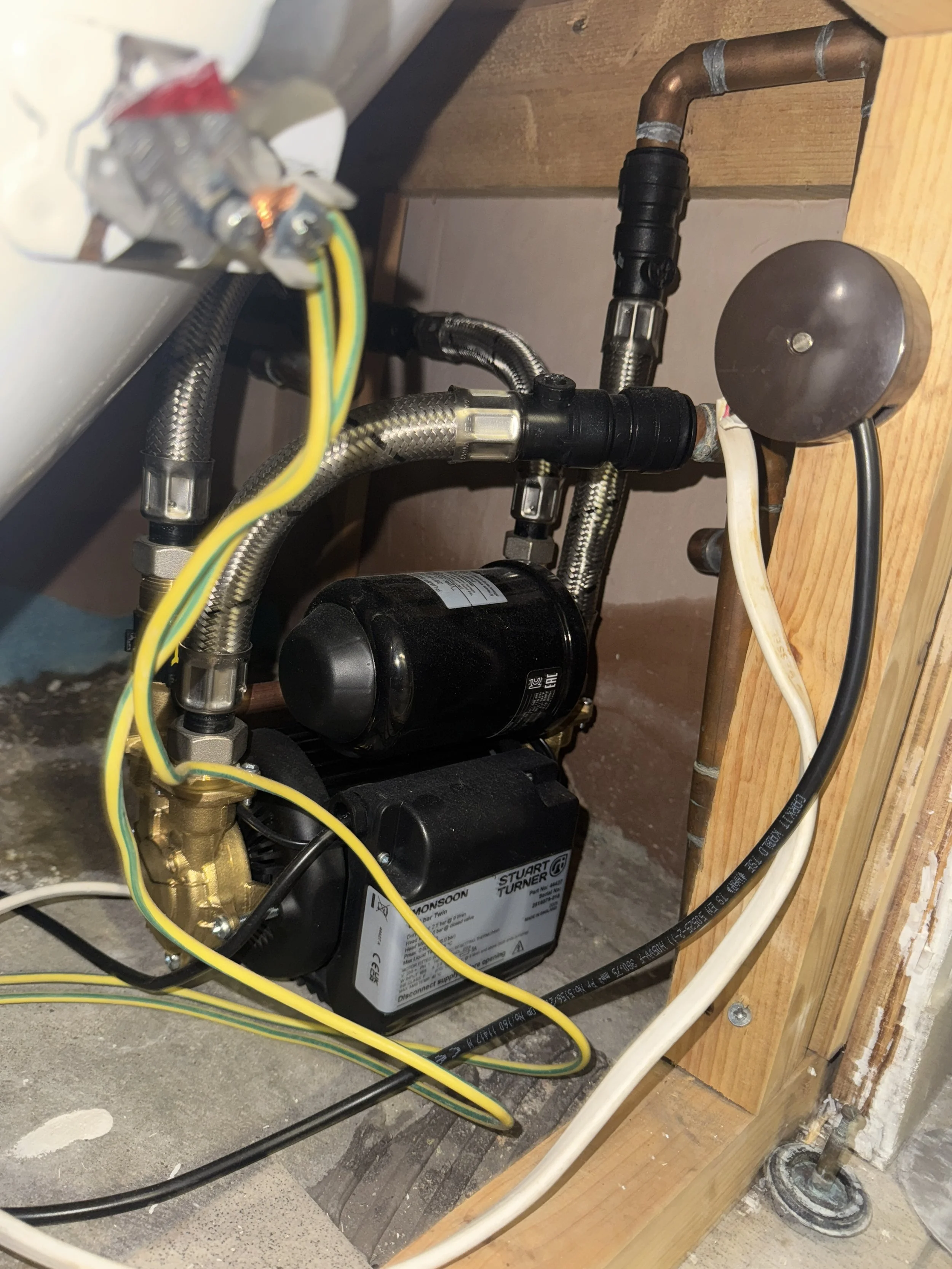

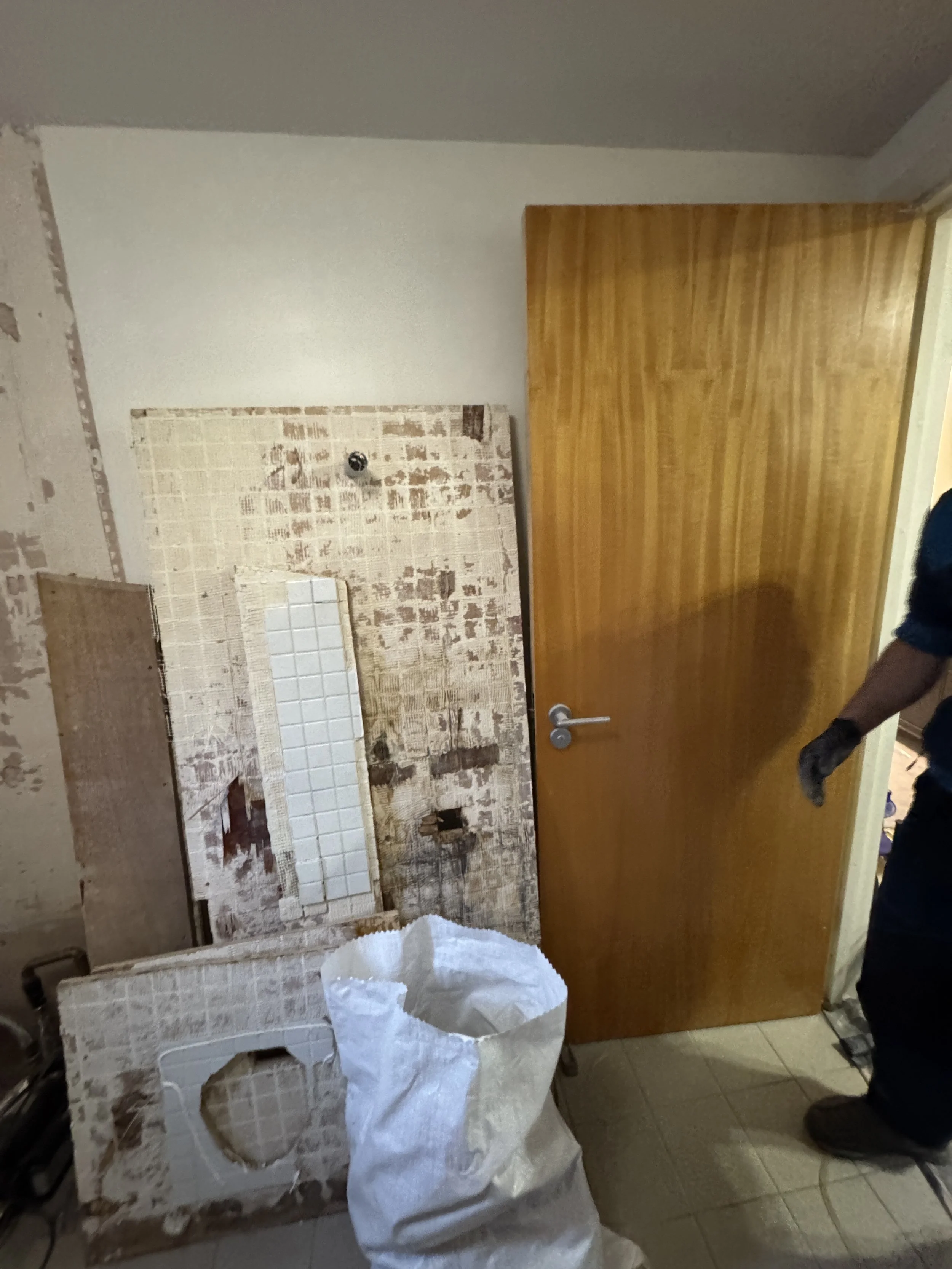

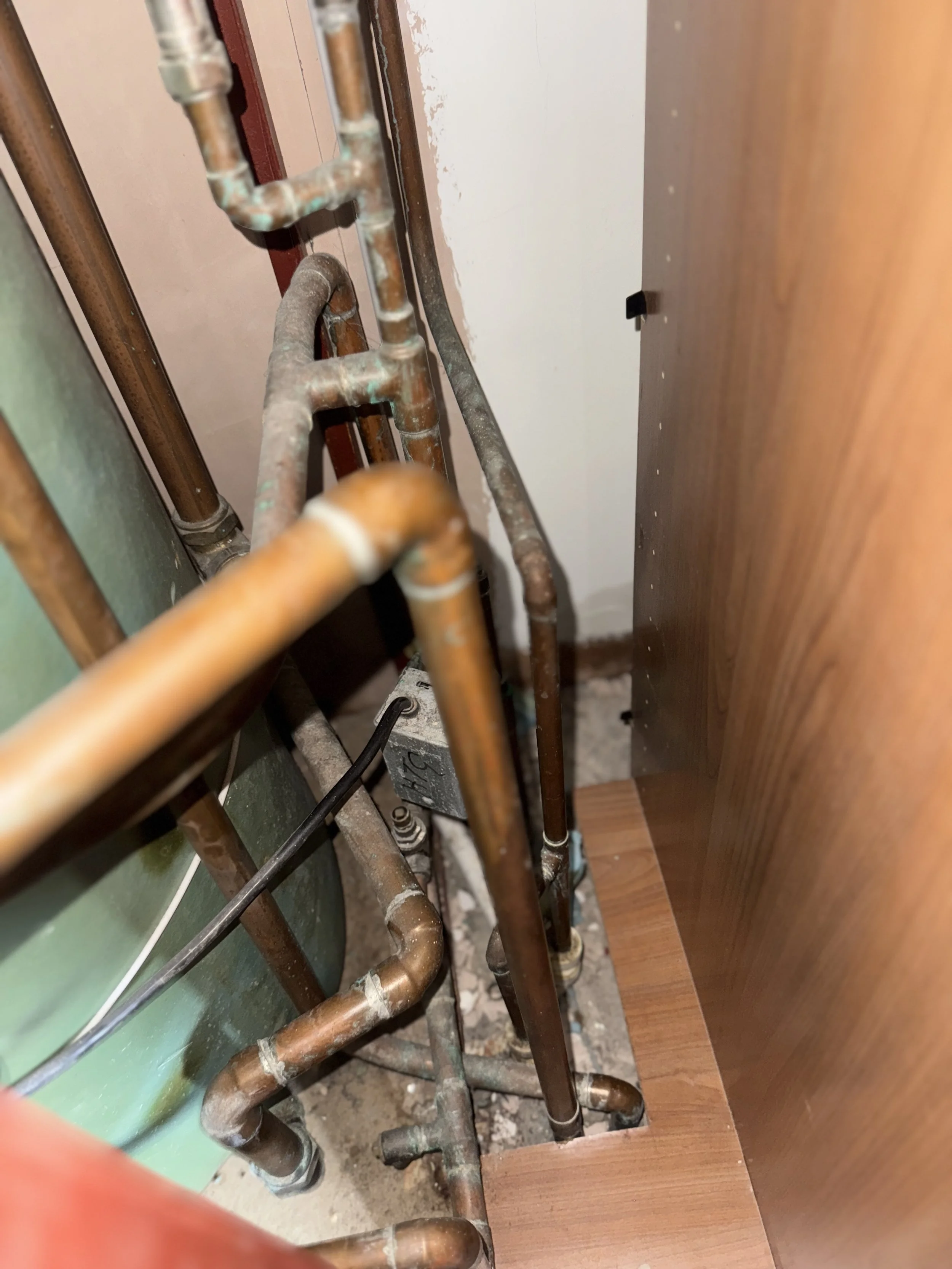

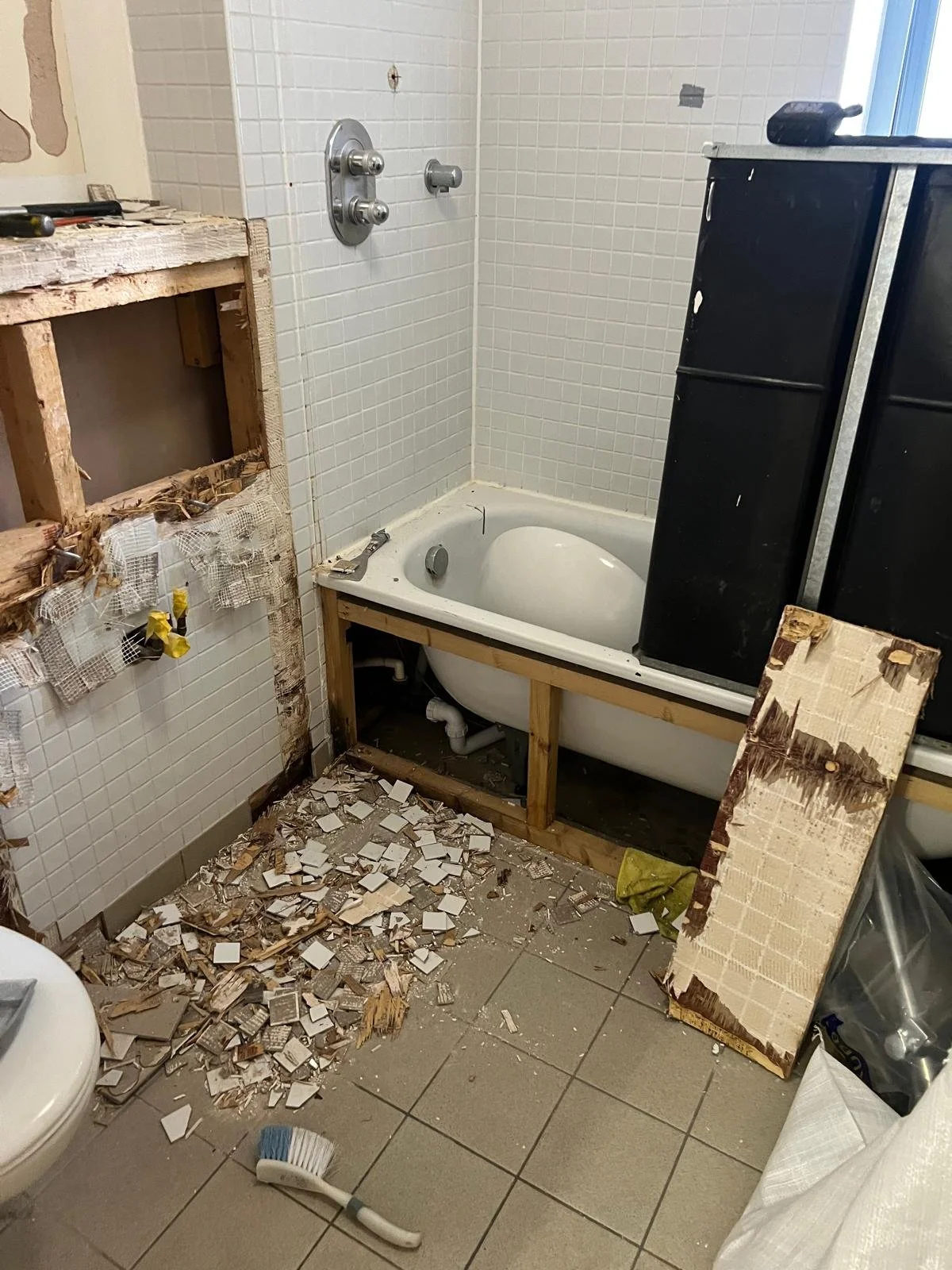

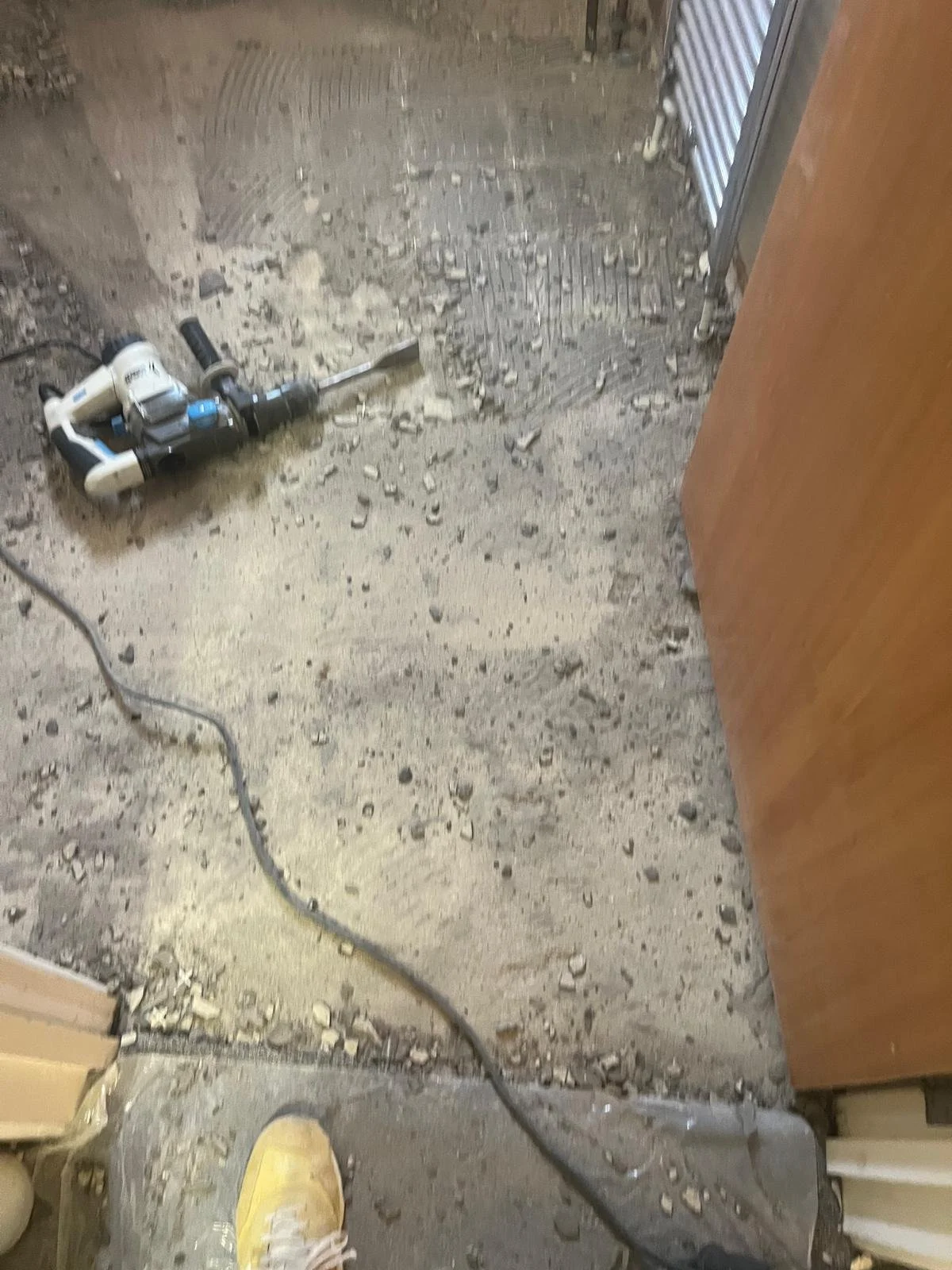

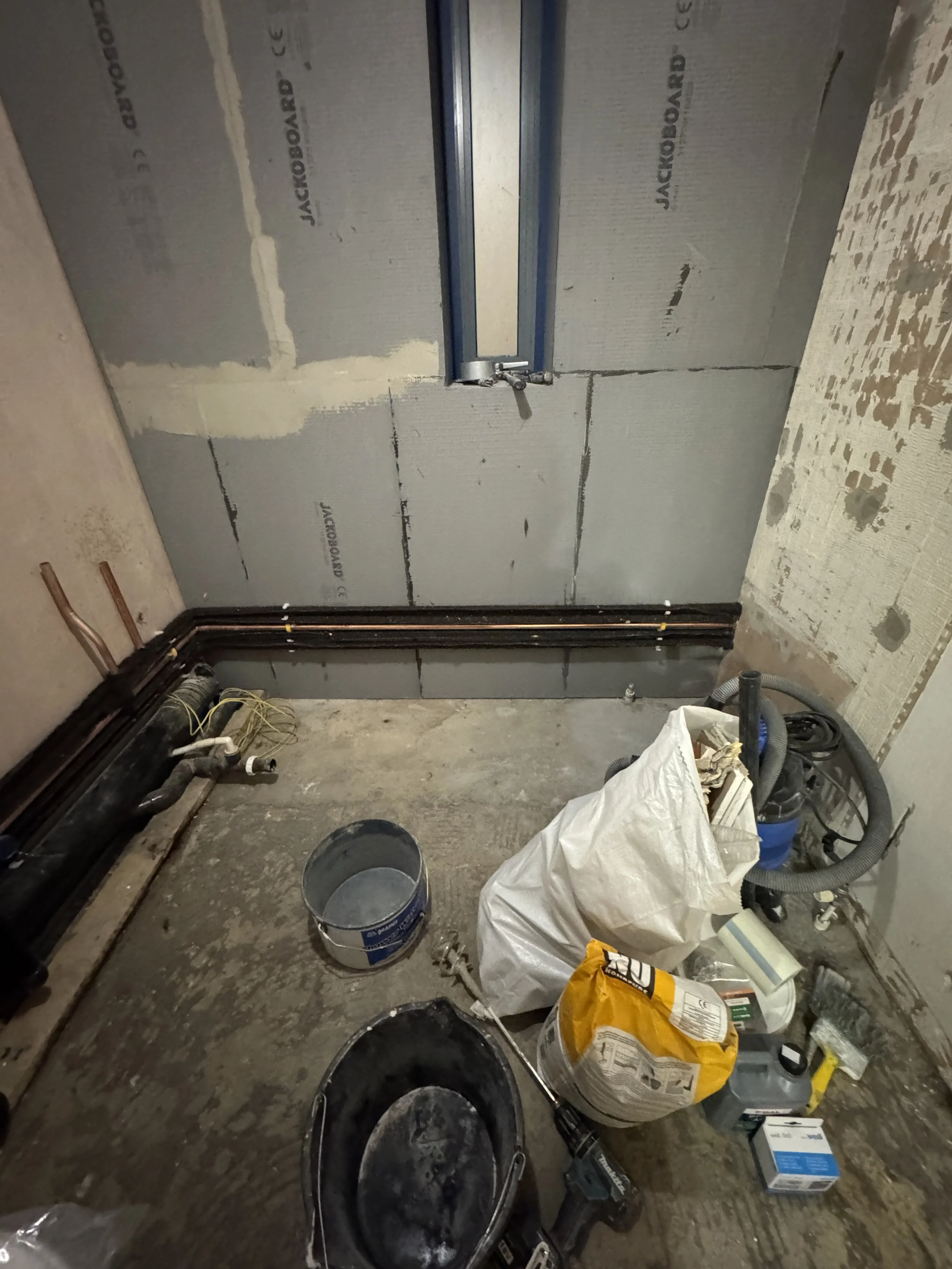

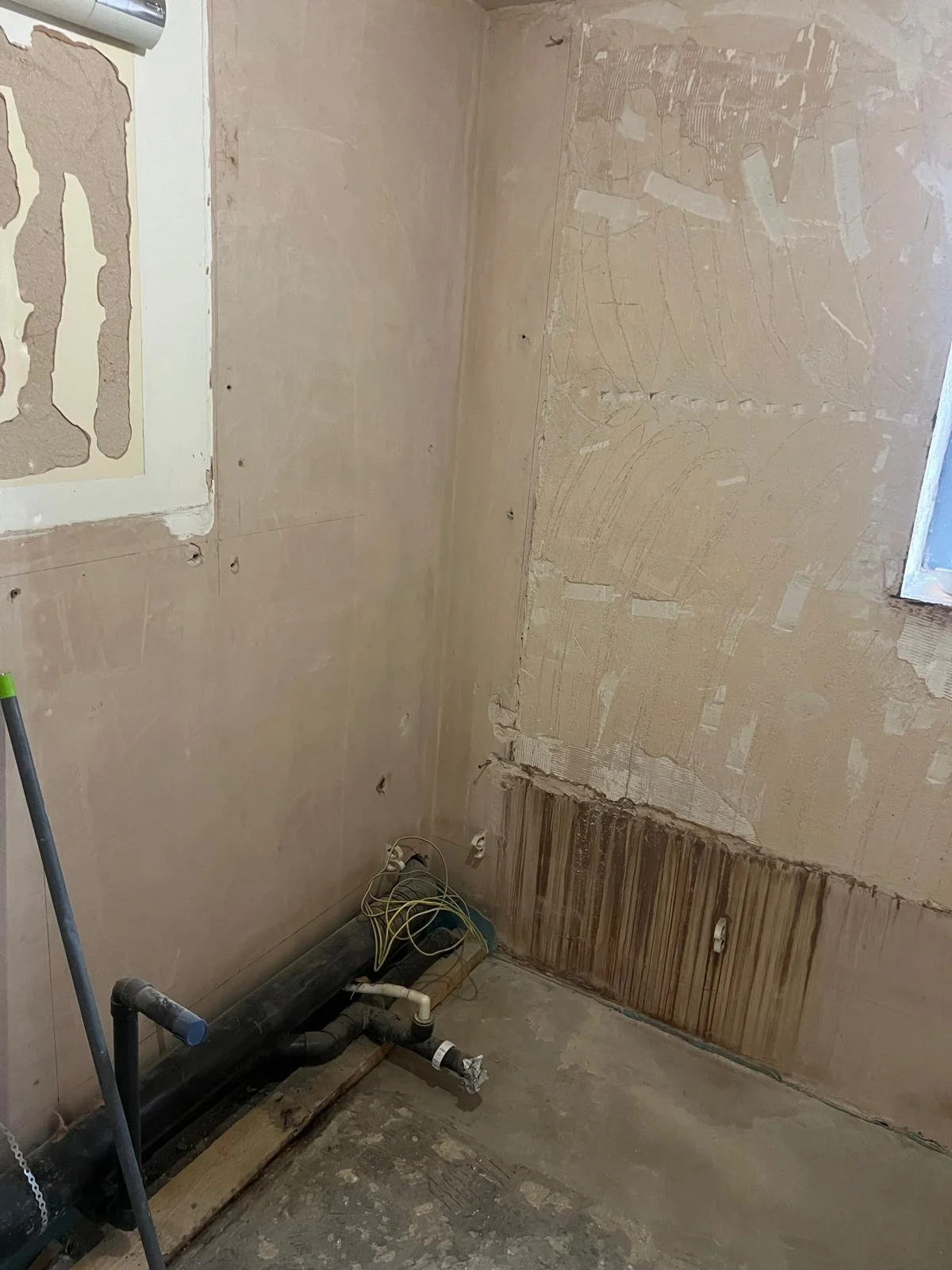

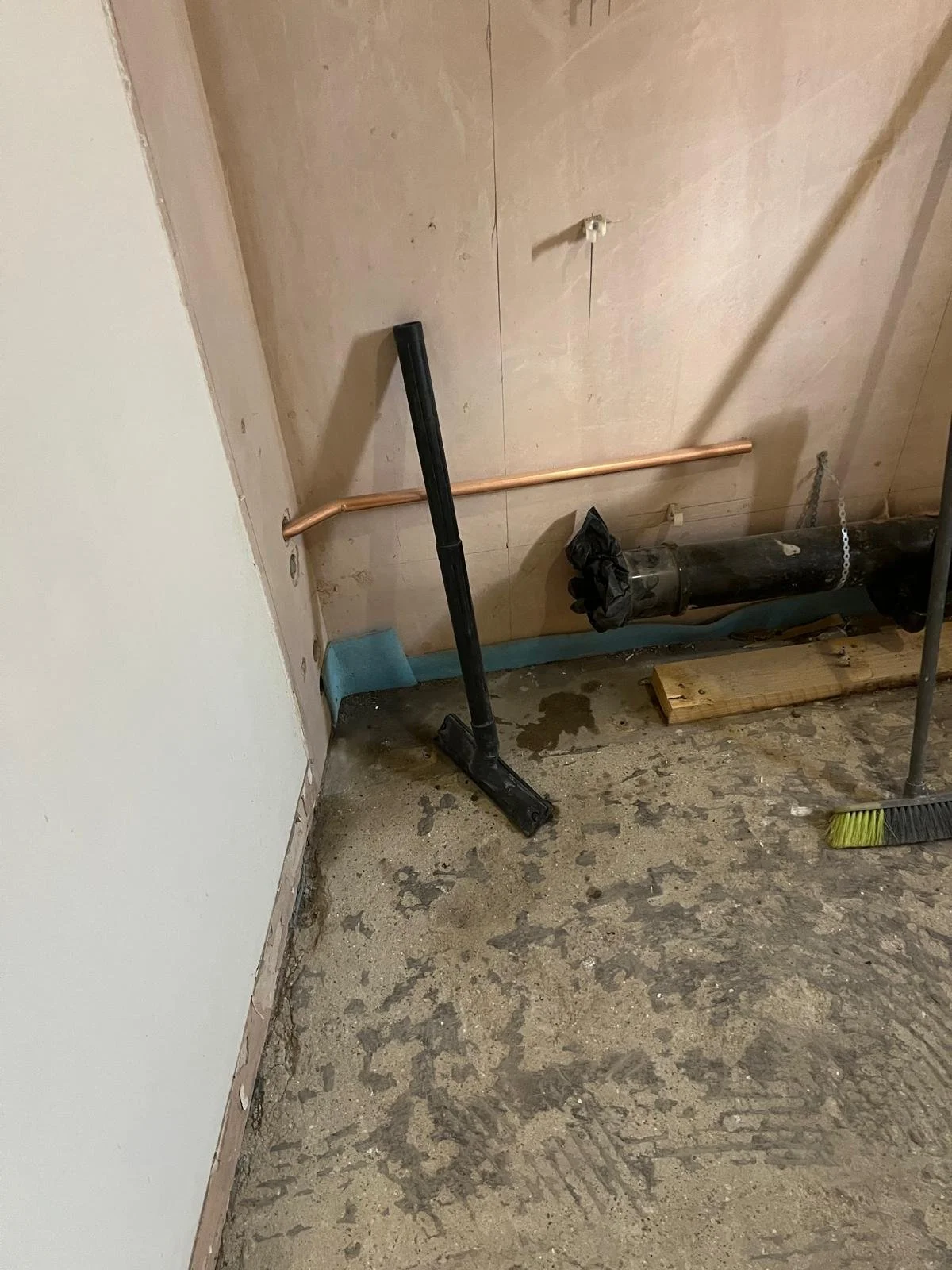

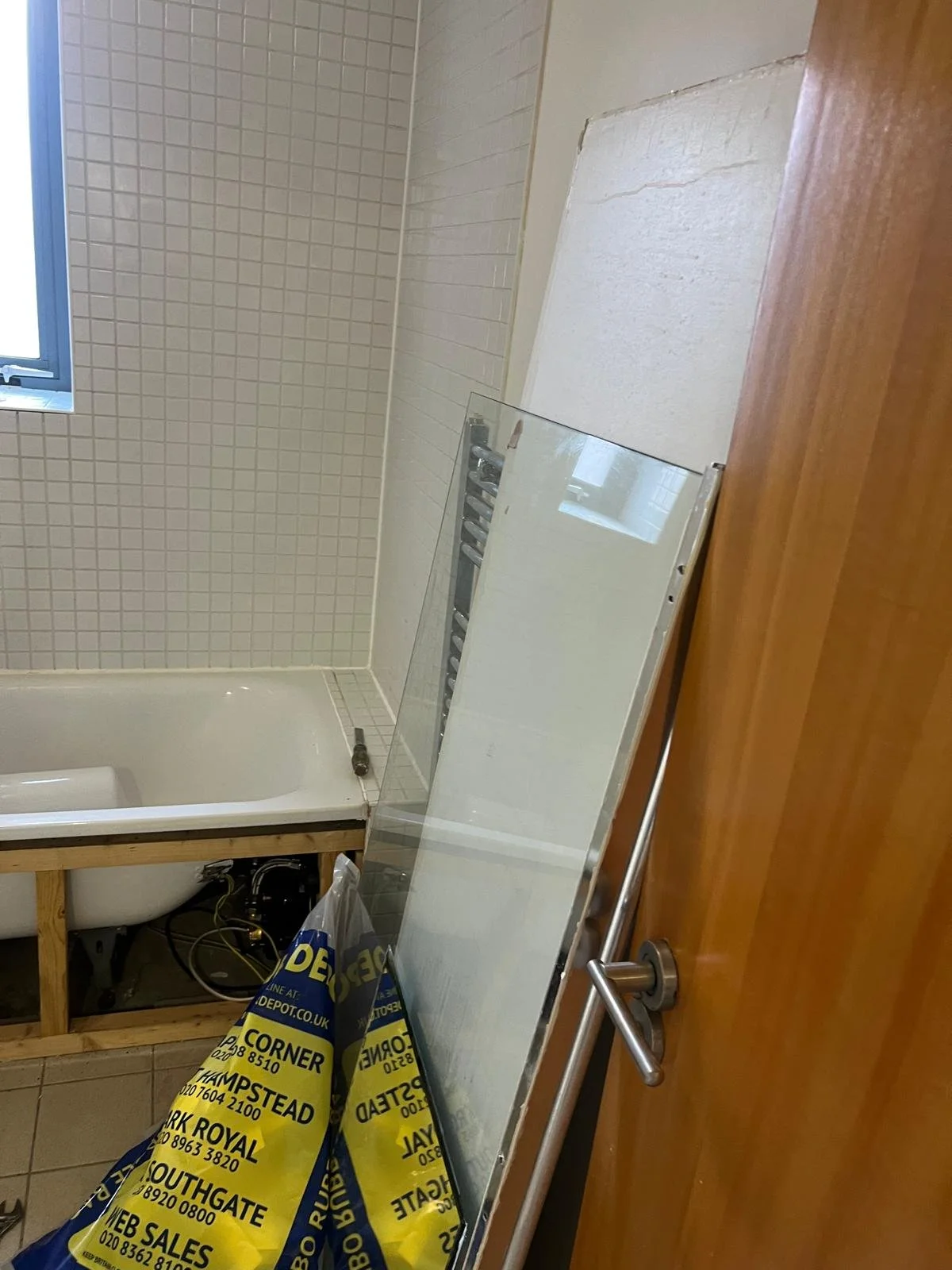

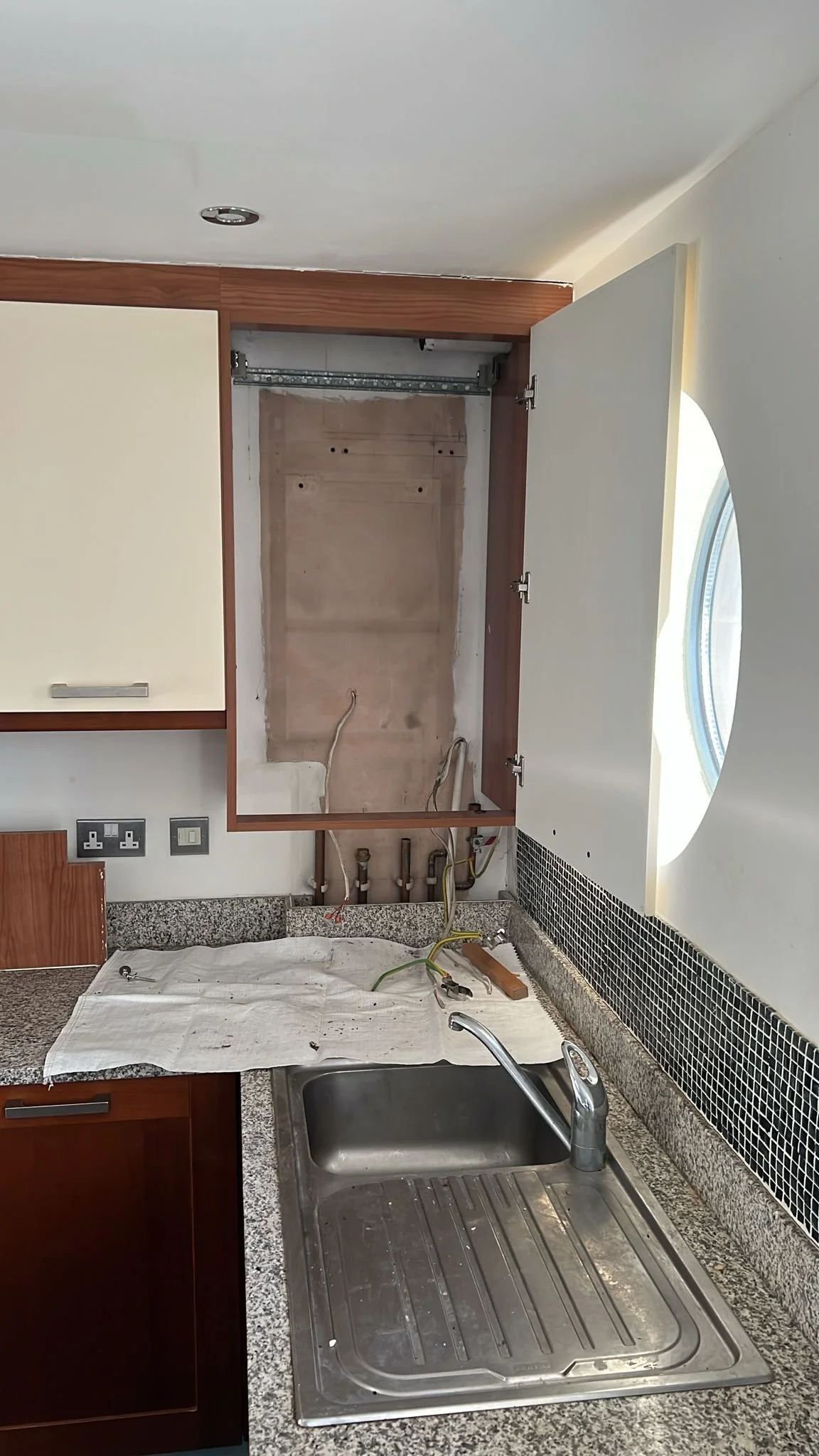

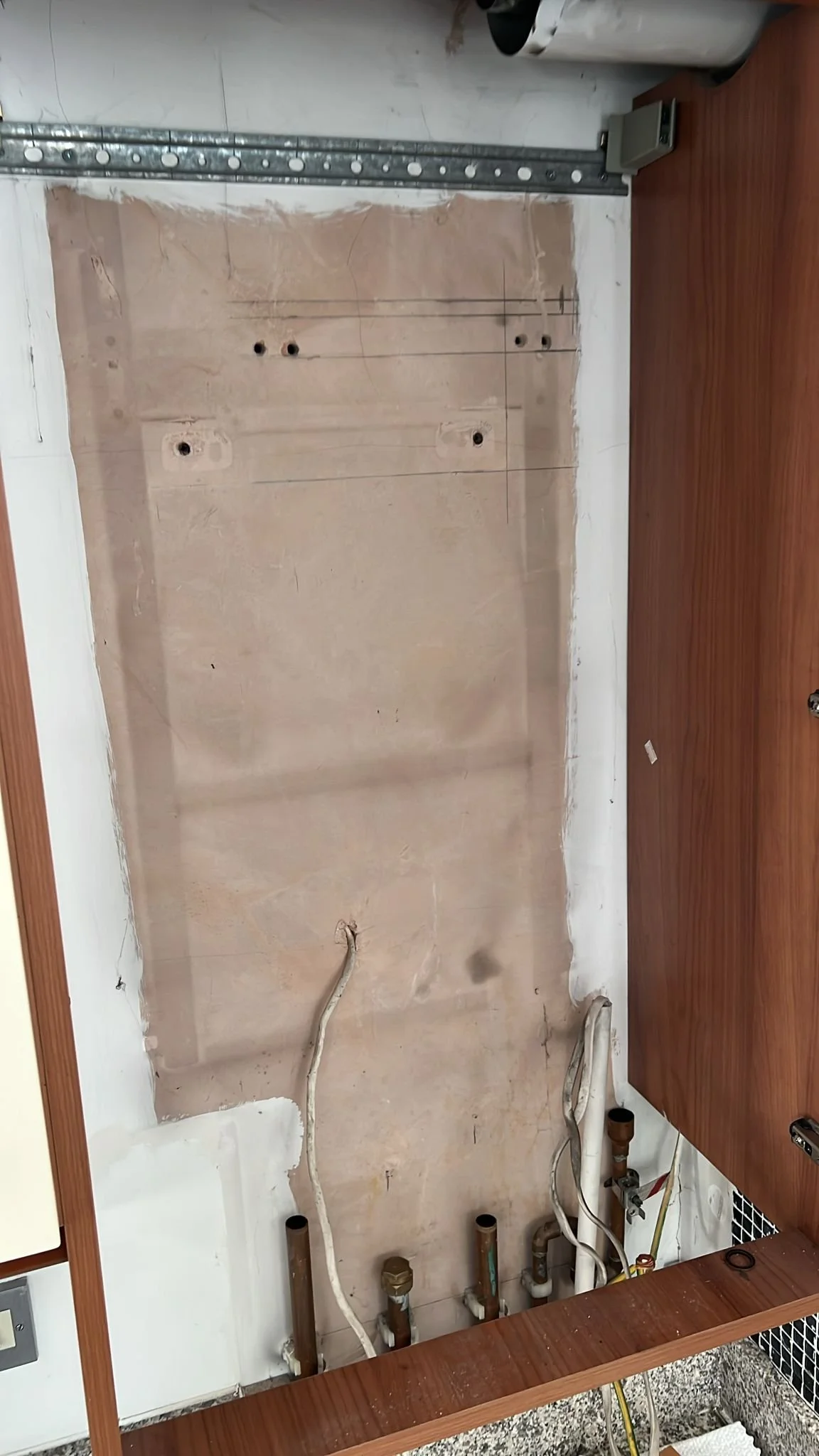

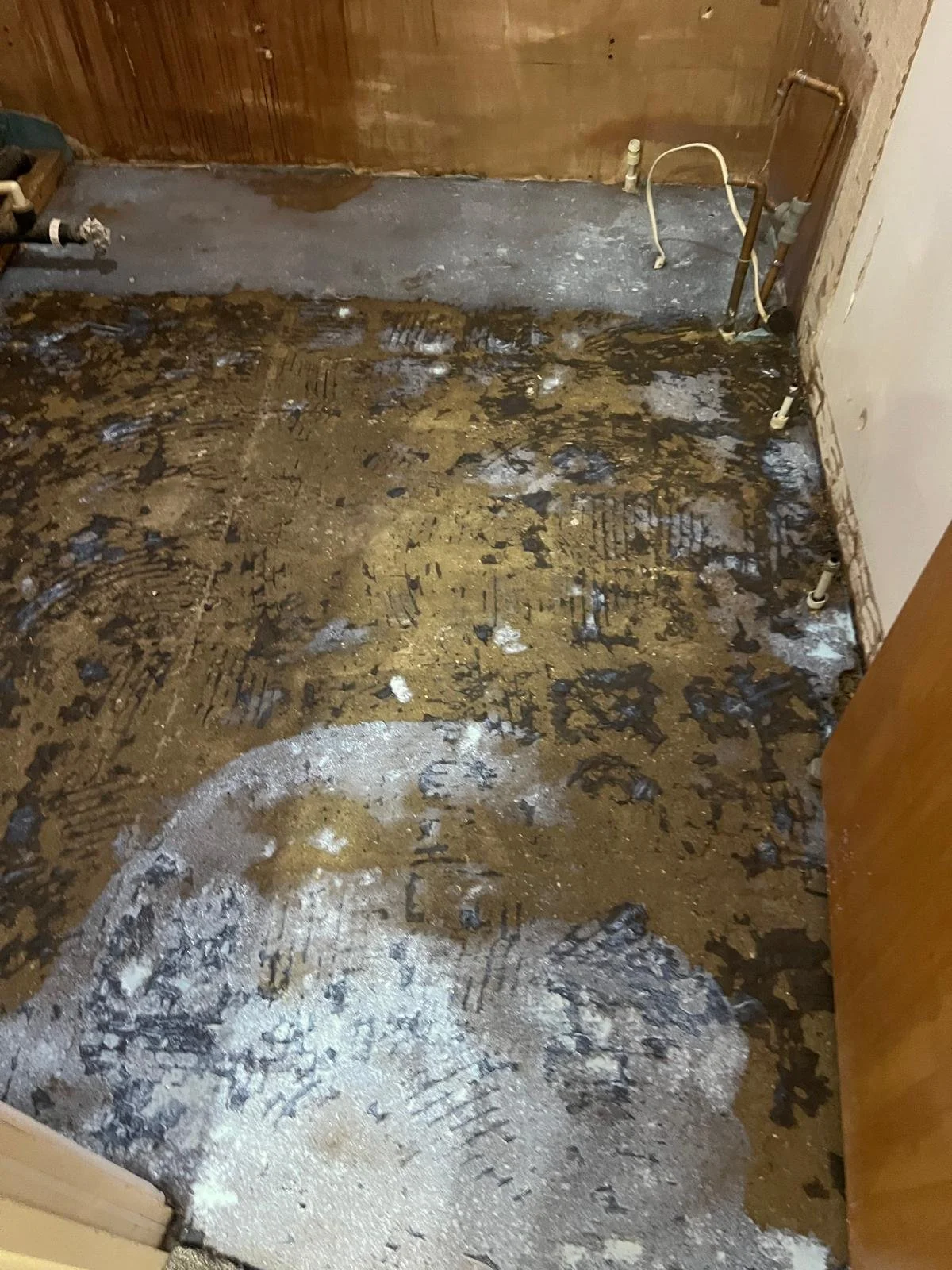

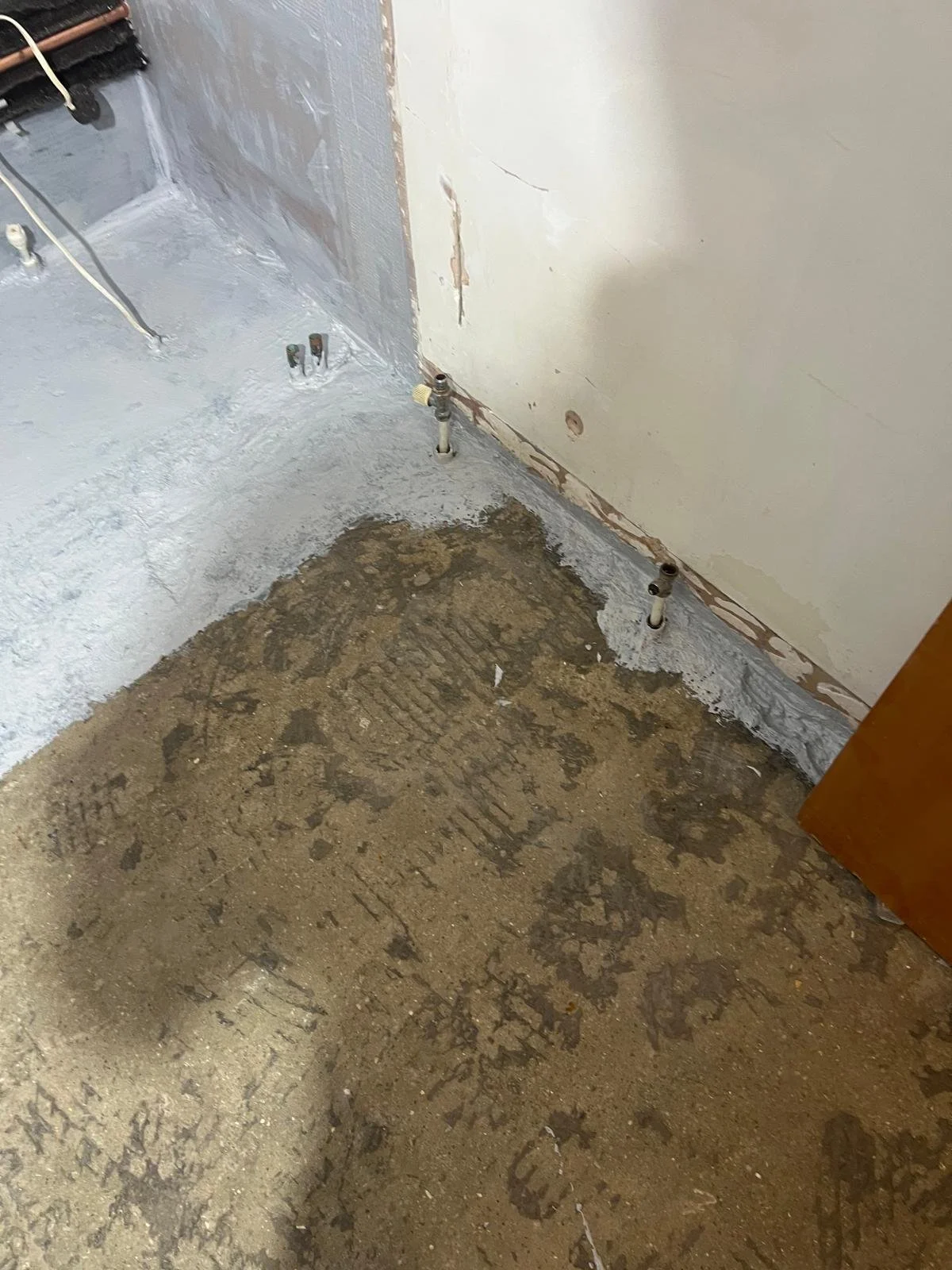

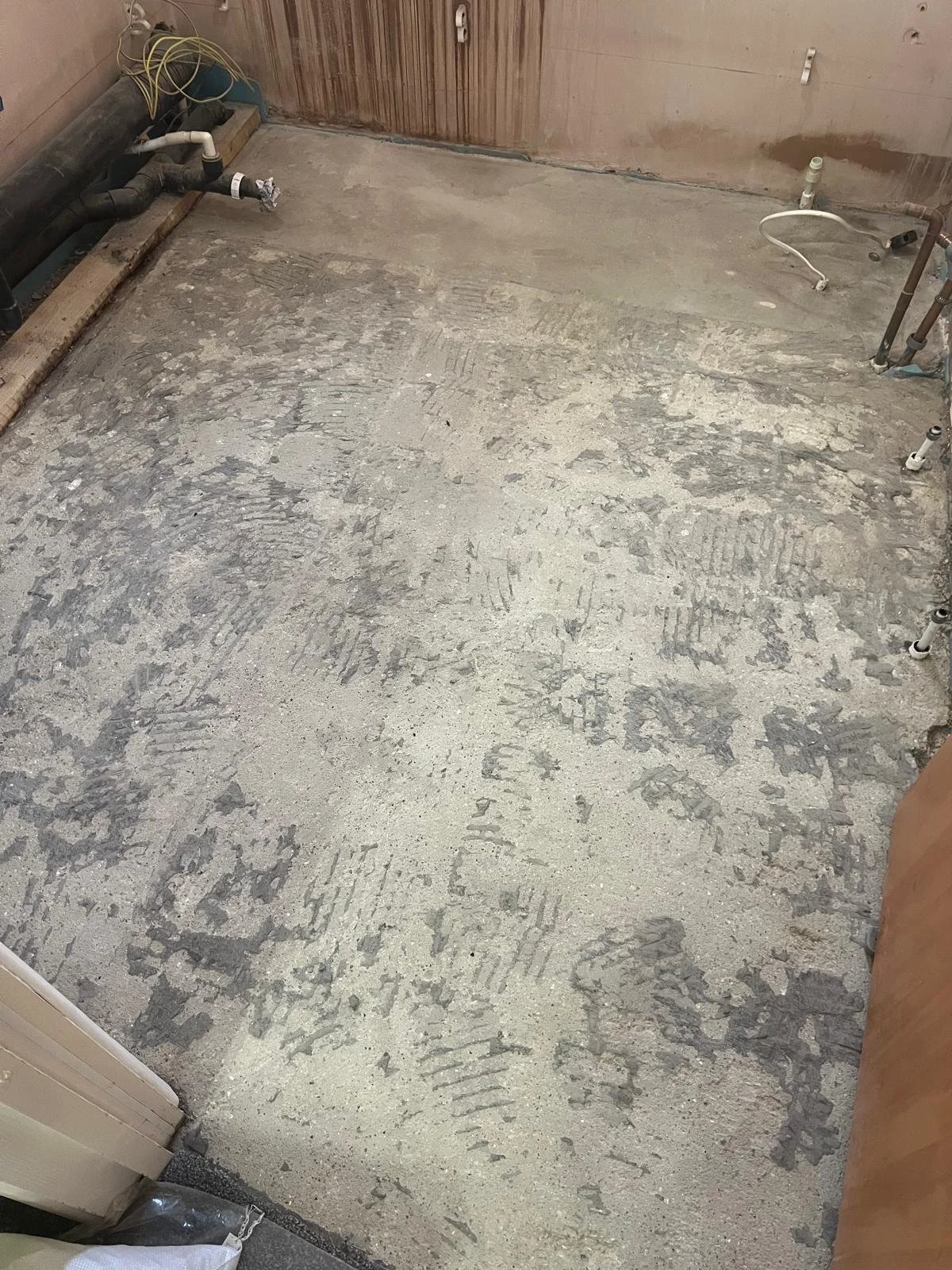

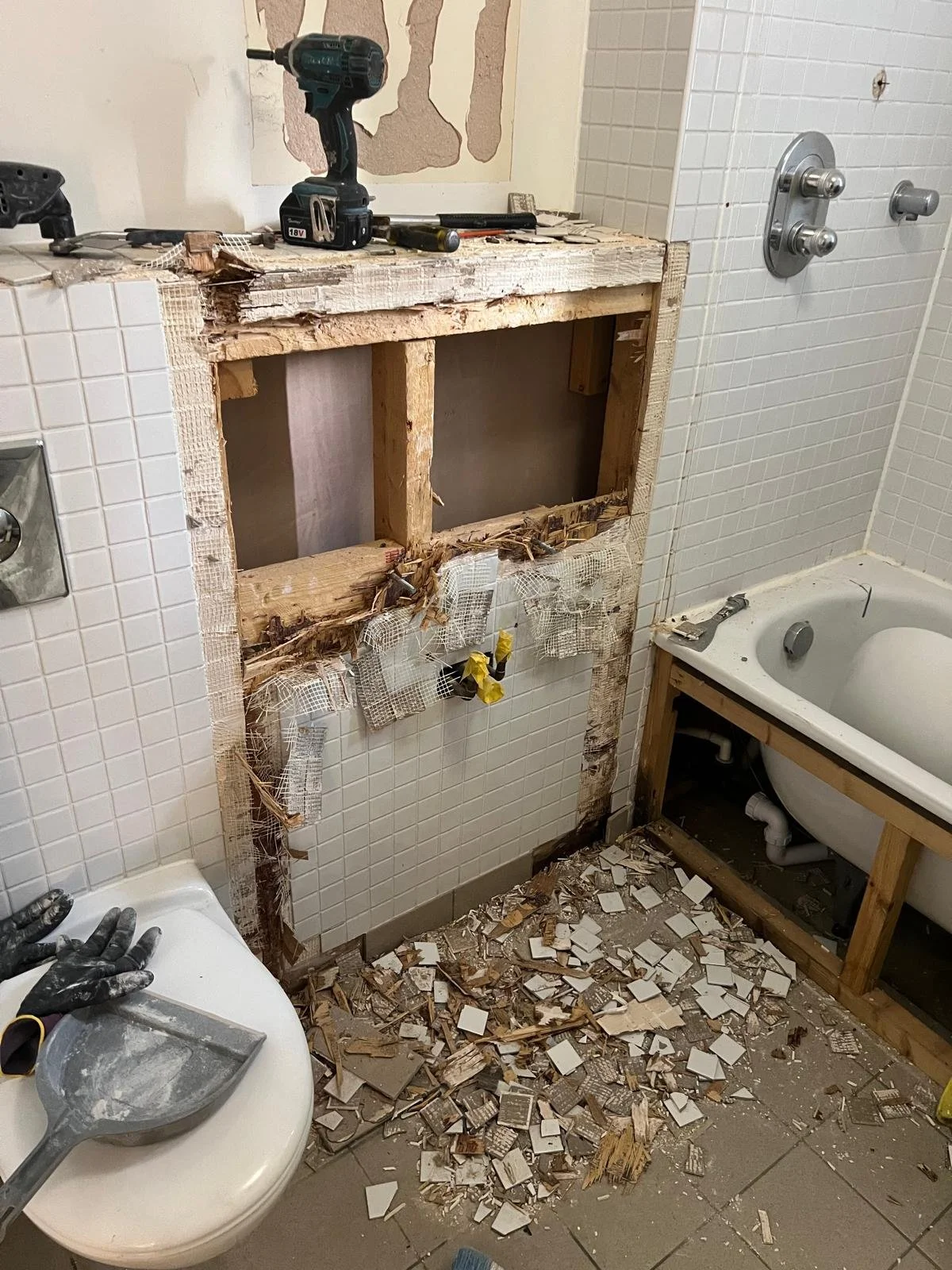

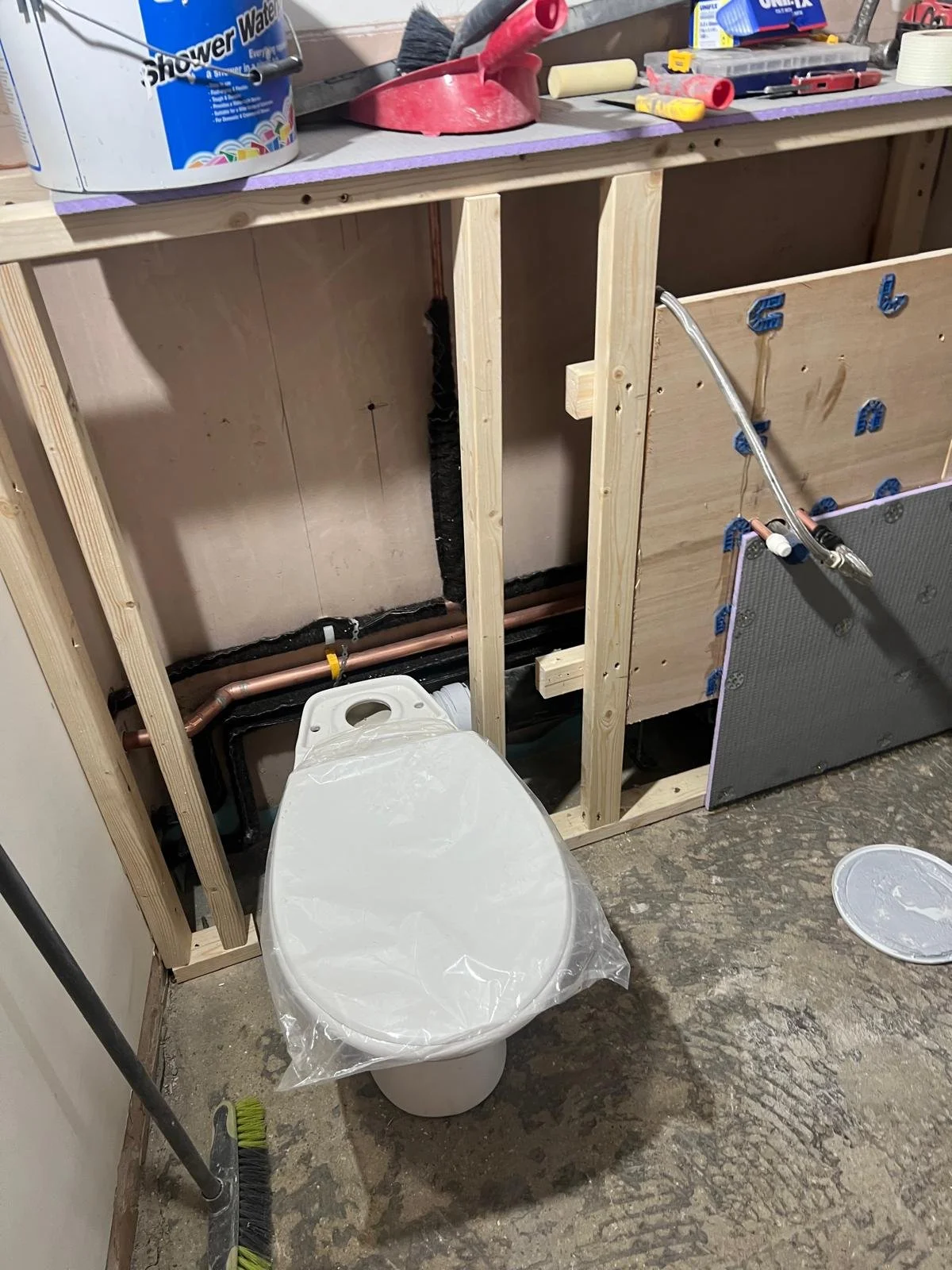

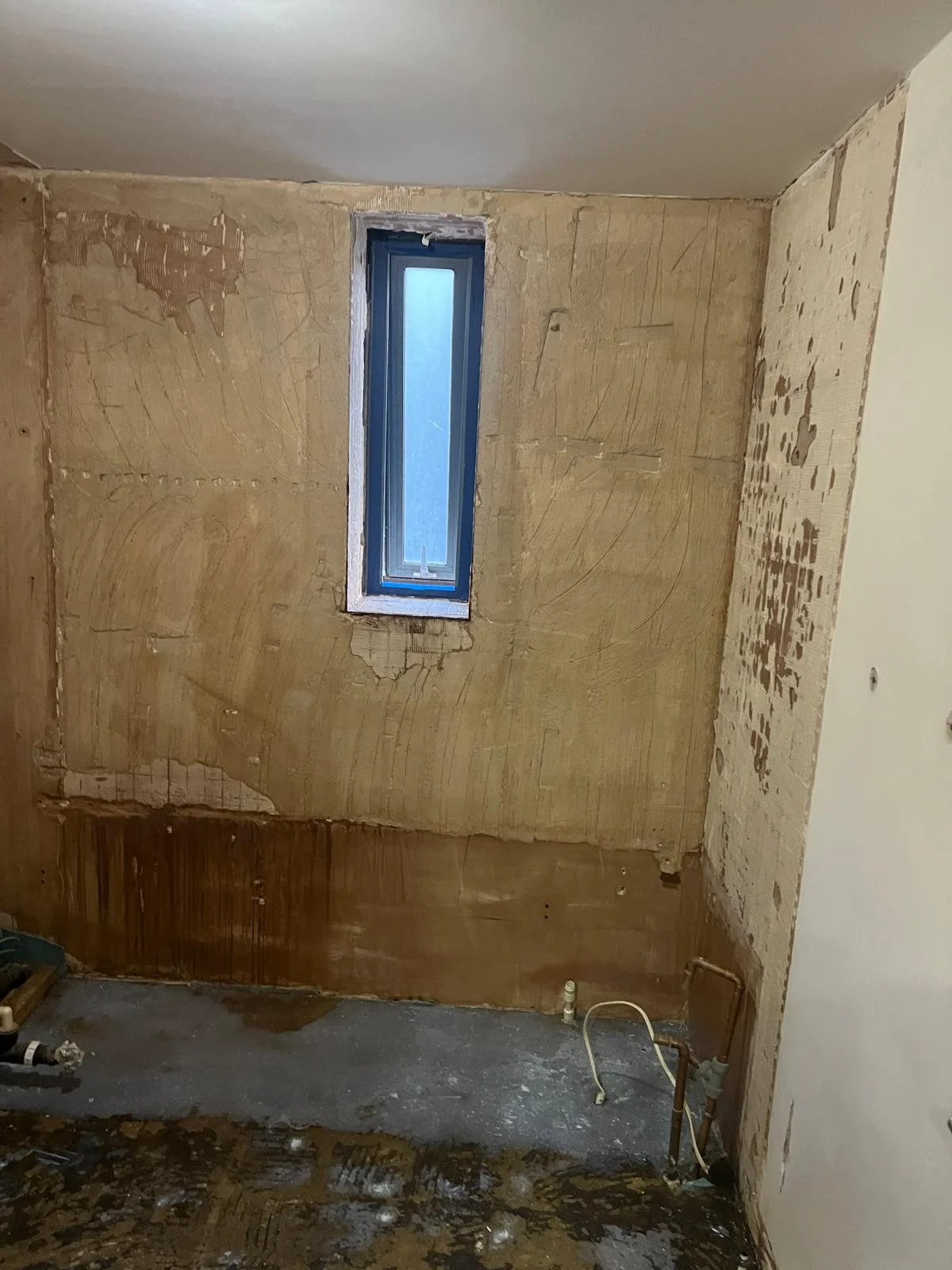

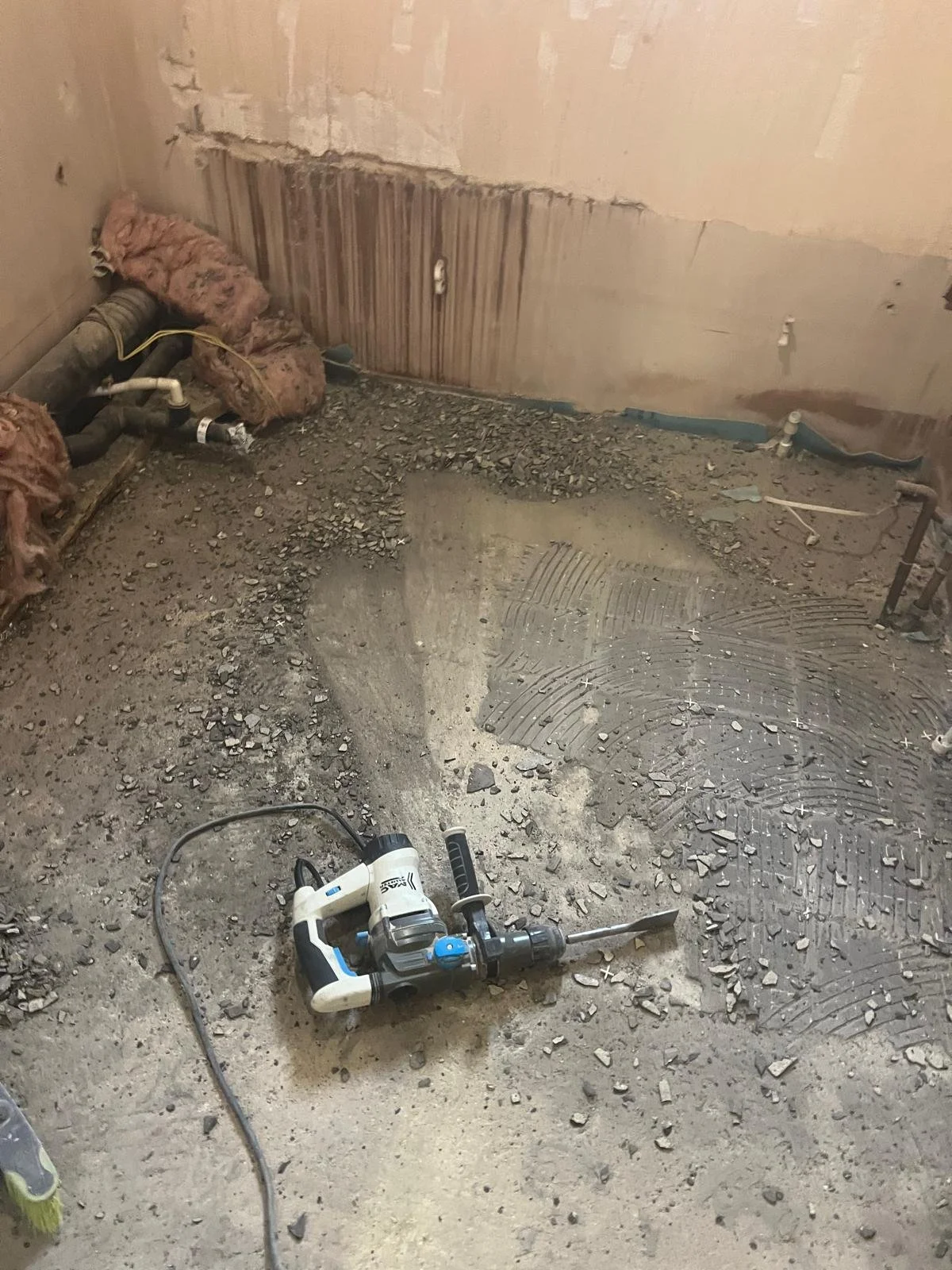

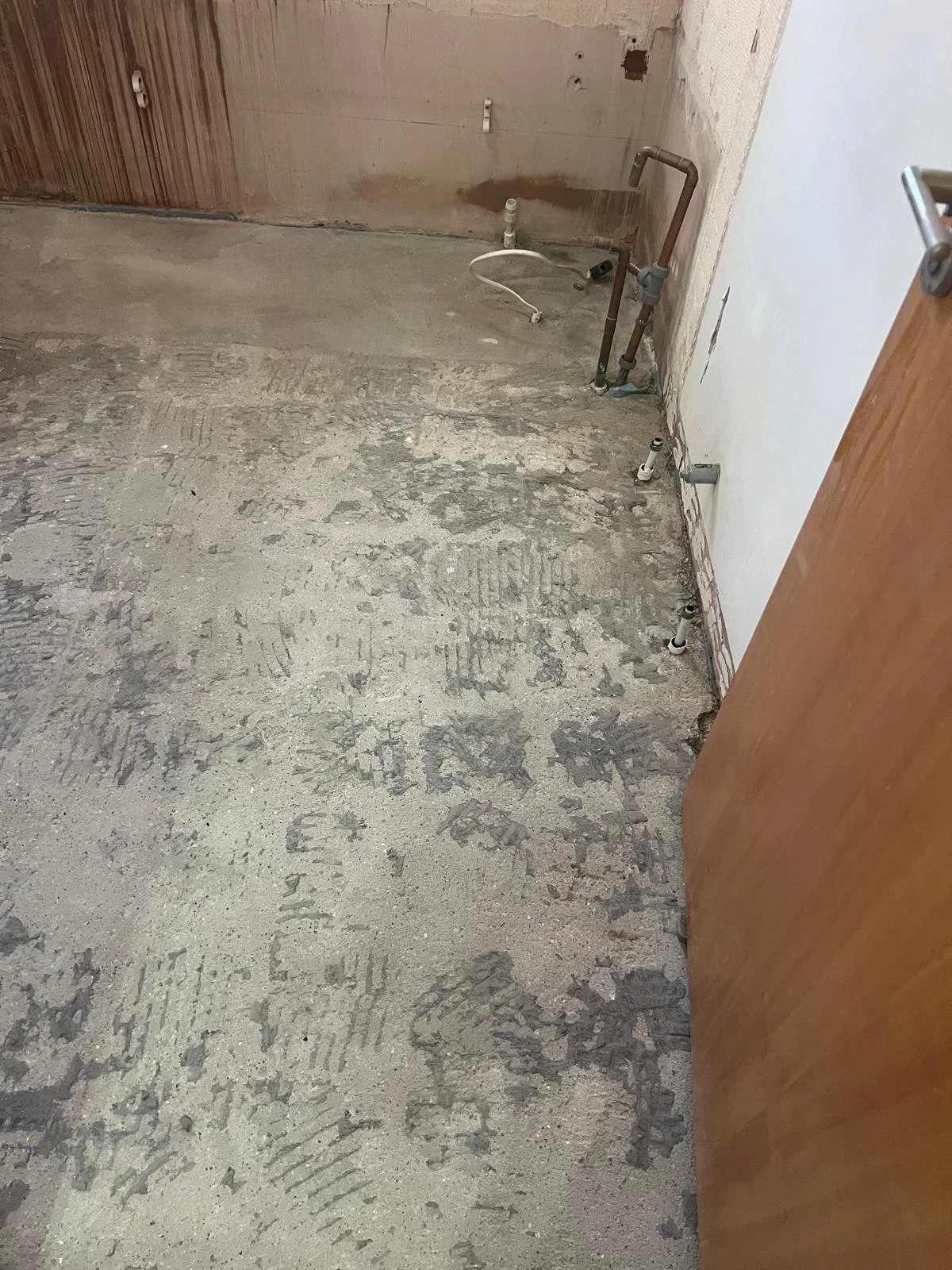

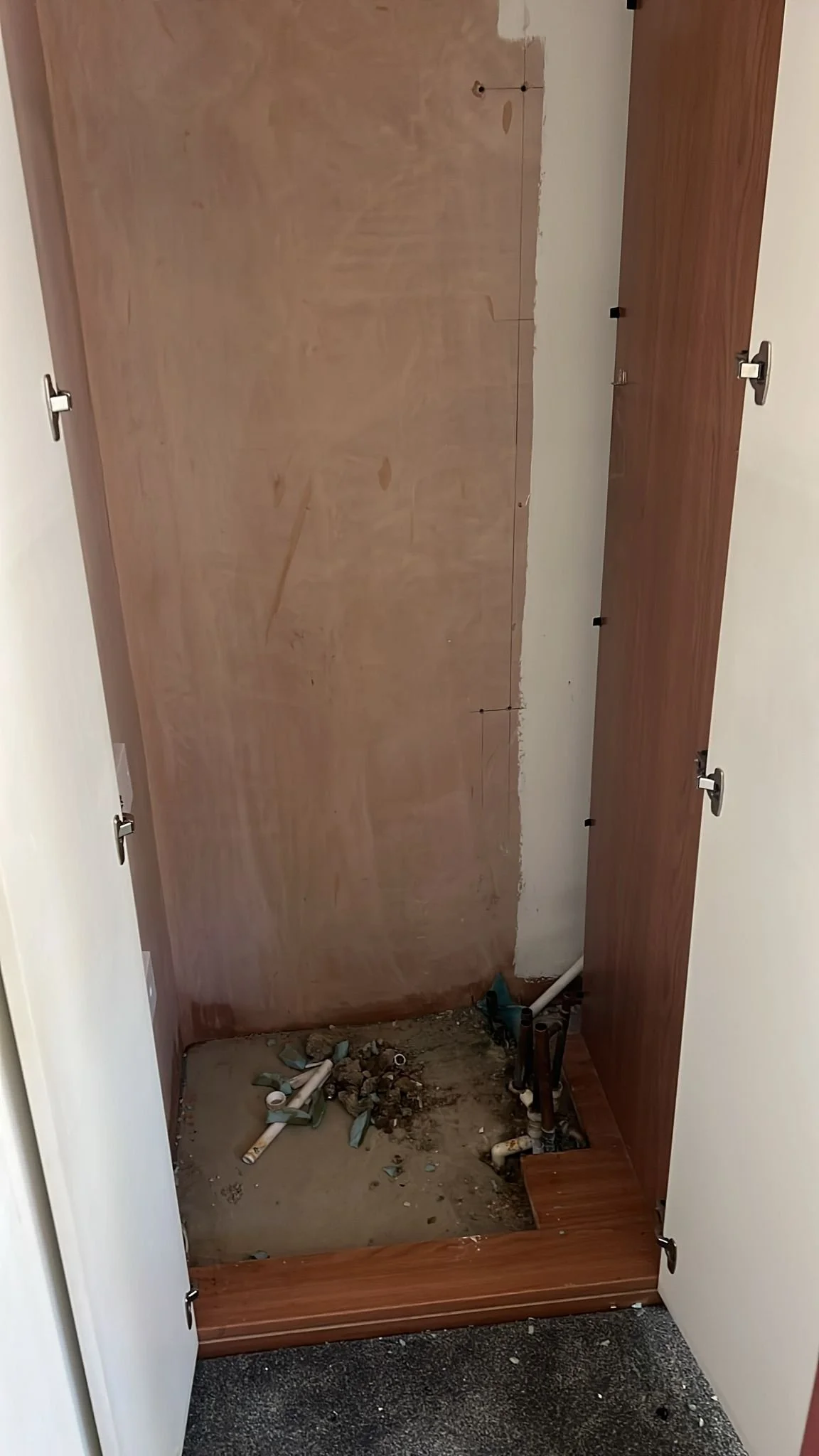

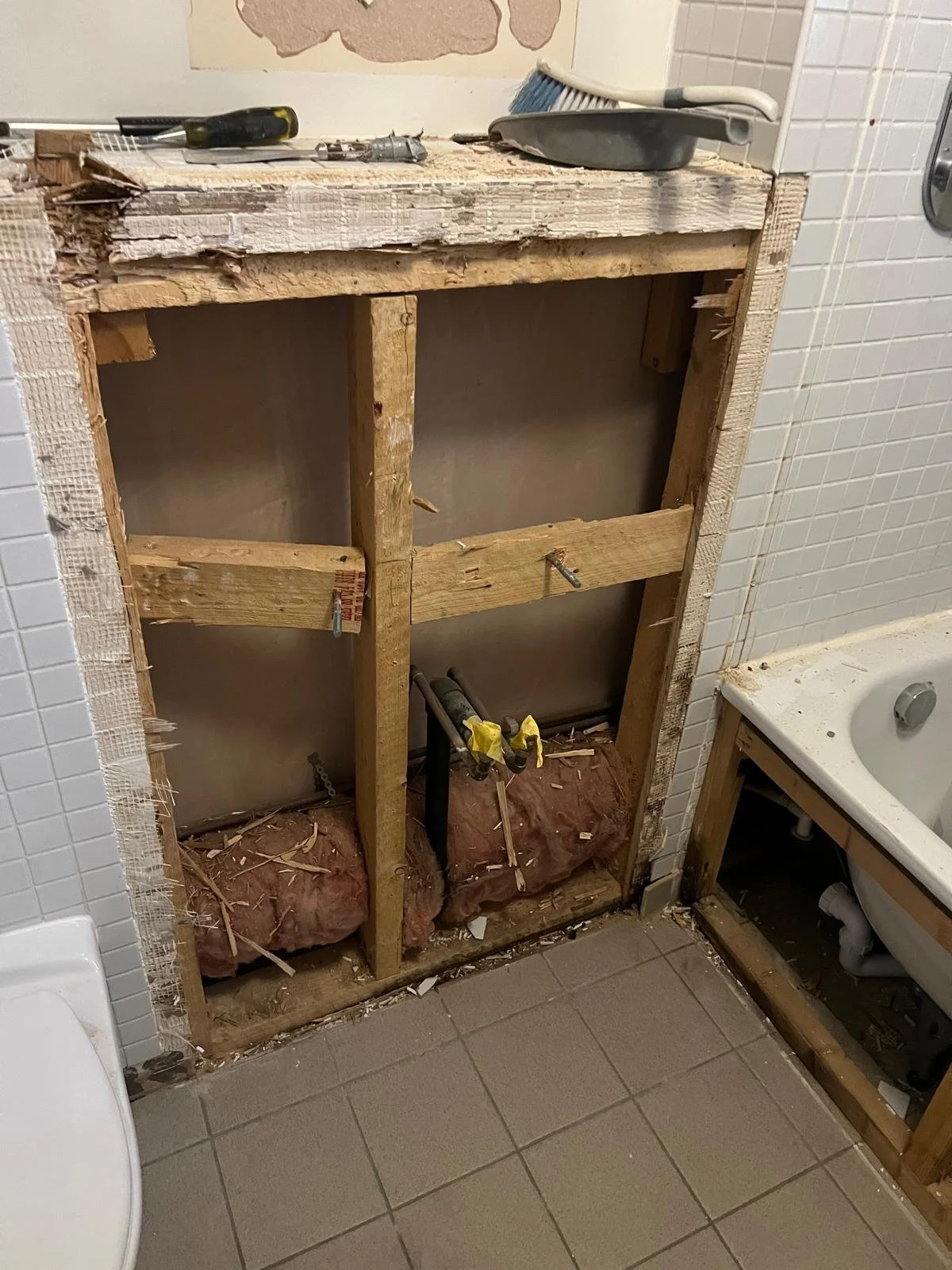

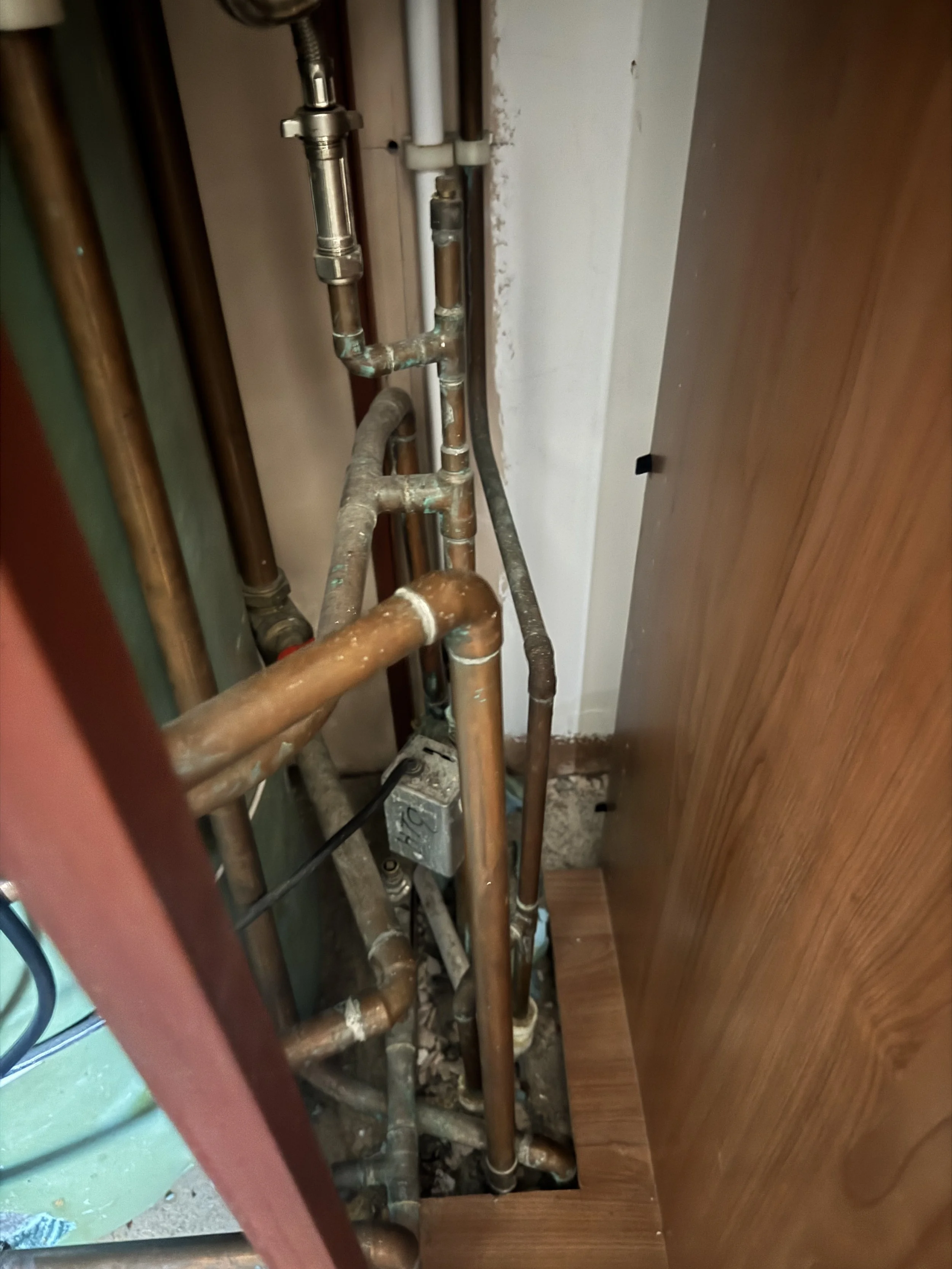

Once the system was safely isolated, all fixtures and finishes were removed to expose the concealed installation and allow full access to the pipework.

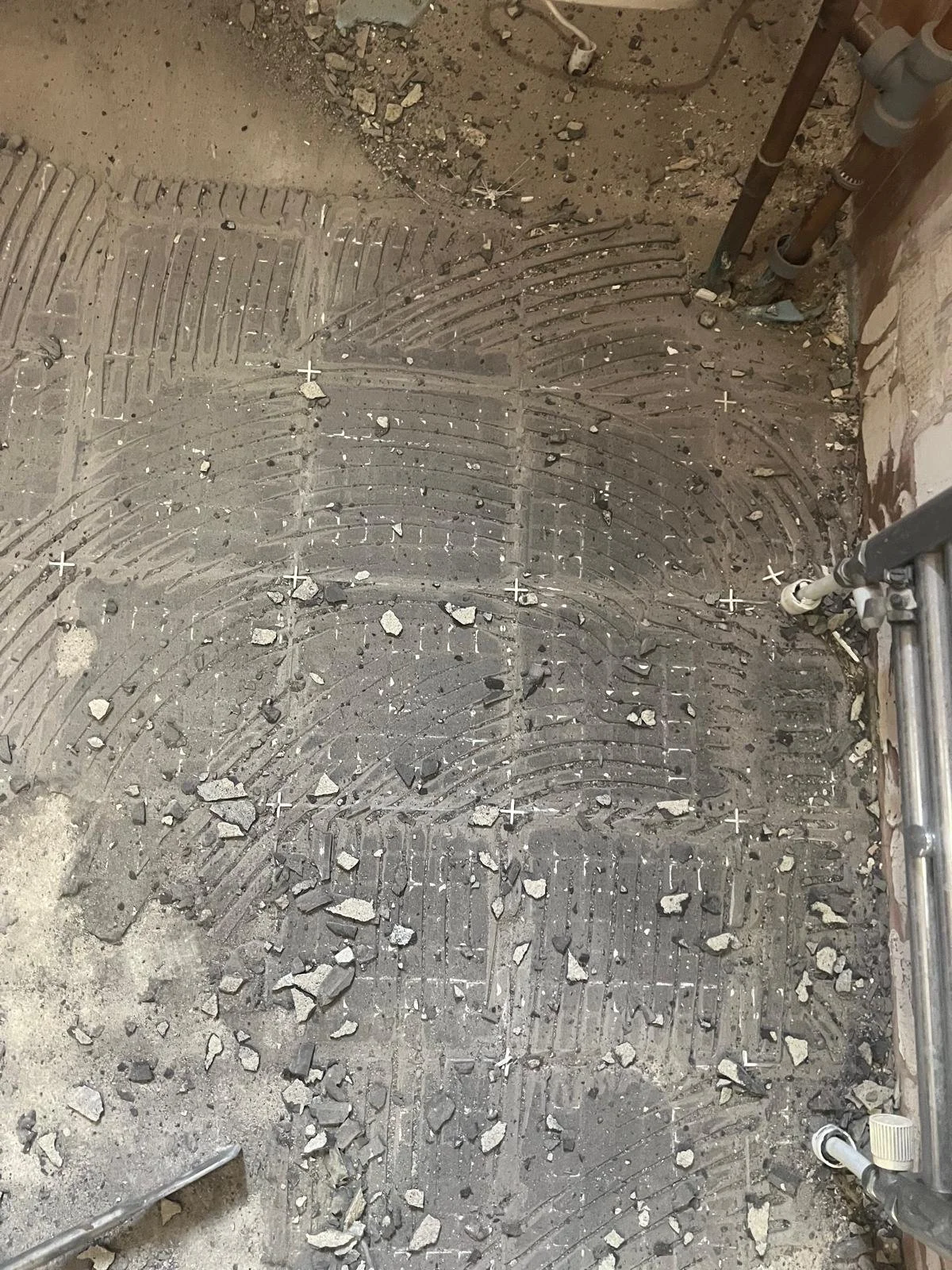

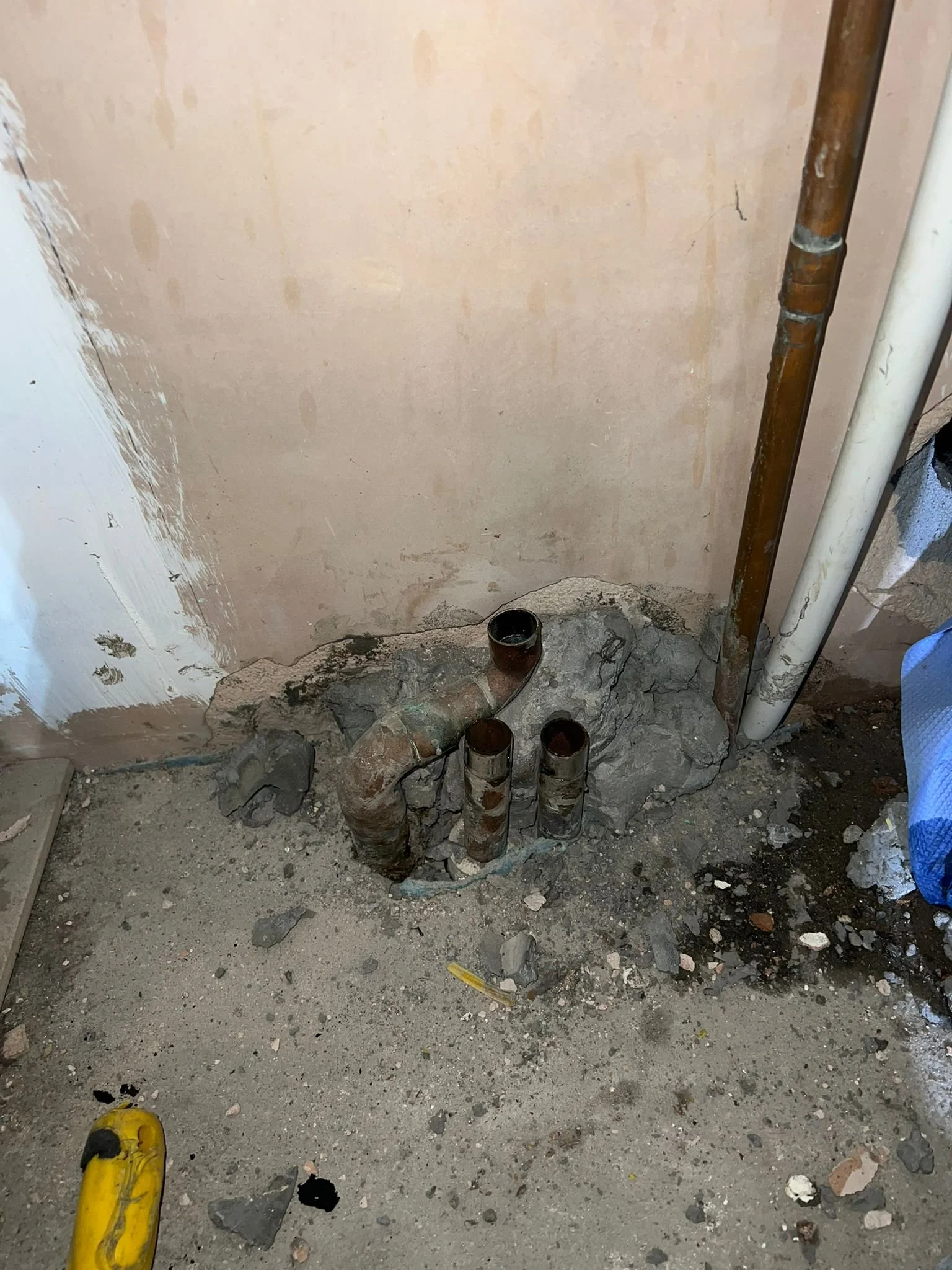

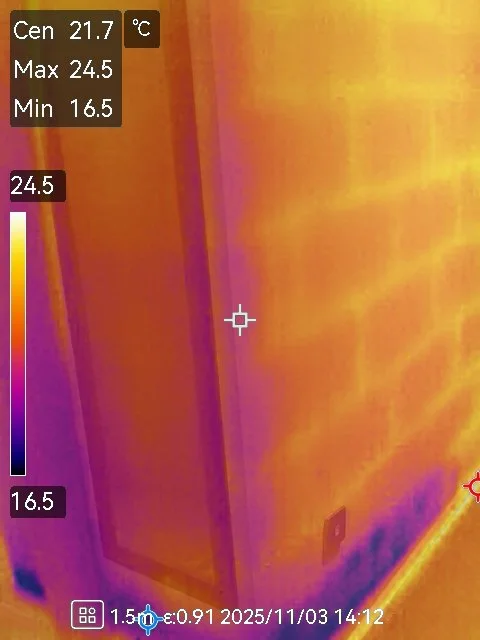

This stage revealed the true extent of the system failure.

Plumbing System Upgrade

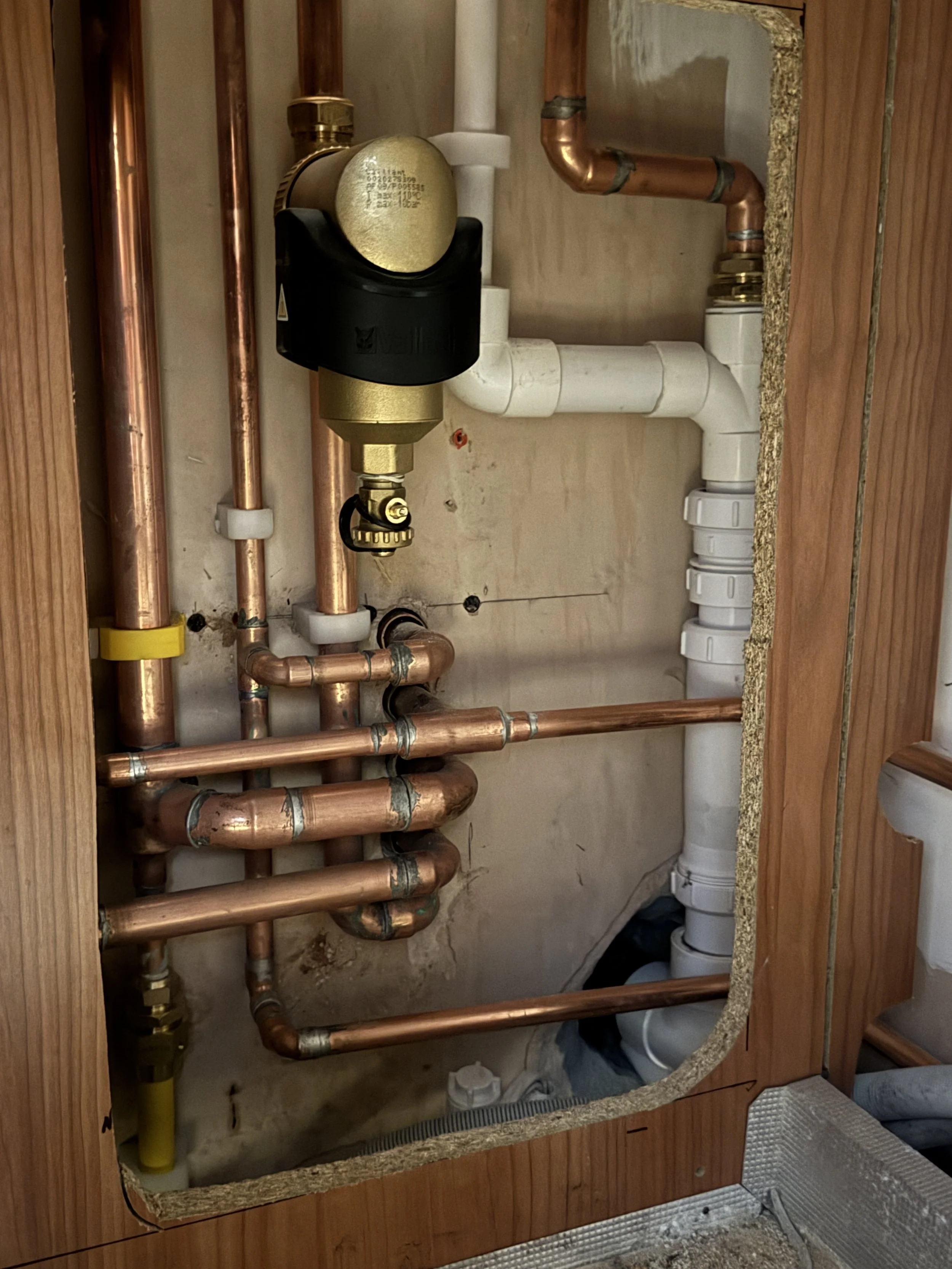

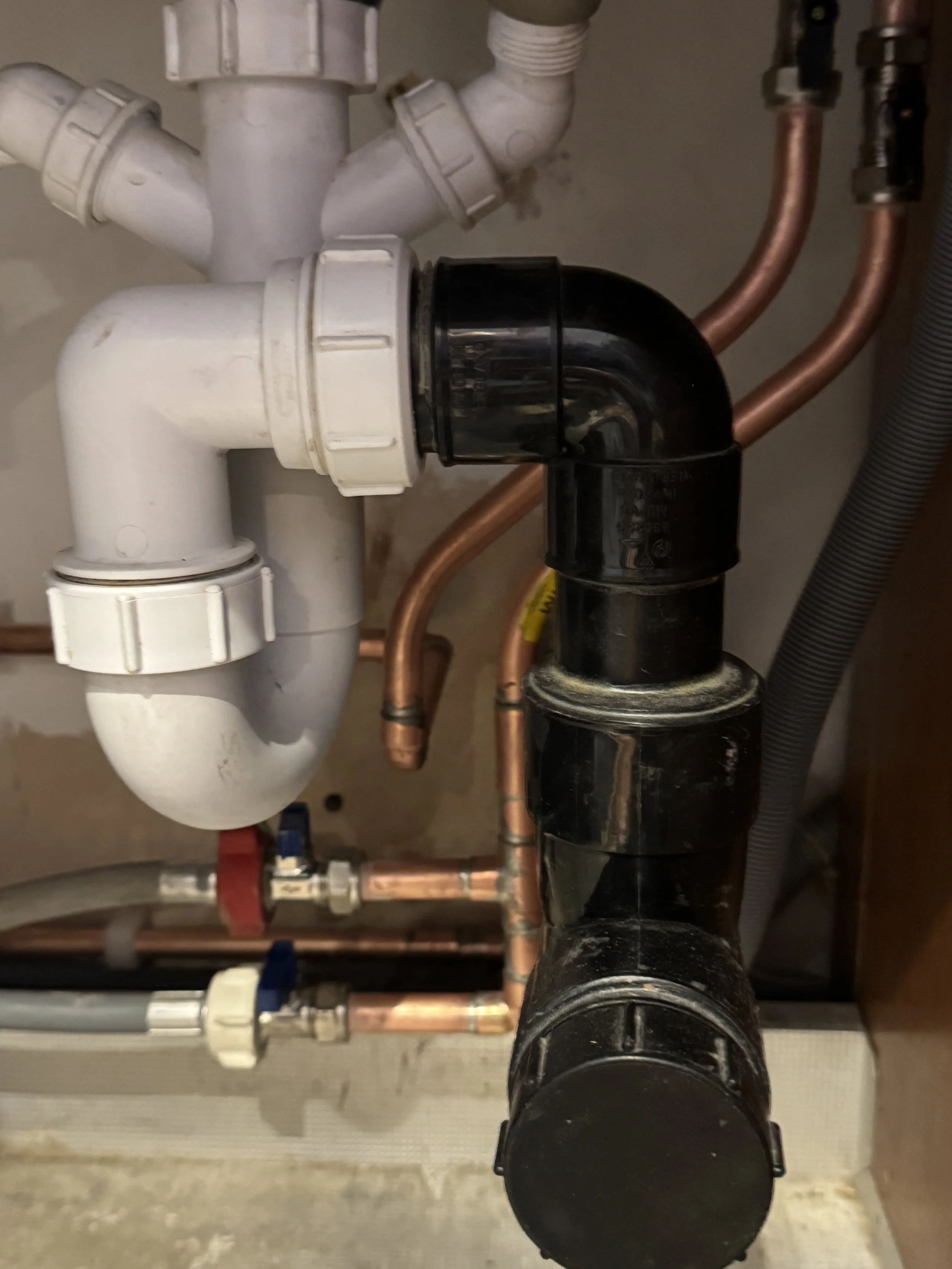

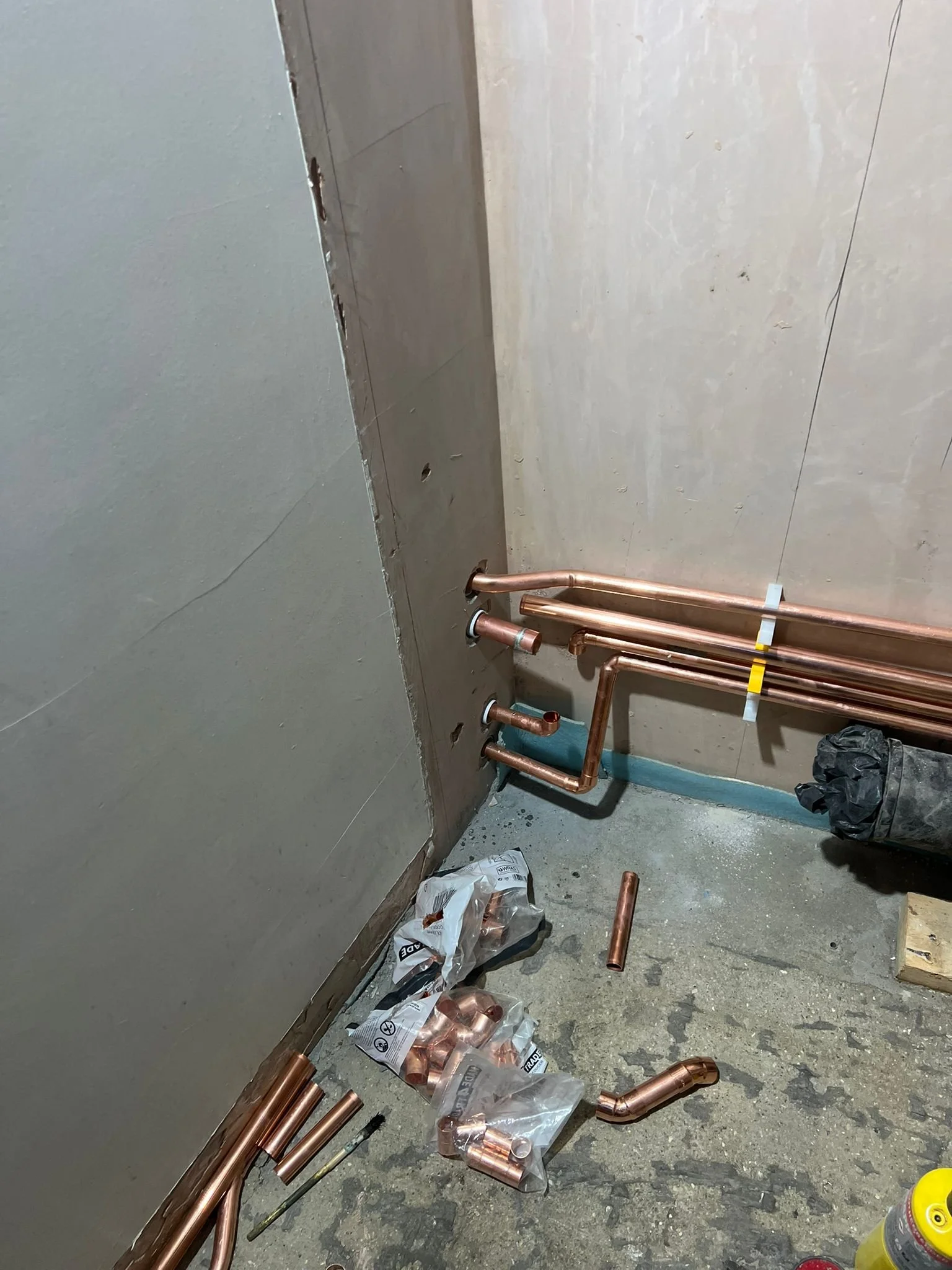

The existing system was removed and replaced with a fully redesigned plumbing layout.

What was previously concealed, inconsistent, and failing was replaced with a structured and controlled installation designed for long-term performance.

The upgrade included:

  • installation of a new incoming main water supply

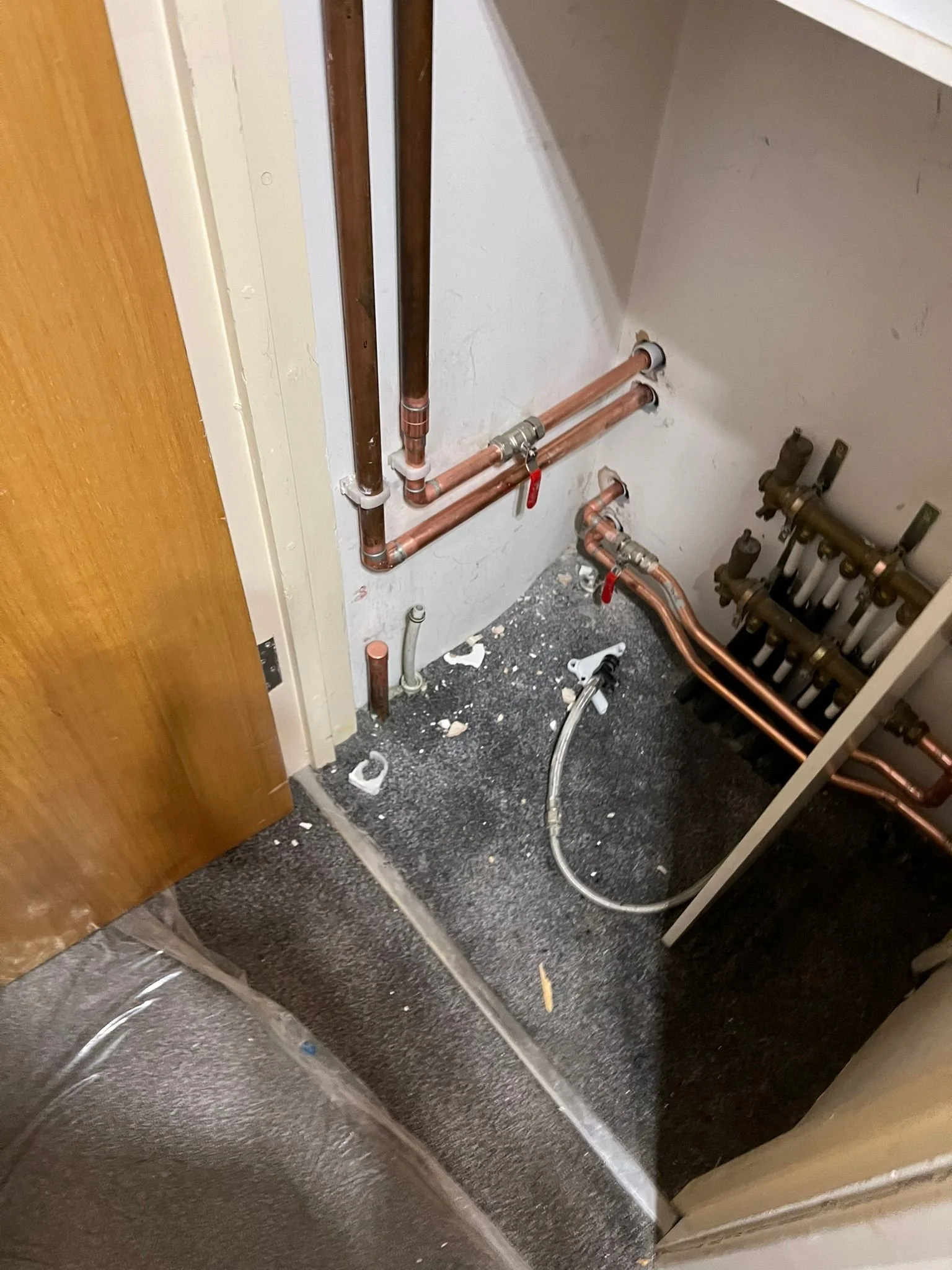

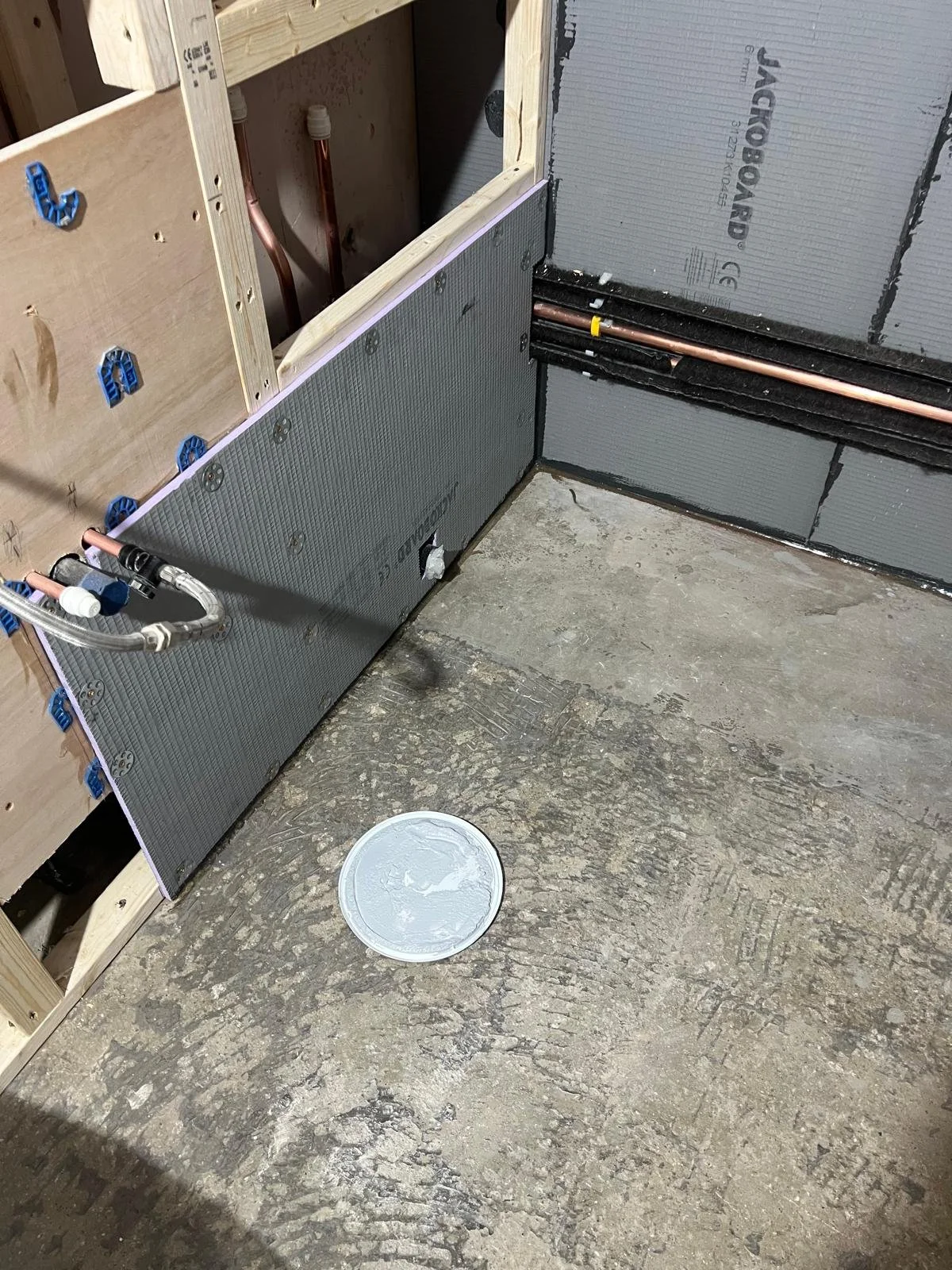

  • new flow and return pipework to the manifold

  • upgraded hot water distribution system

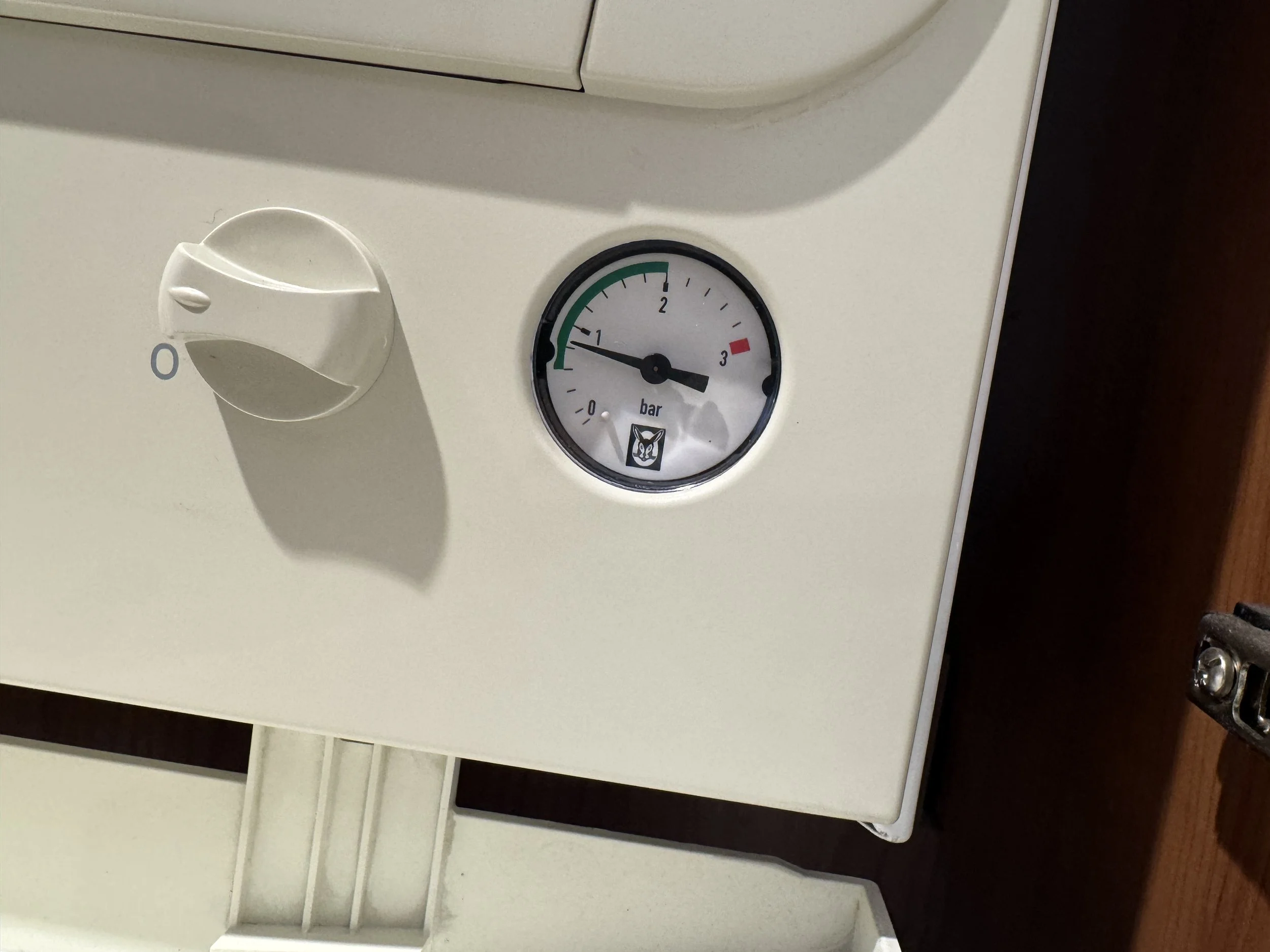

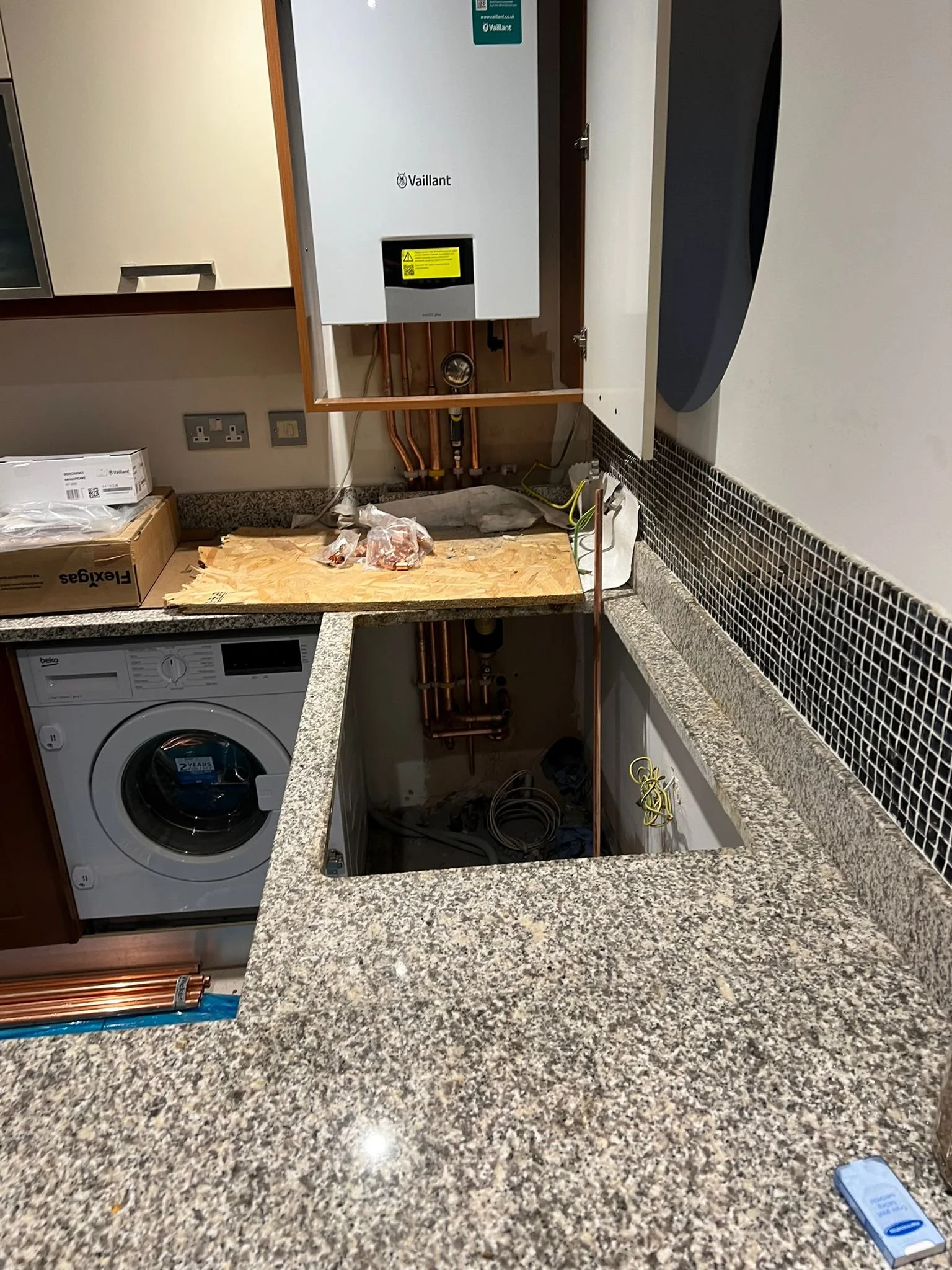

  • installation of a modern, efficient combi boiler

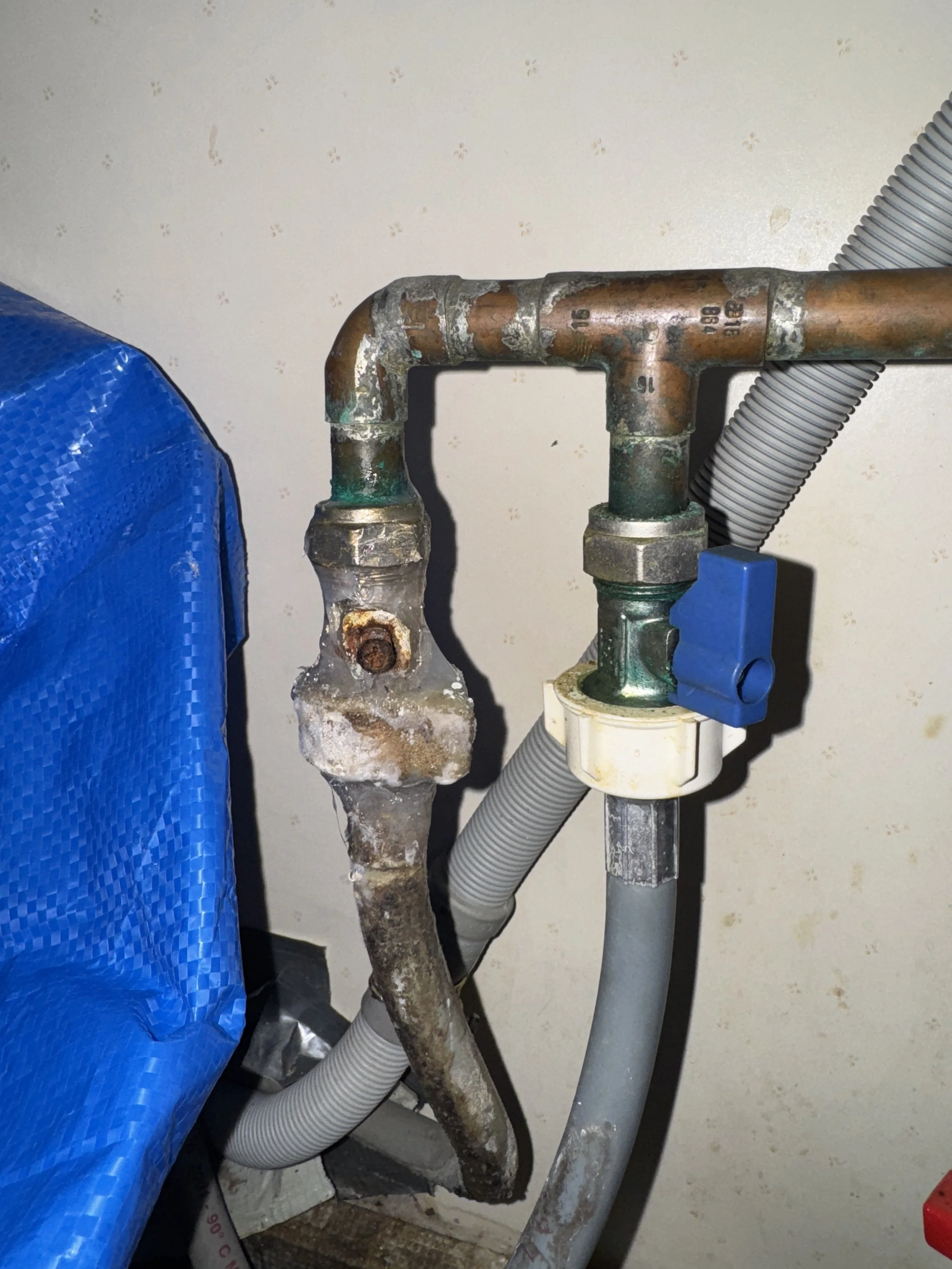

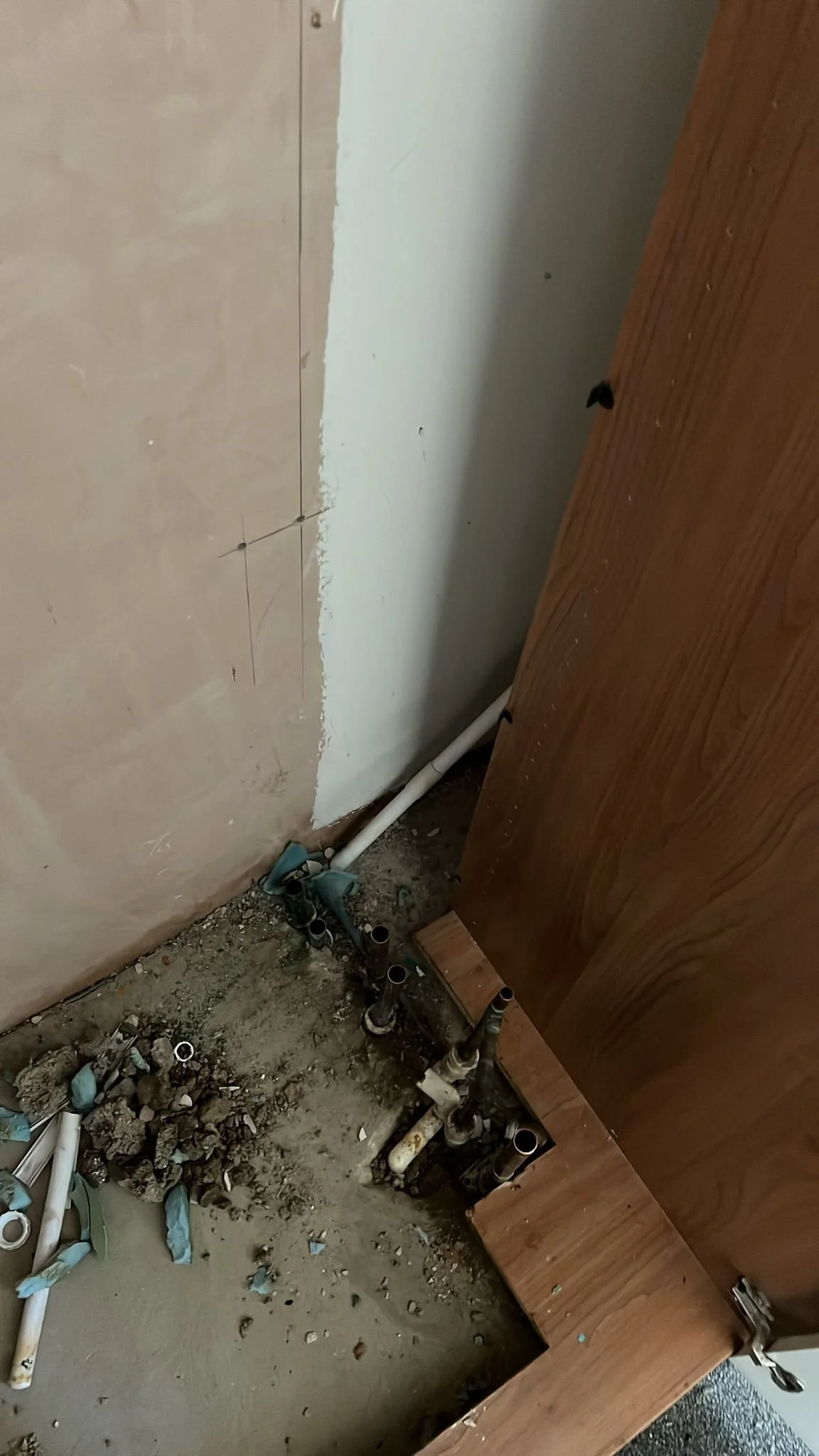

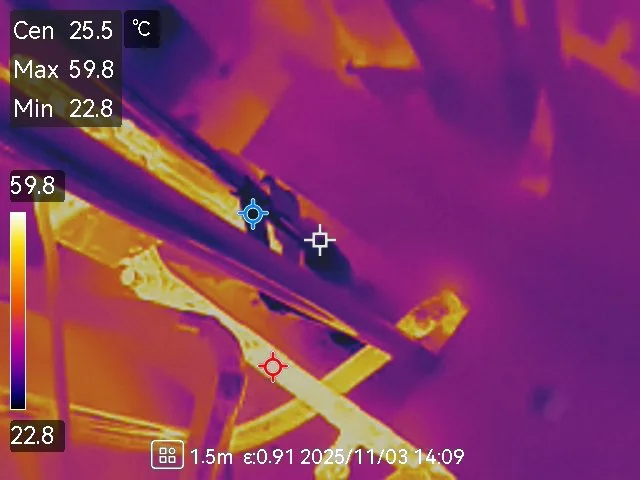

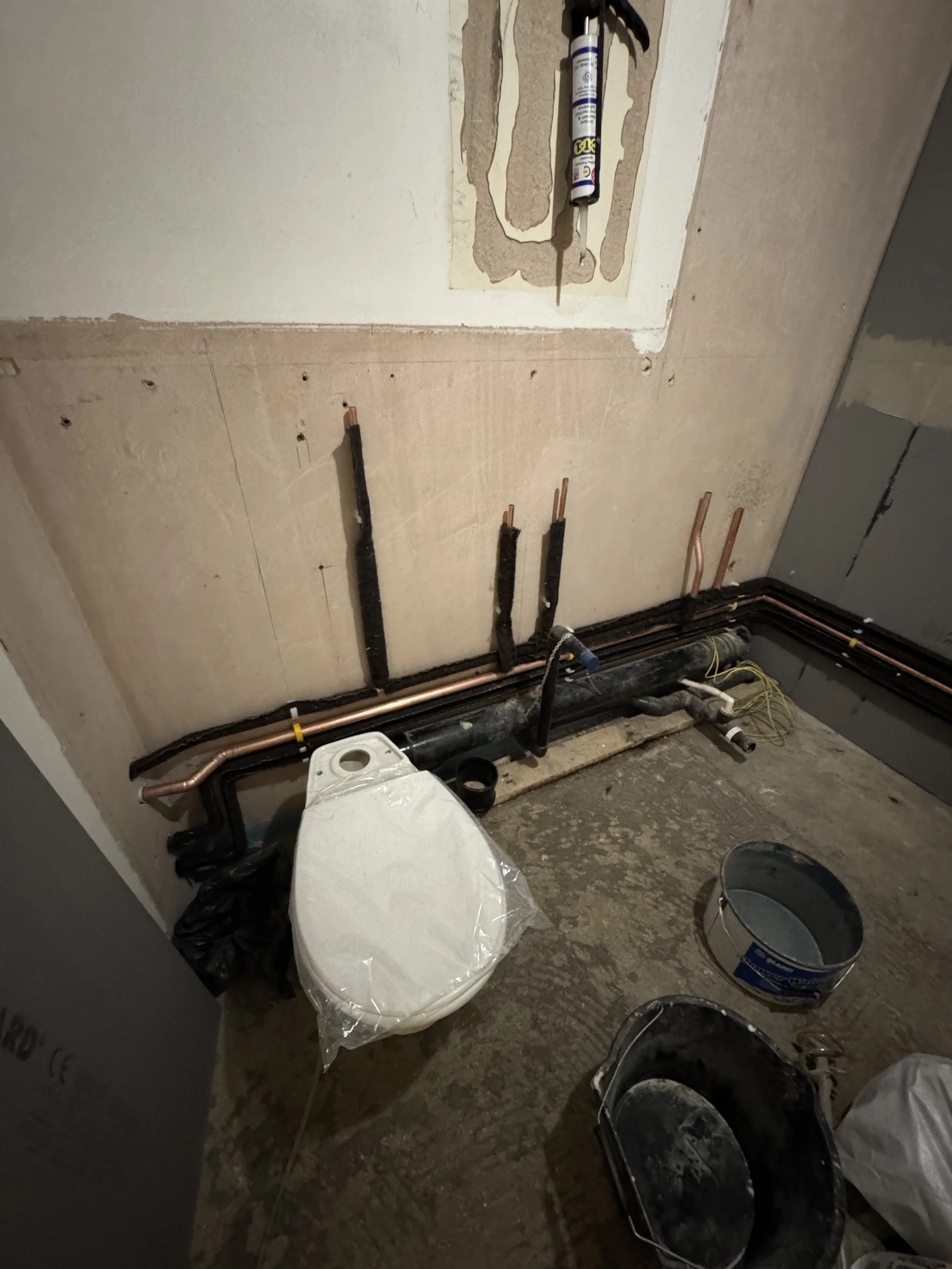

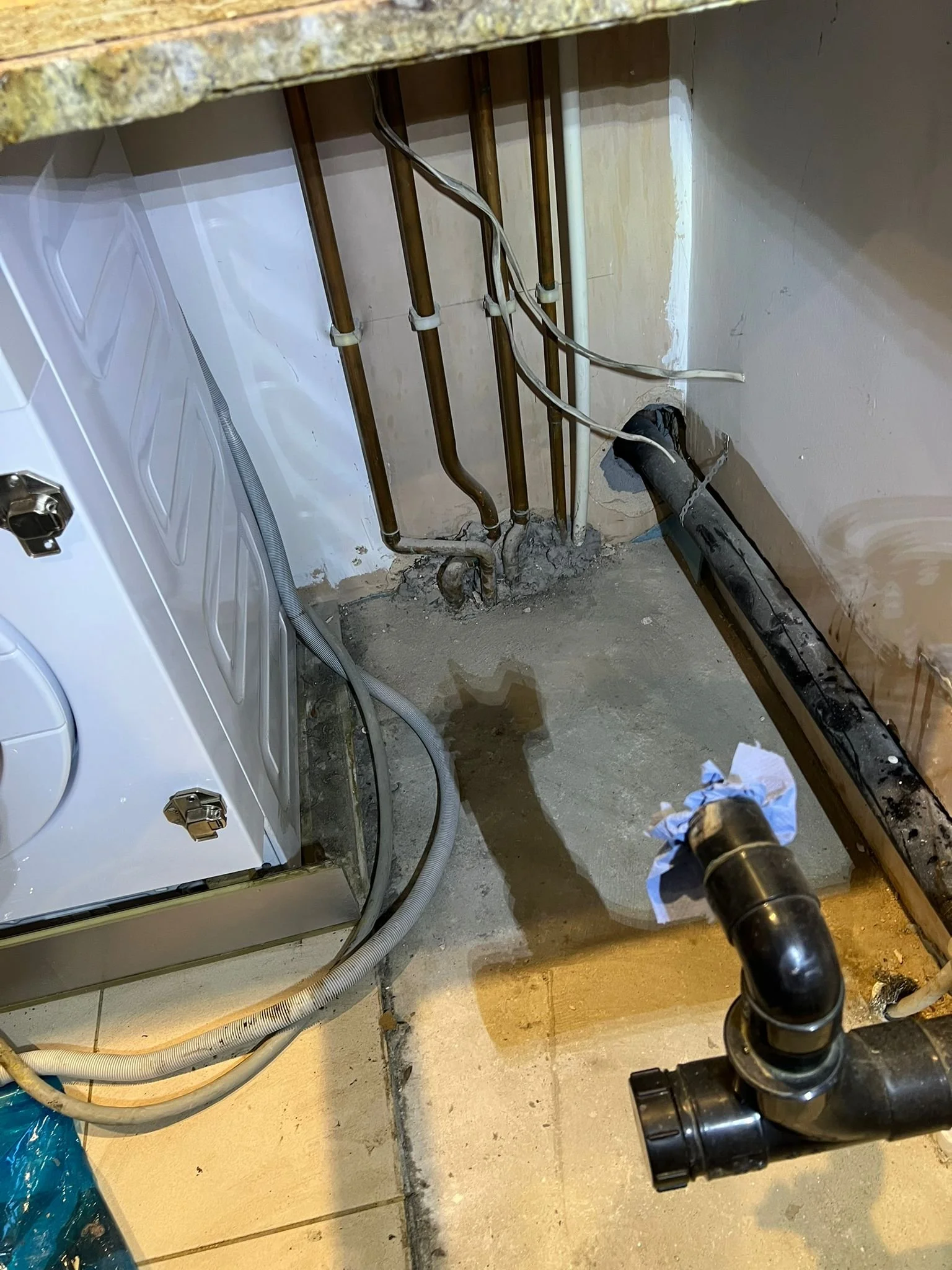

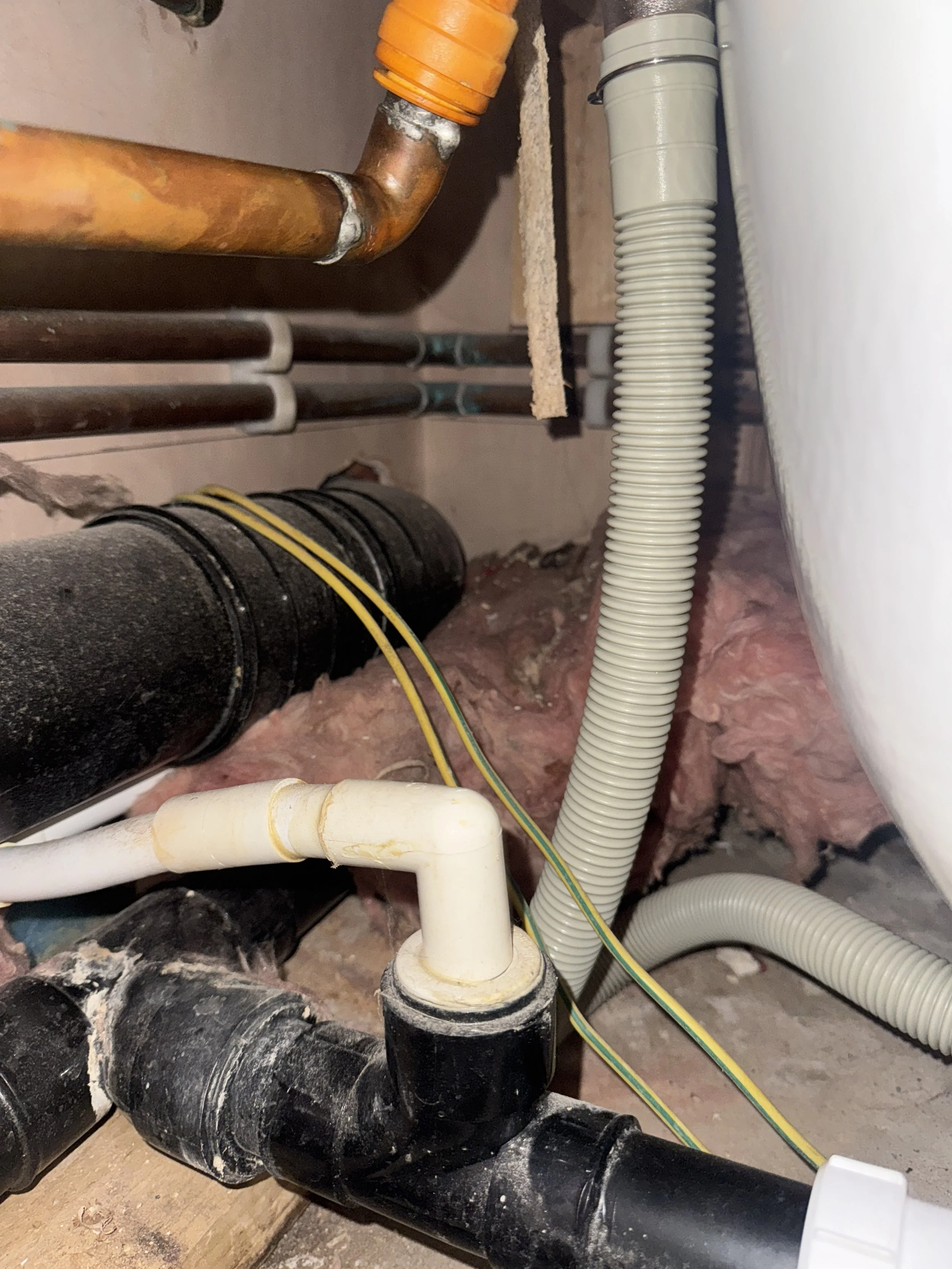

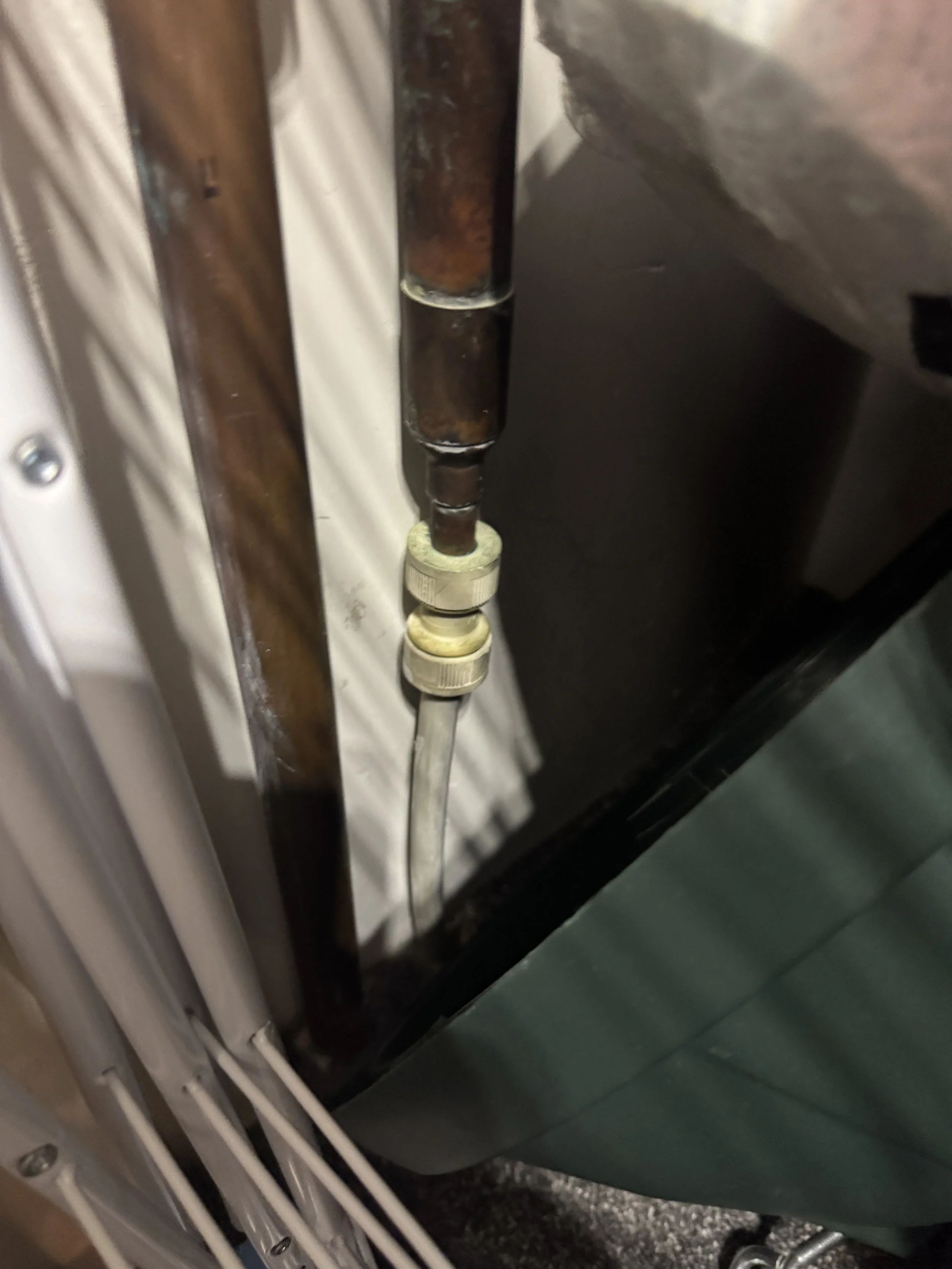

During the process, the existing system was pressure-tested, which identified an additional leak on the supply line between the boiler and the manifold.

This required the installation of a new flow and return connection to the manifold, which was carried out as part of the works without additional cost to the client.

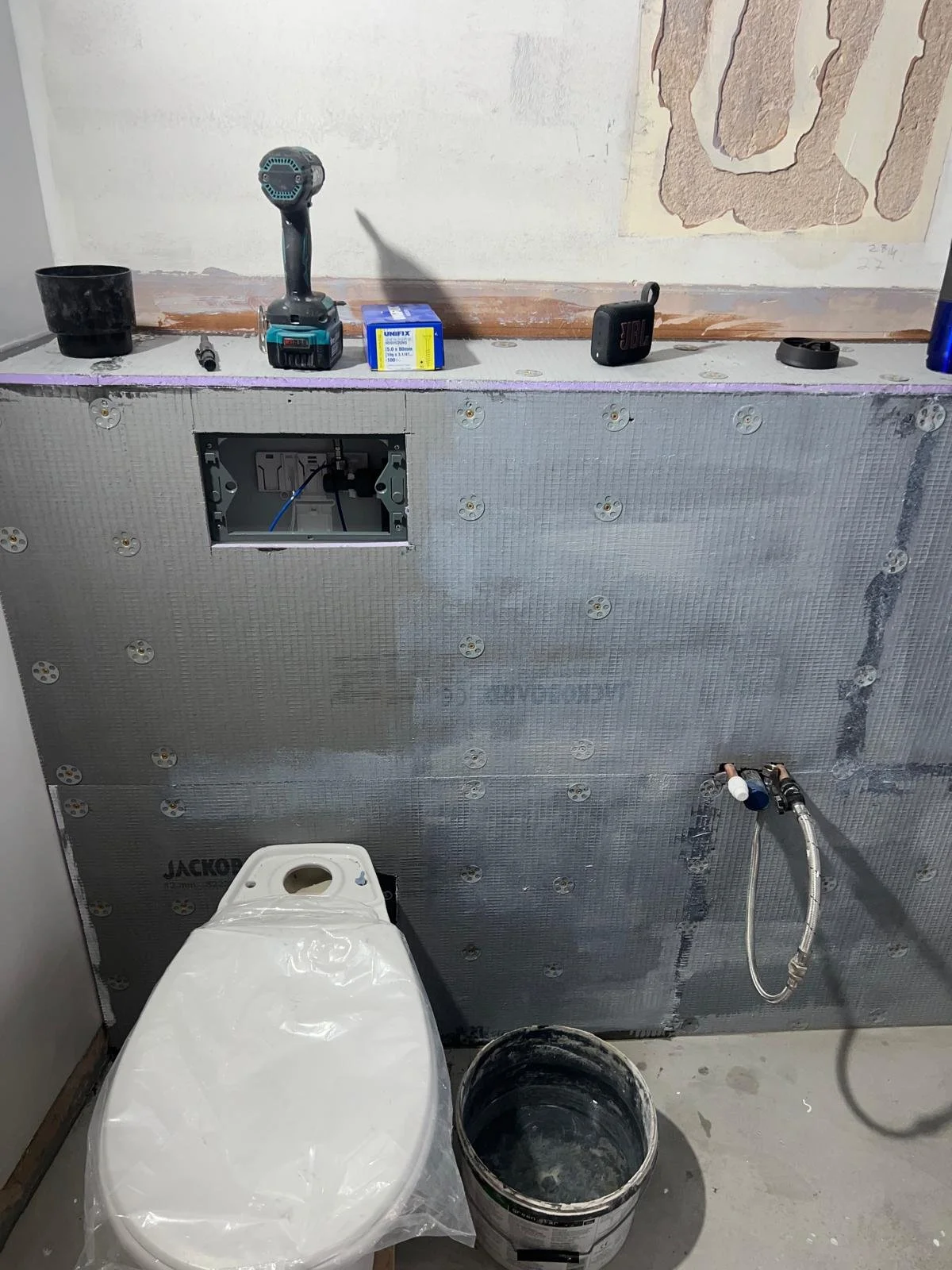

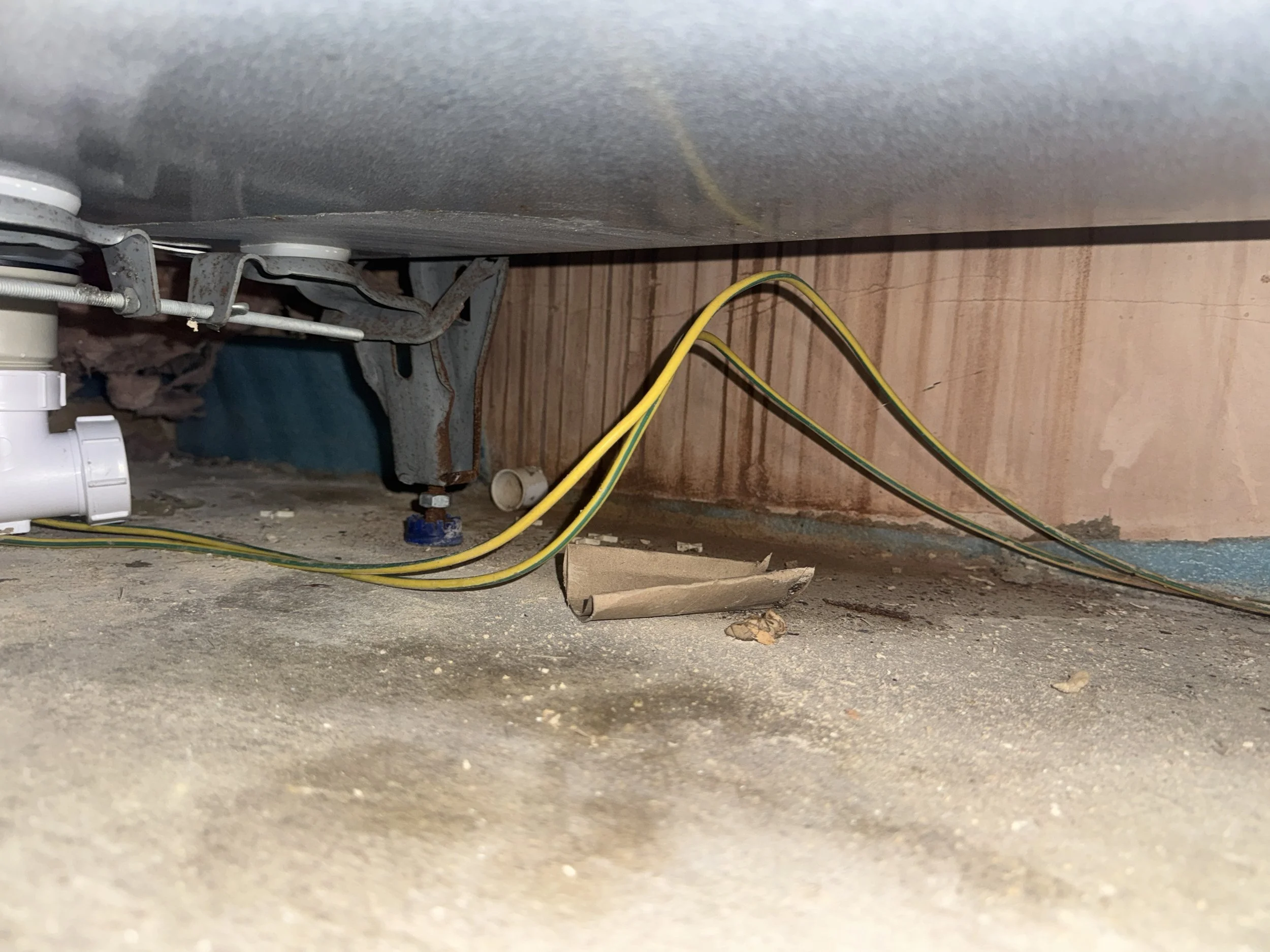

All concealed push-fit connections were eliminated and replaced with a fully accessible and serviceable system.

Every component was installed with future access, control, and system integrity in mind.

This was addressed as part of our commitment to delivering a complete and properly functioning system.

System Rebuild & Bathroom Installation

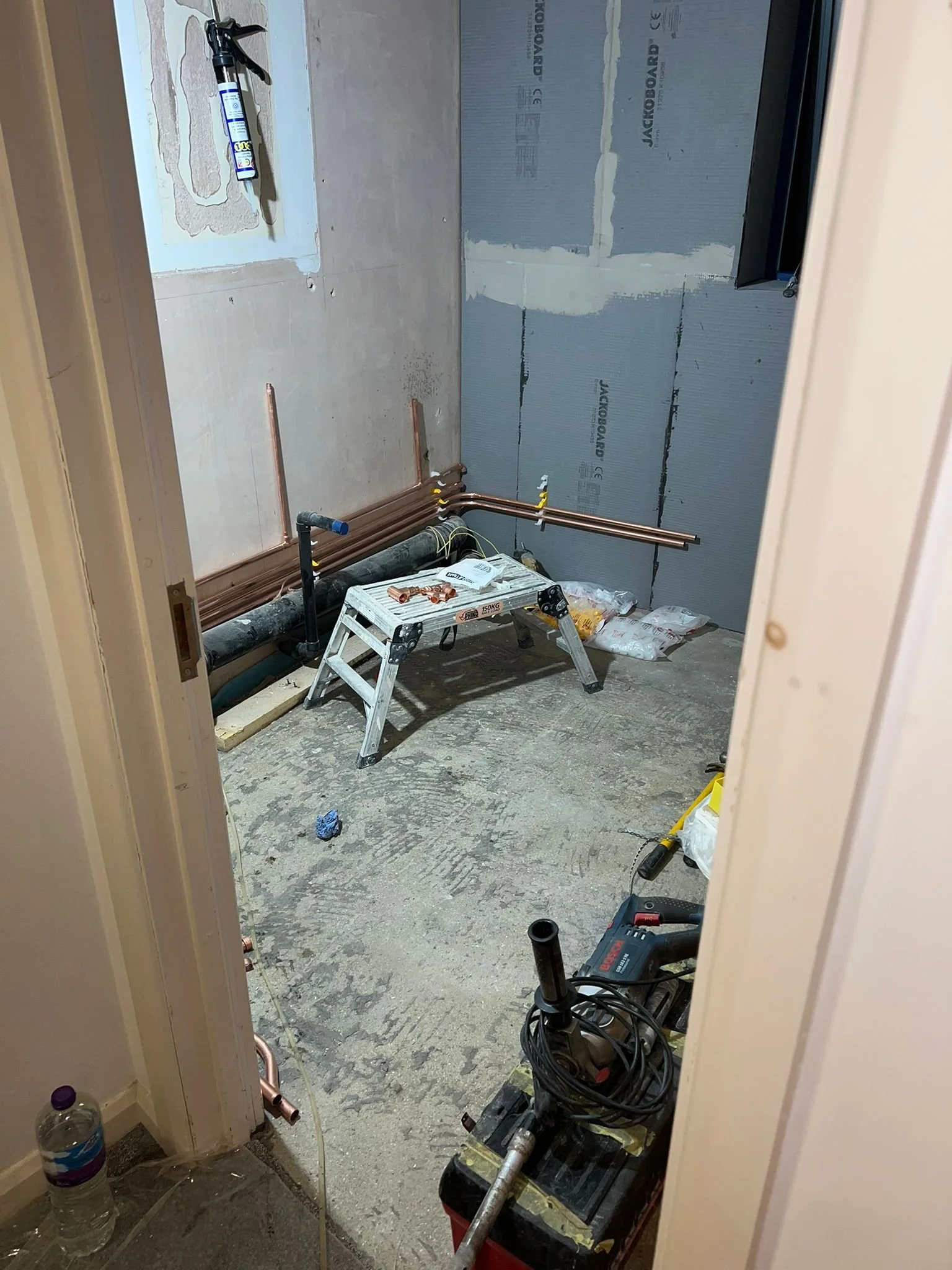

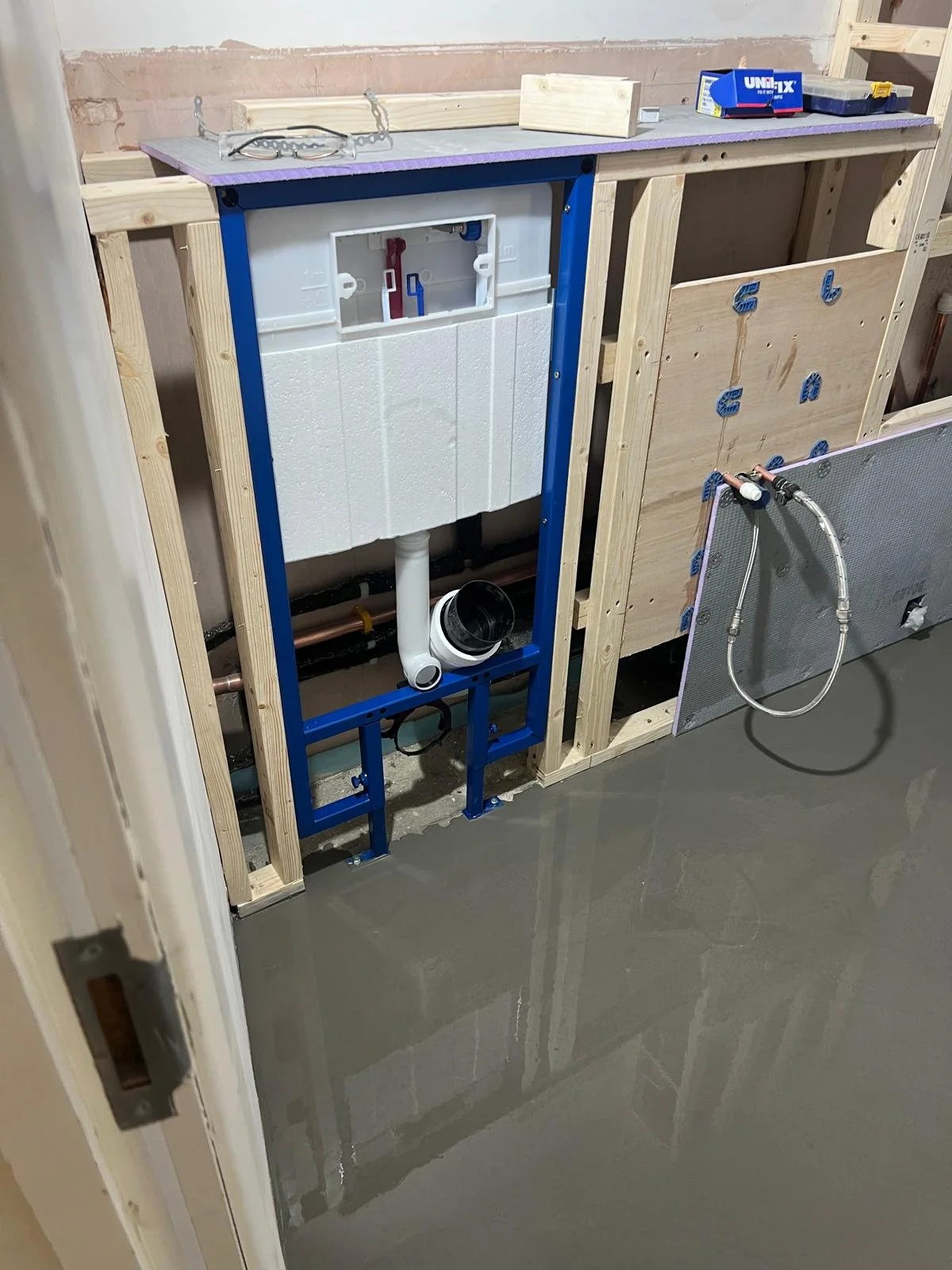

With the new plumbing infrastructure in place, the system was rebuilt in a controlled and structured manner.

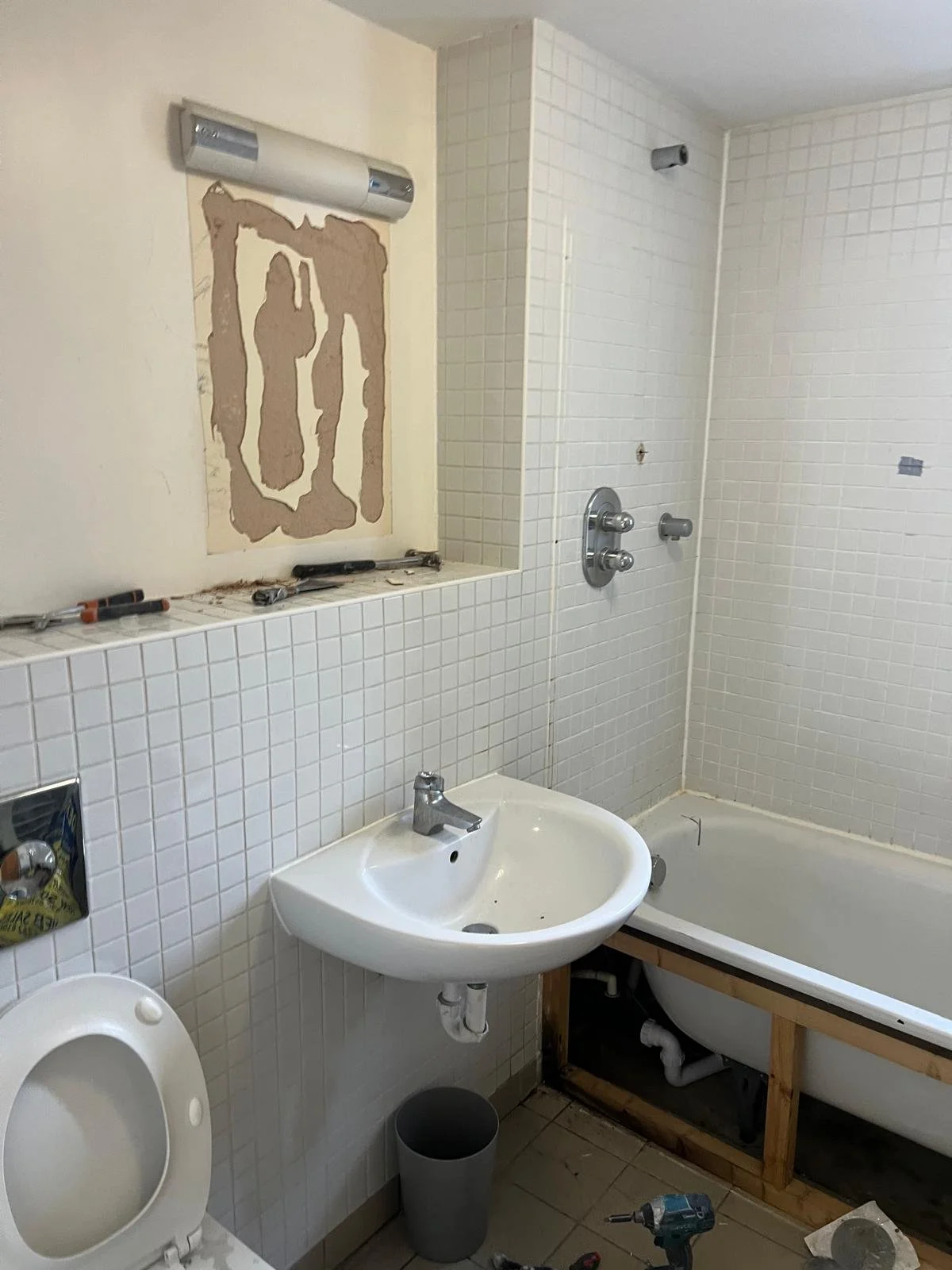

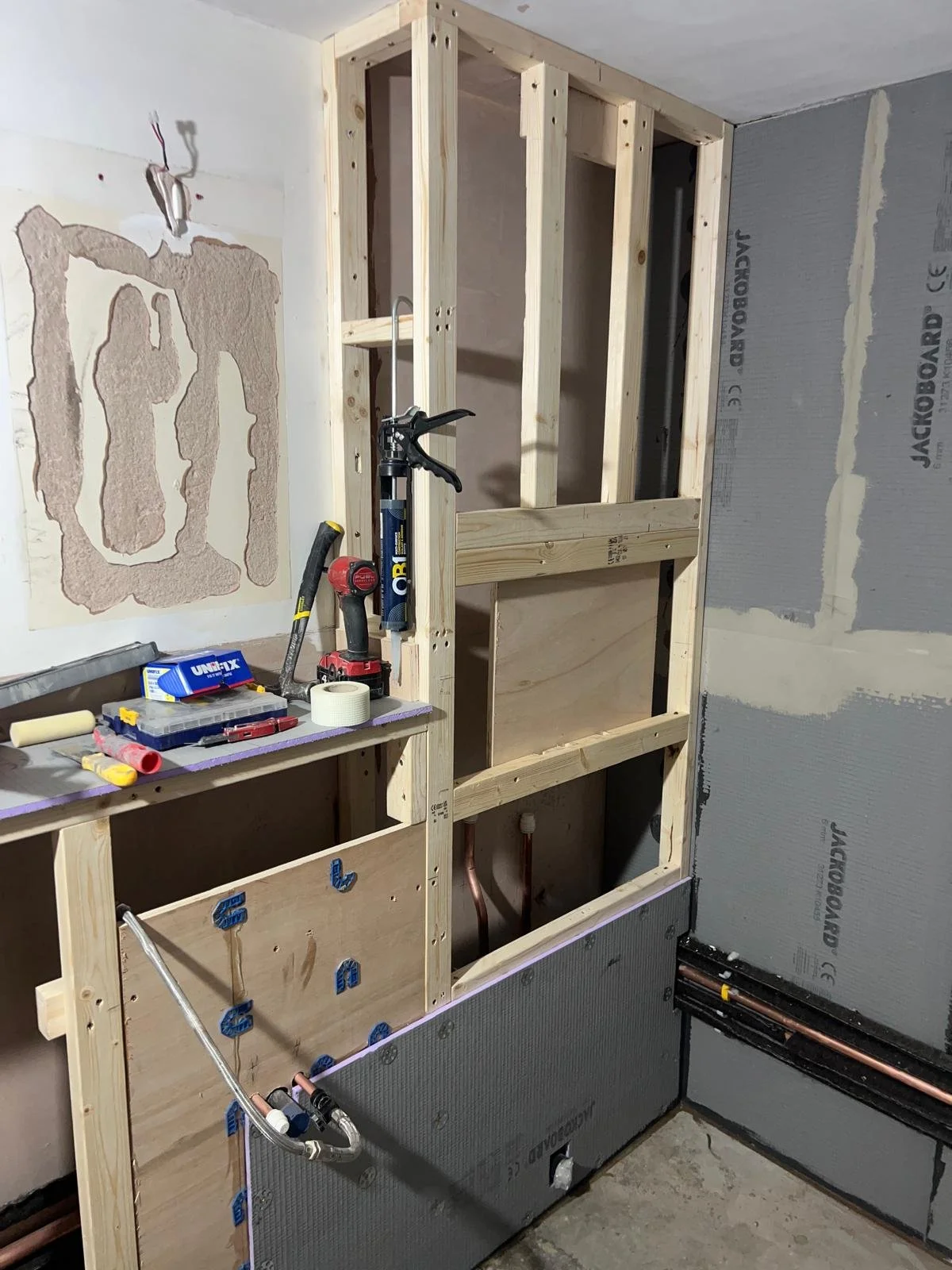

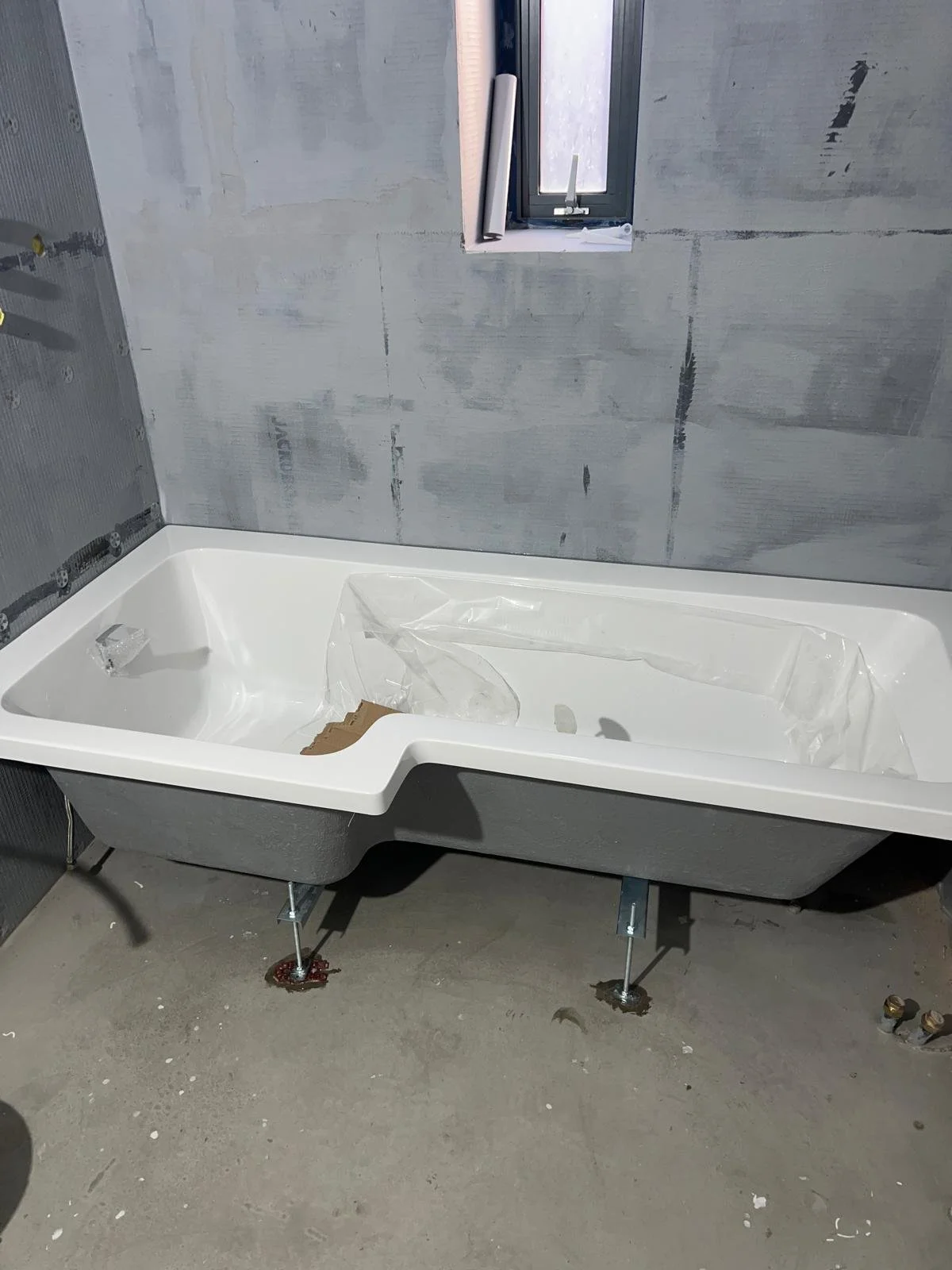

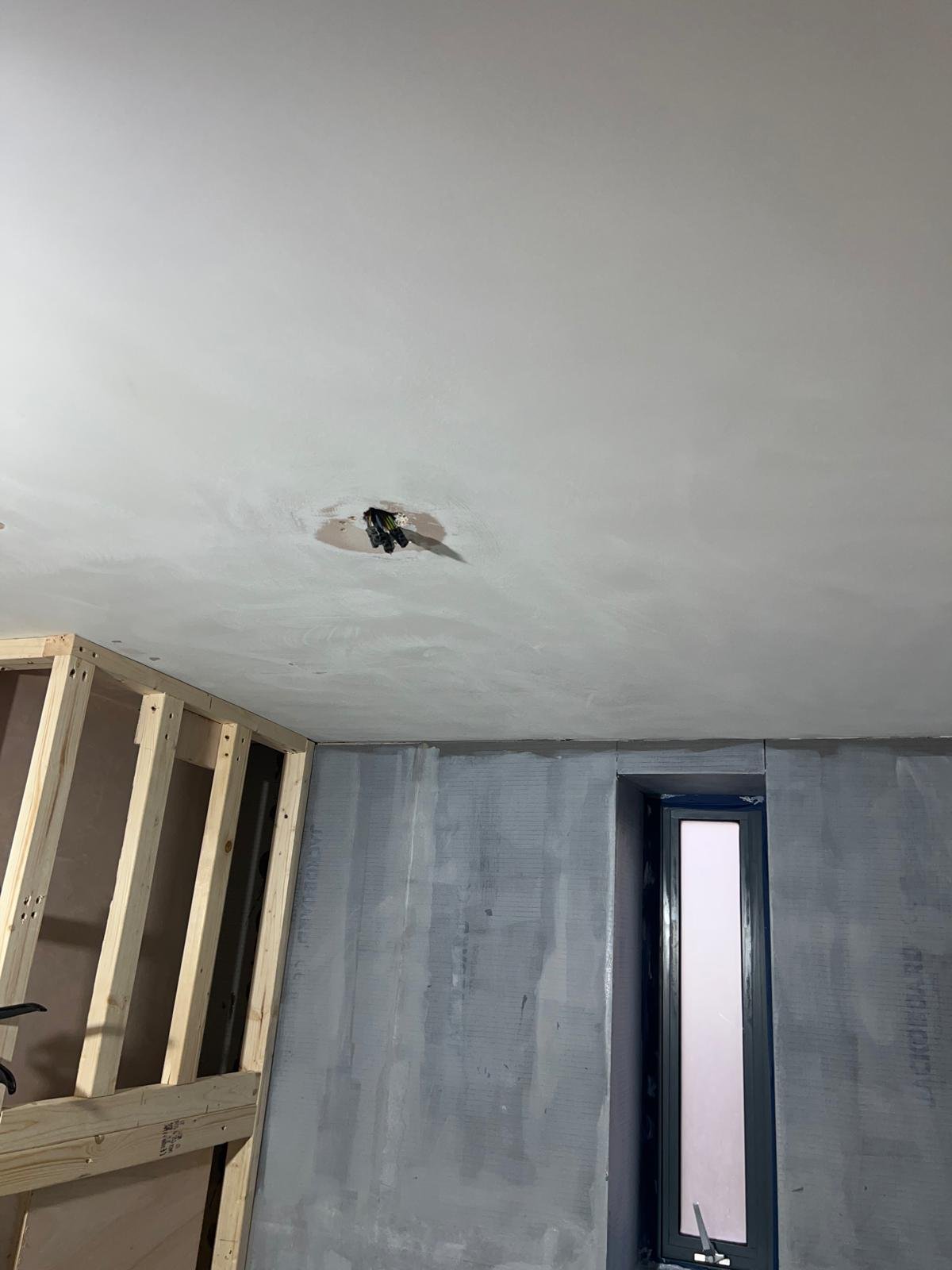

At the same time, the bathroom was fully reconstructed — ensuring that both the mechanical system and the finished environment were aligned and built to the same standard.

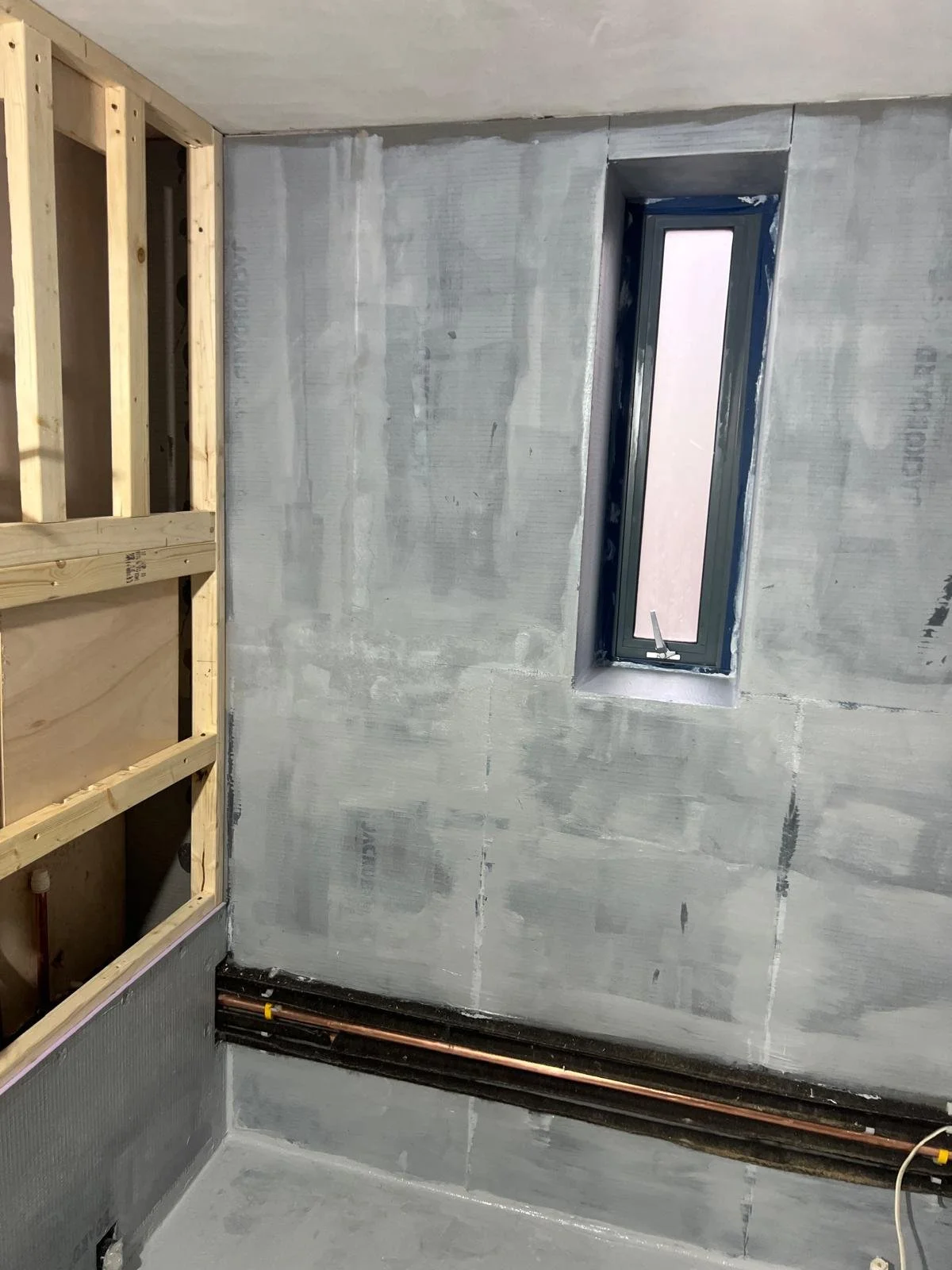

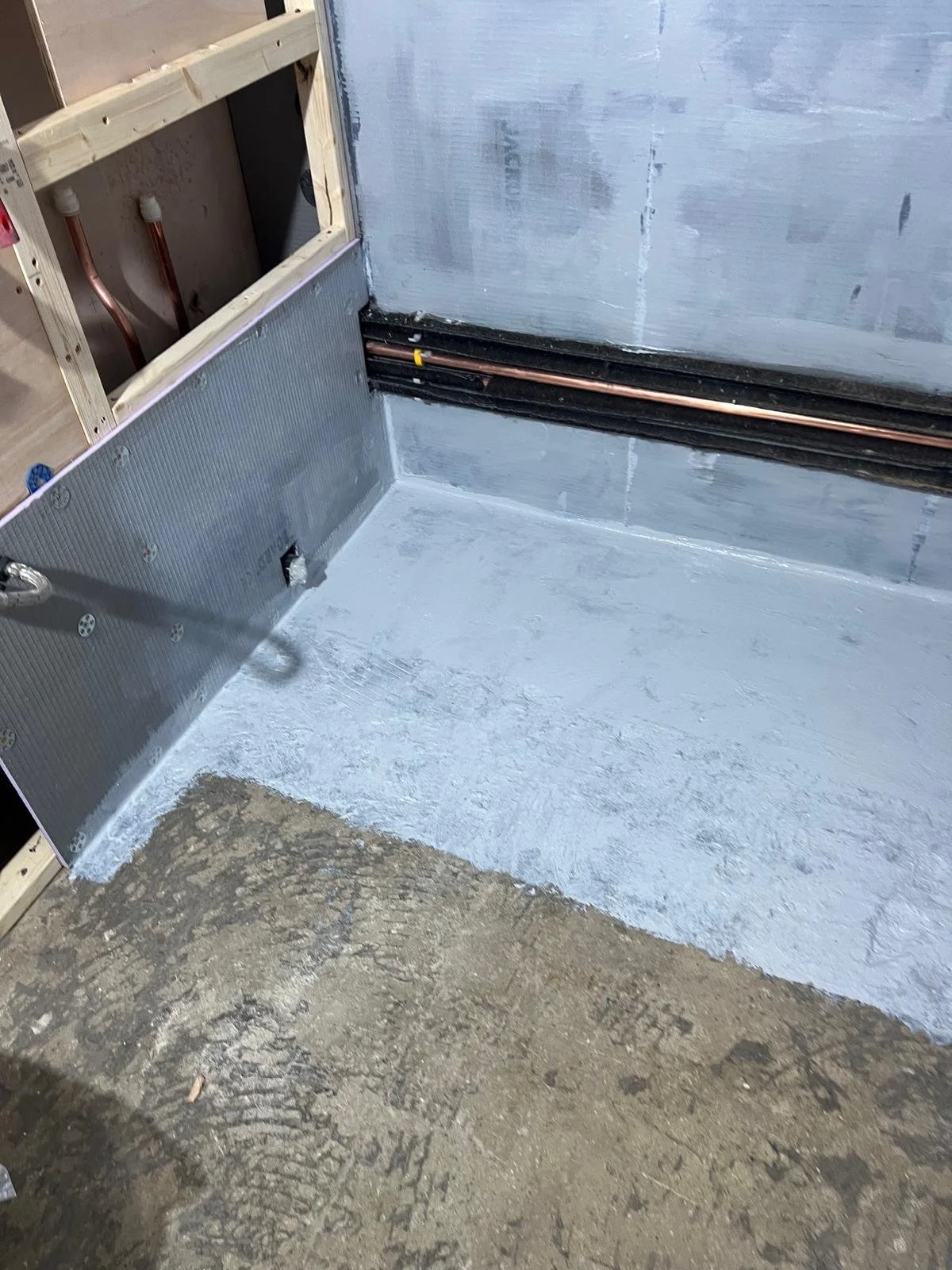

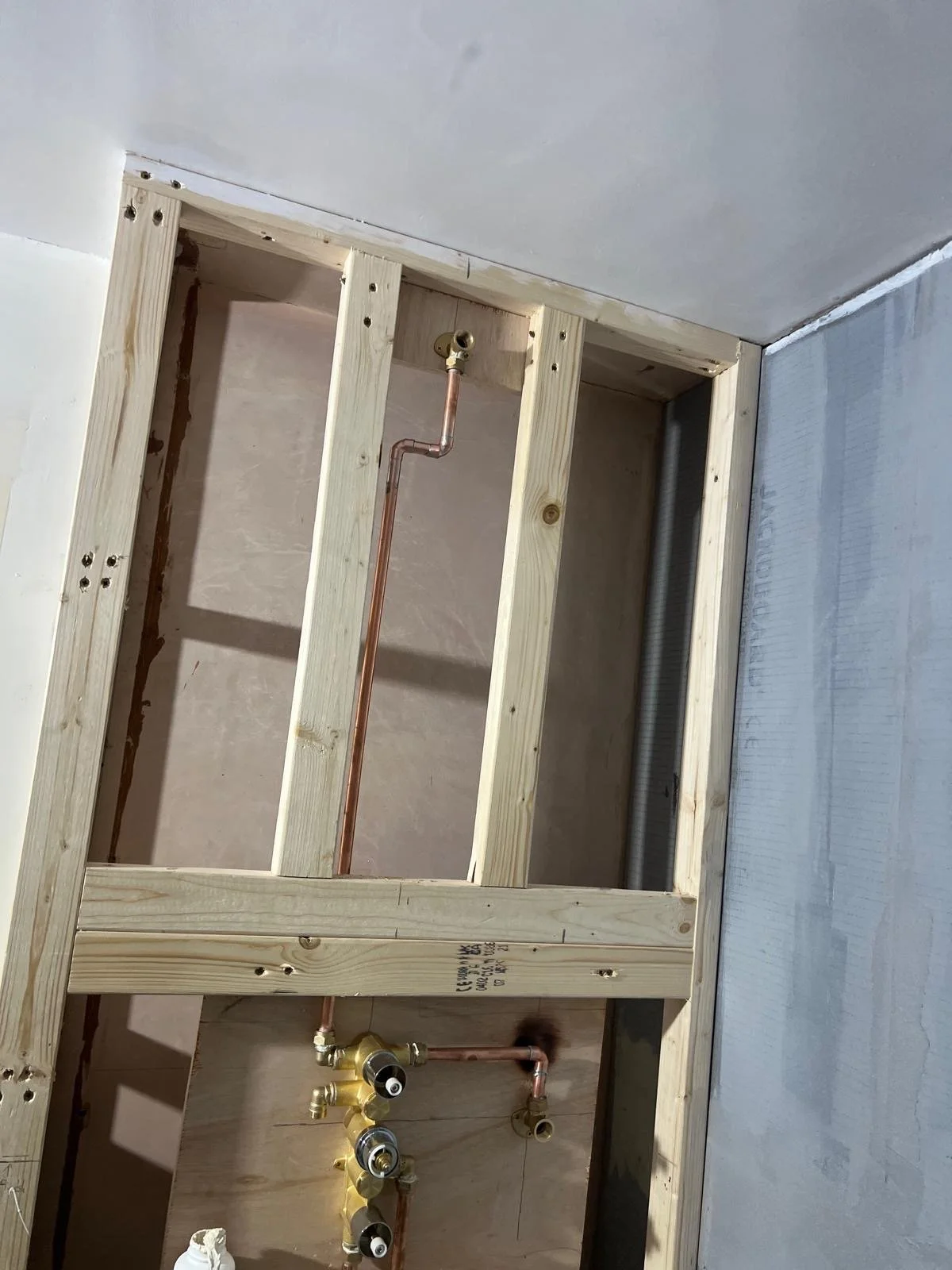

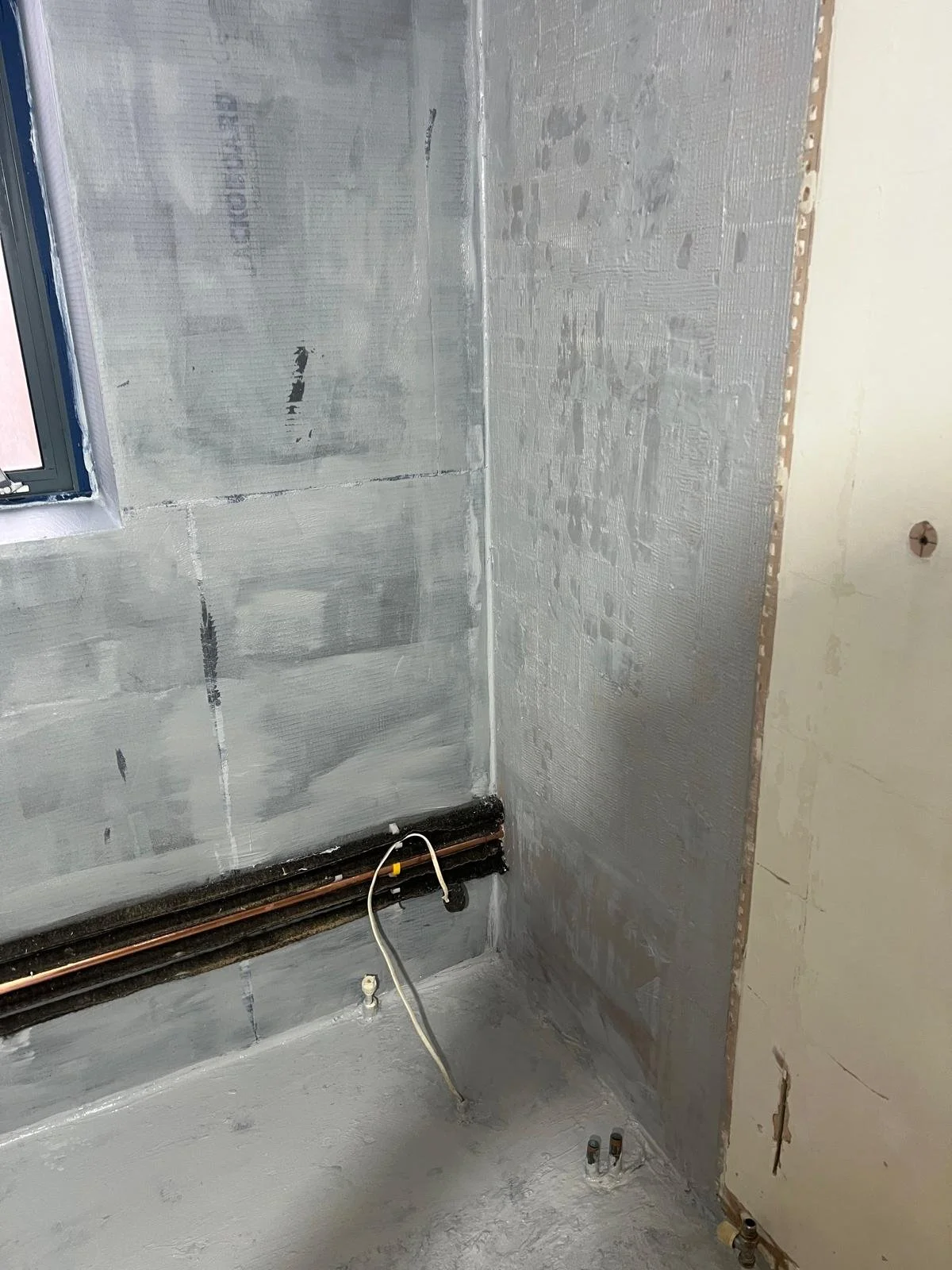

All pipework was installed with clear routing, proper spacing, and full accessibility for future maintenance.

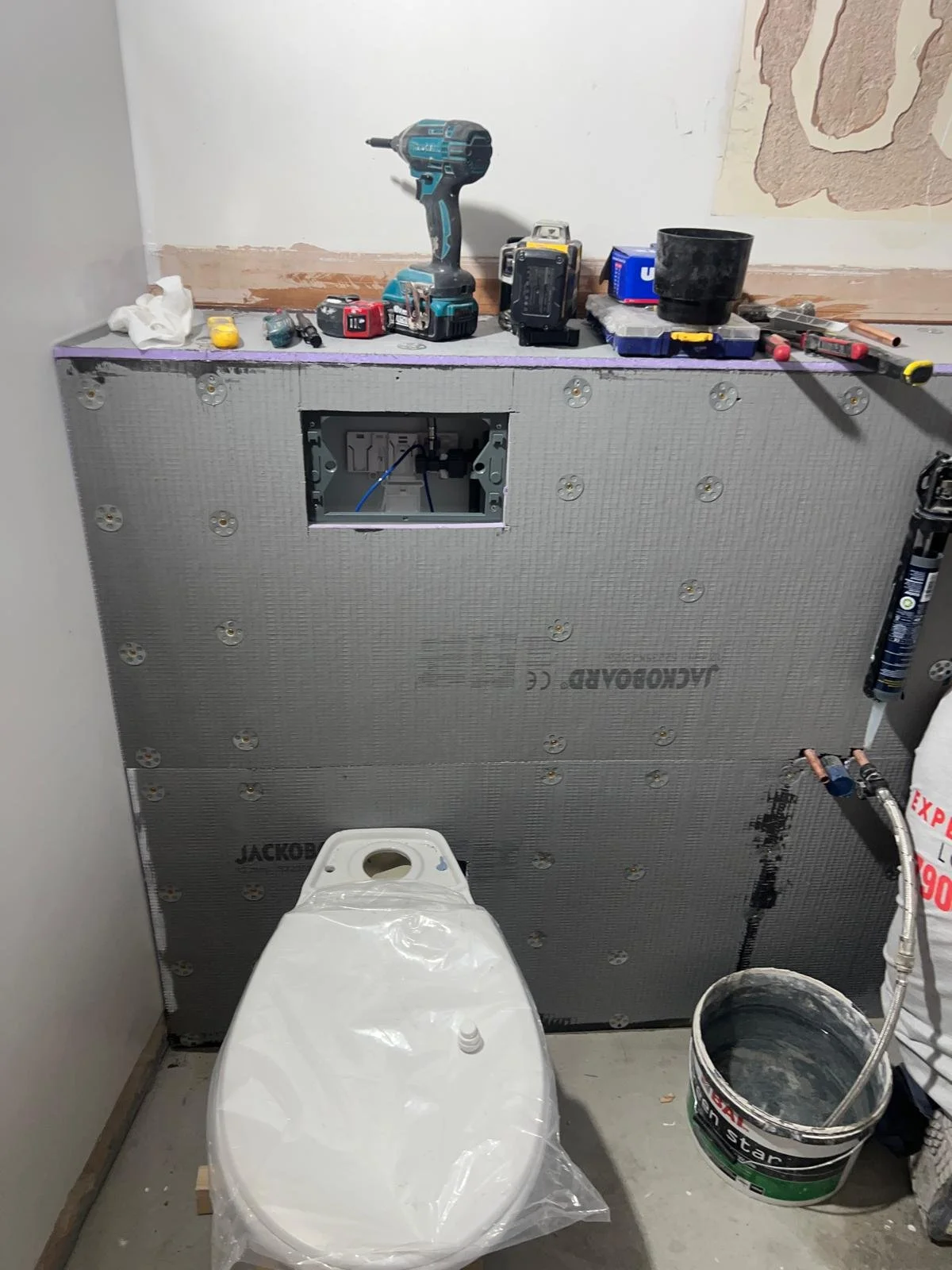

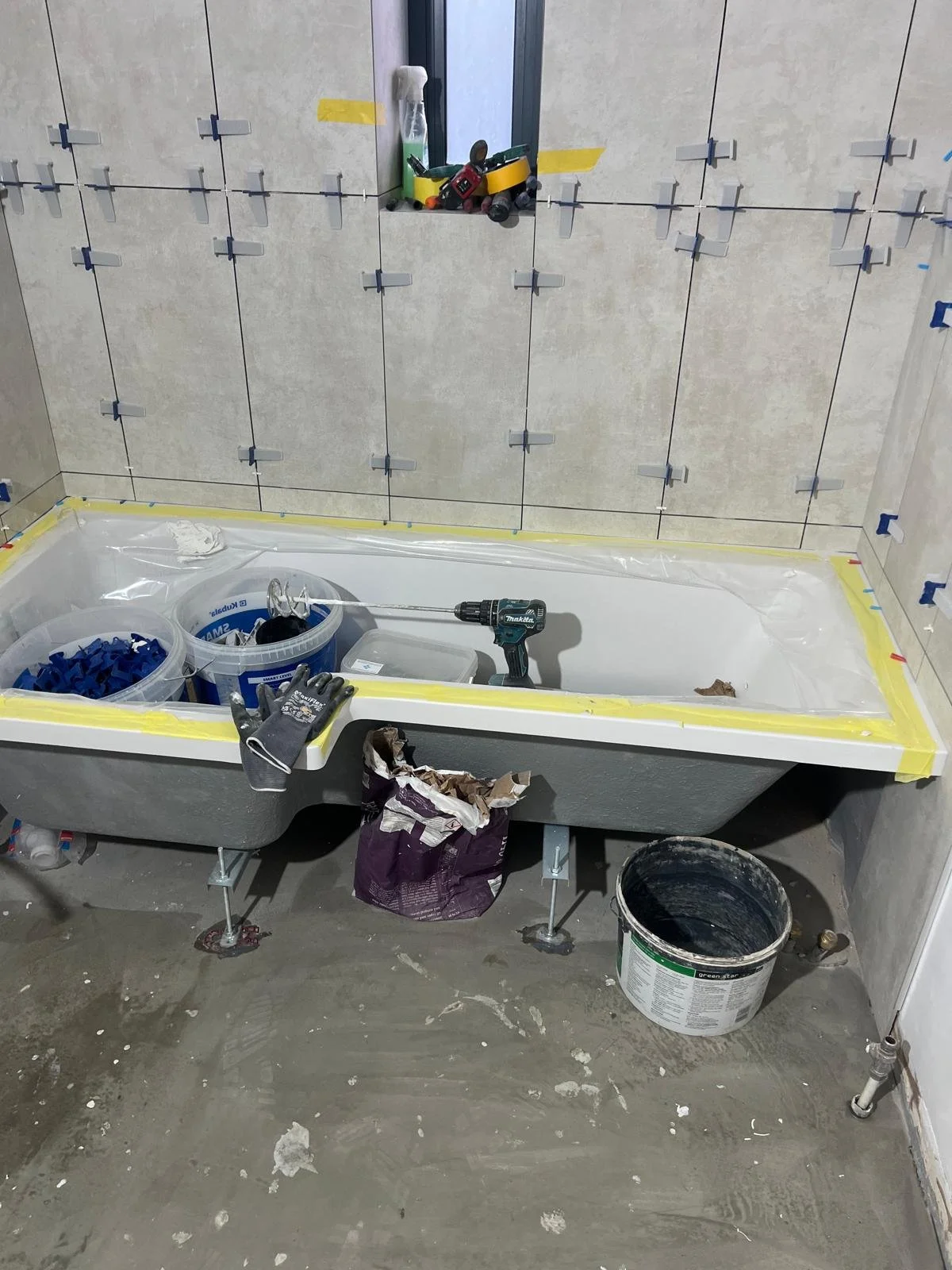

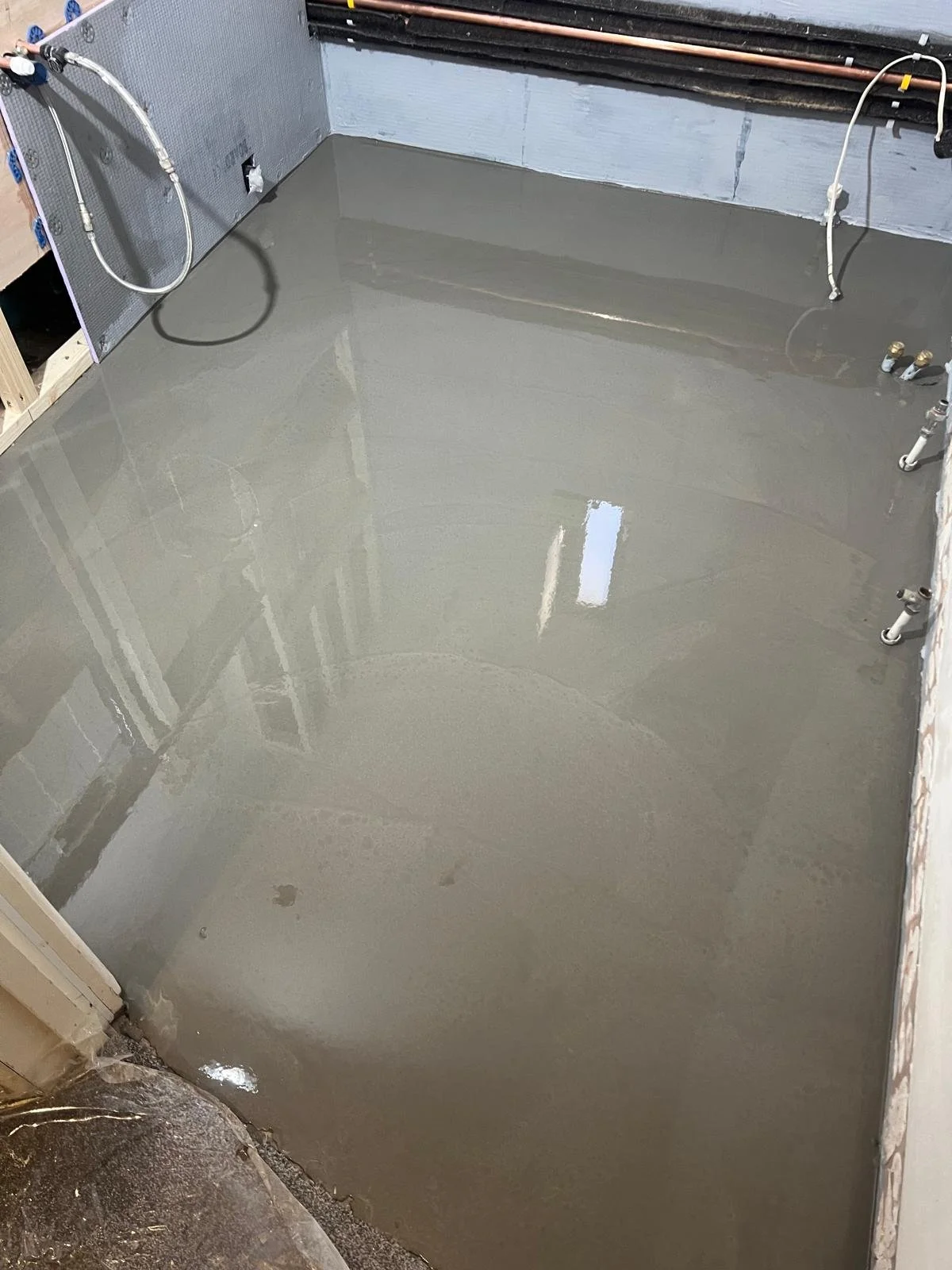

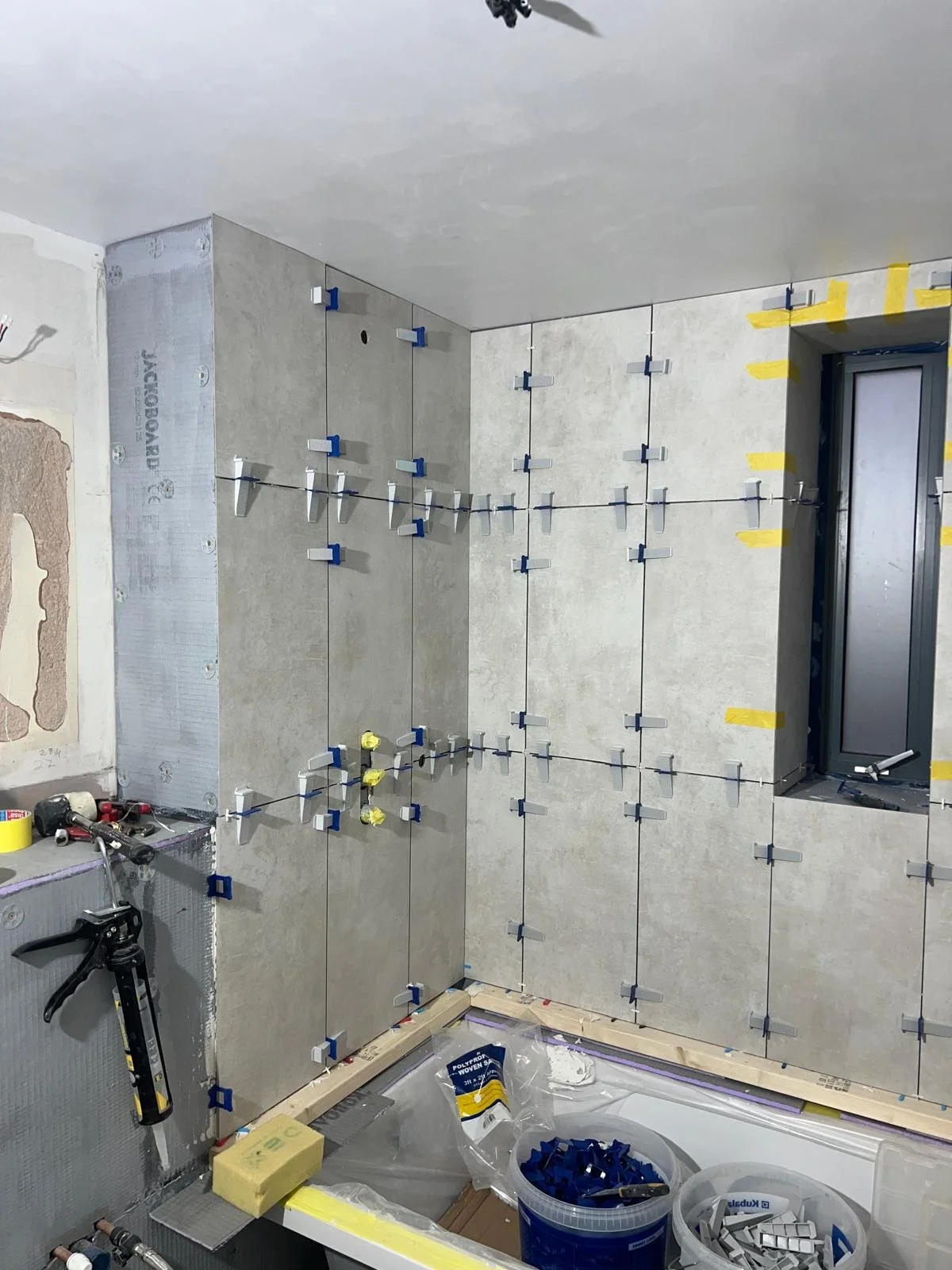

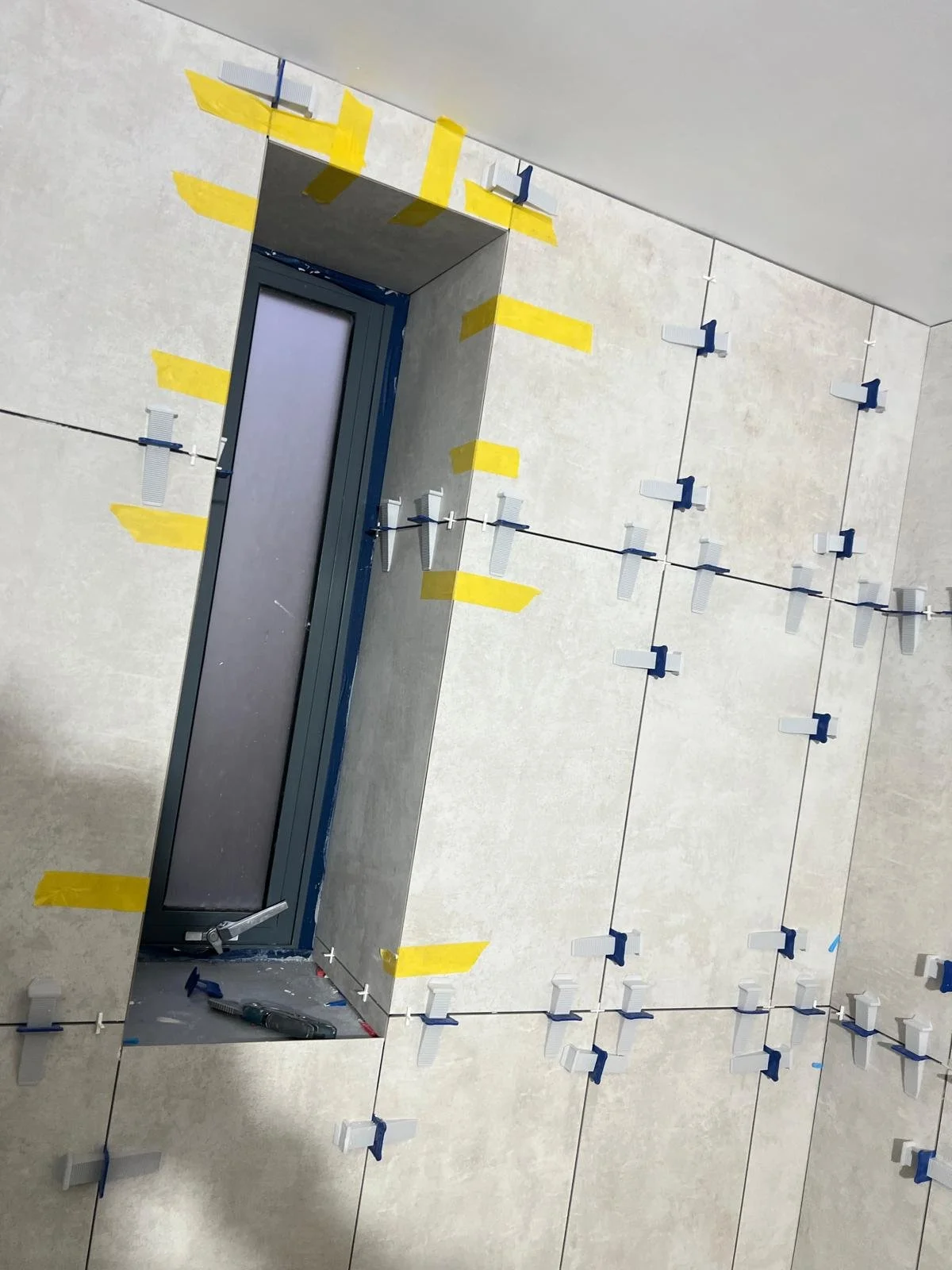

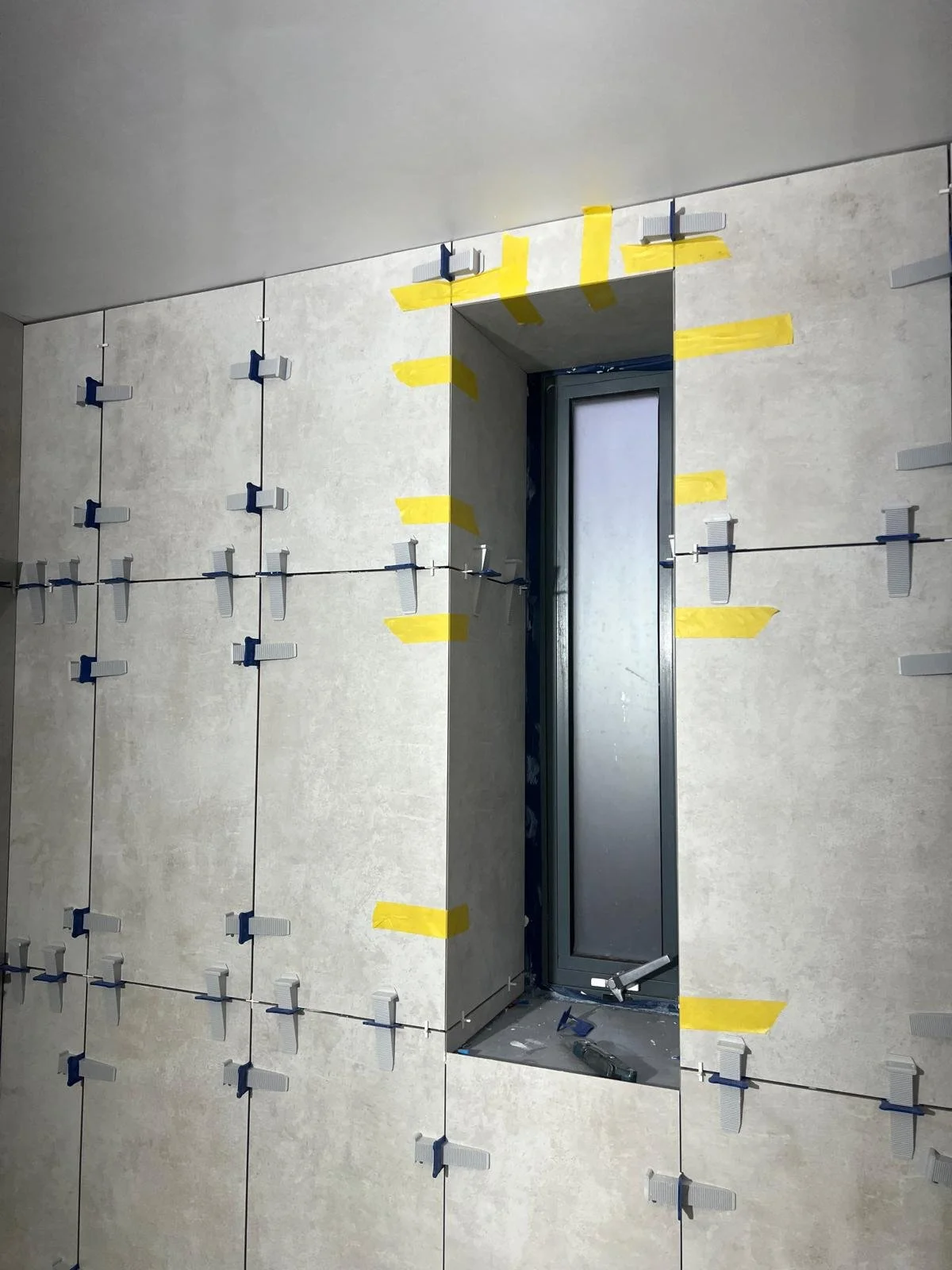

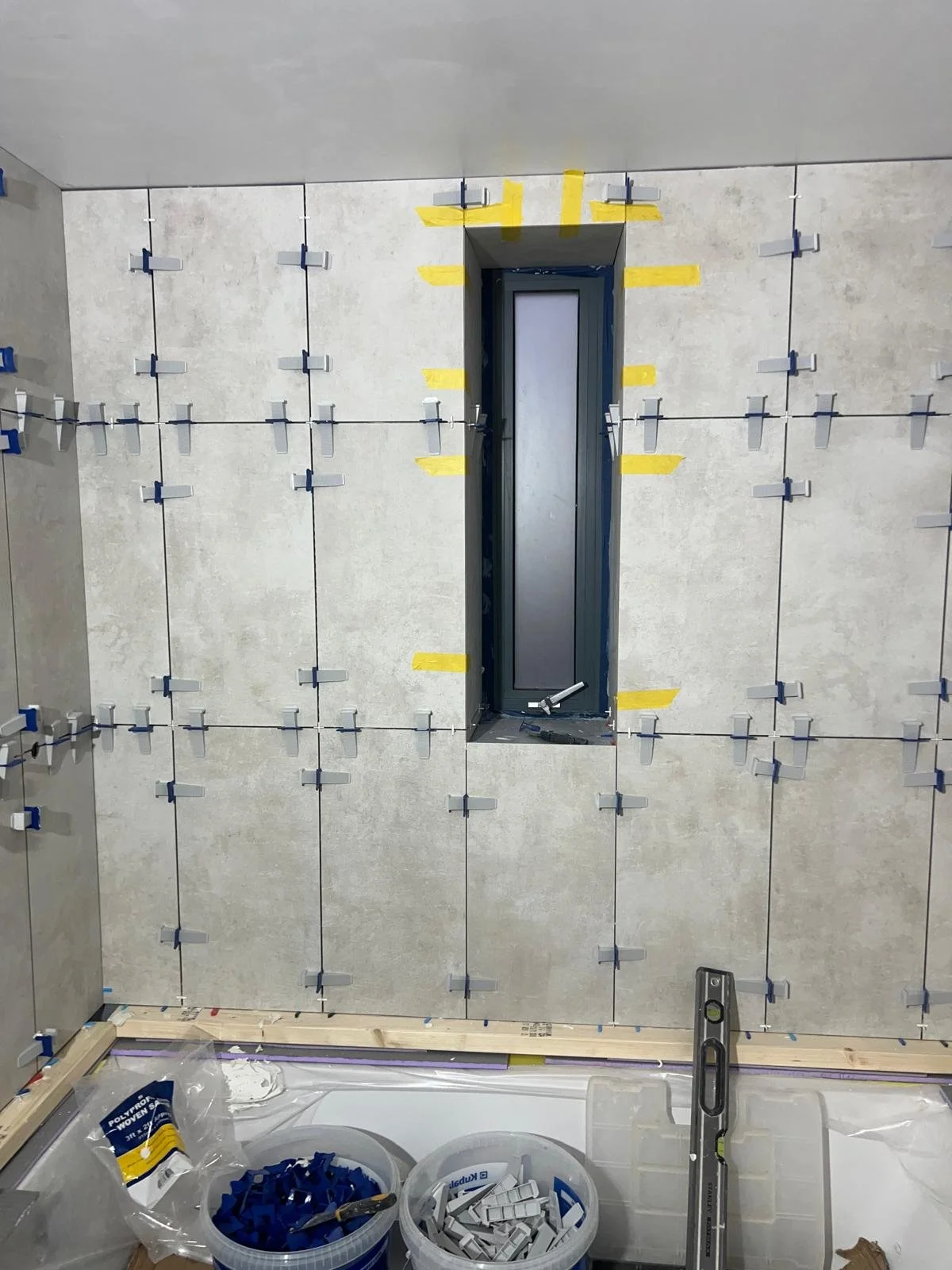

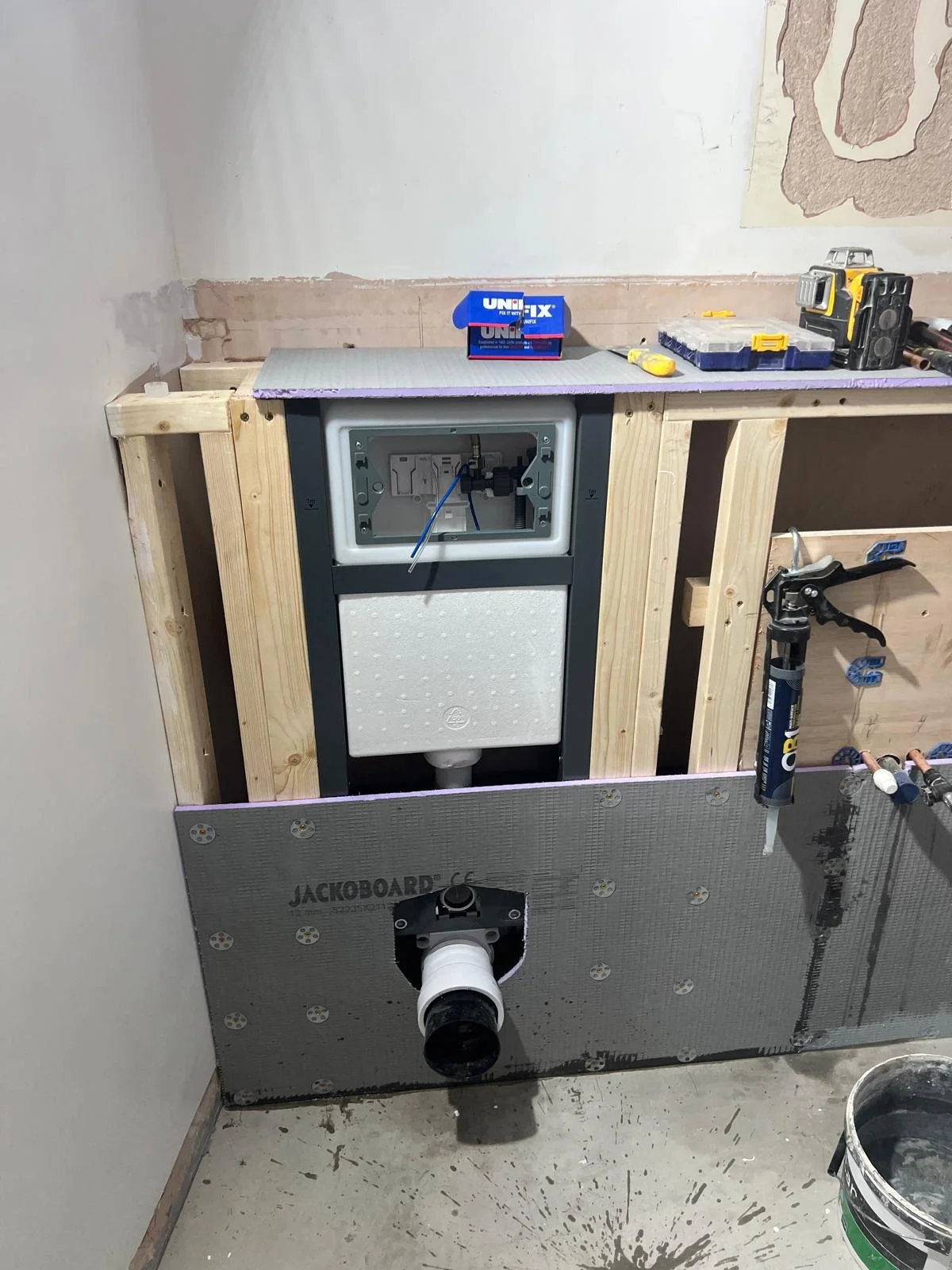

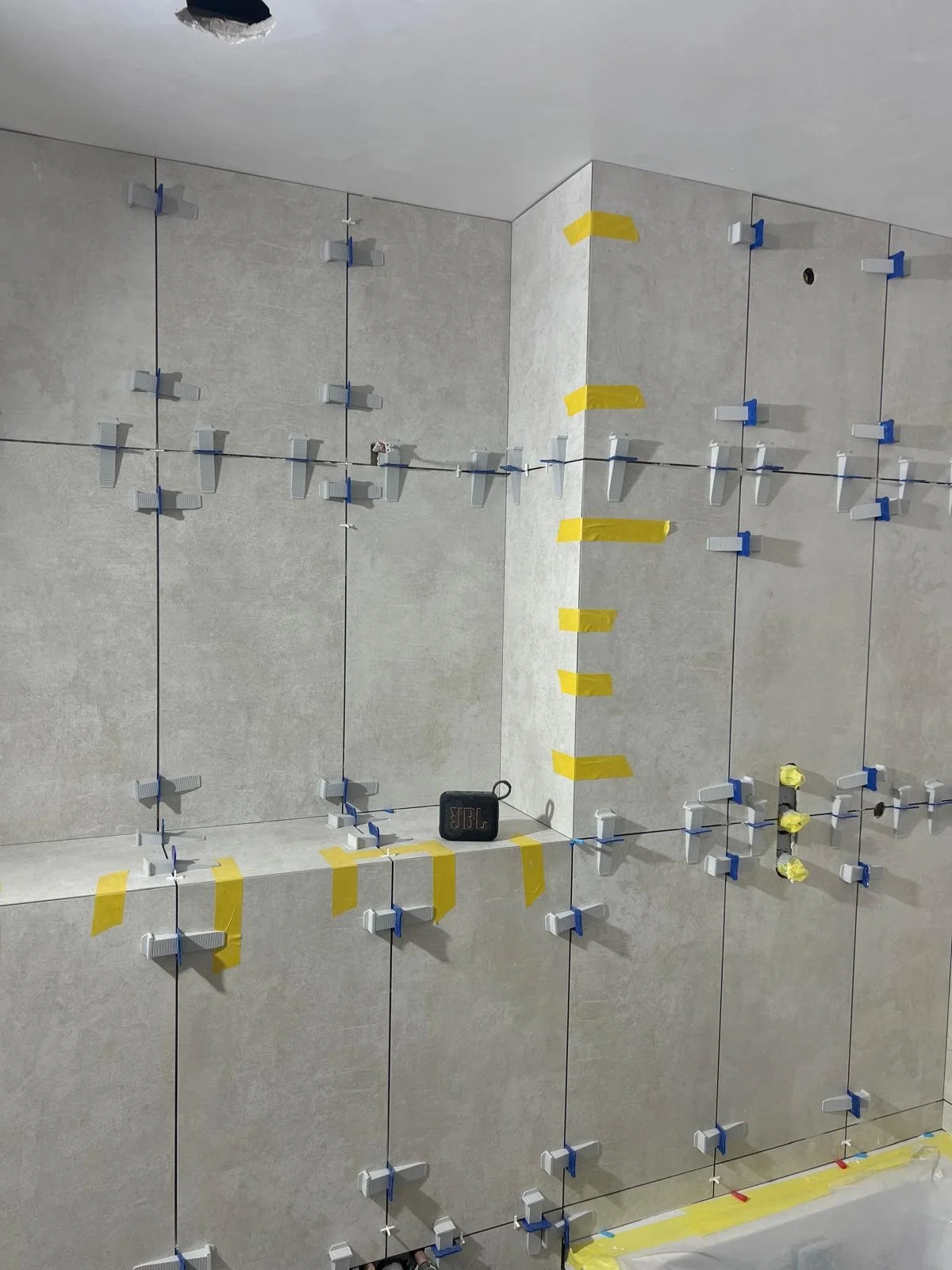

In parallel, the bathroom was rebuilt with correct wet-area preparation, including:

  • proper waterproofing and tanking

  • controlled substrate preparation

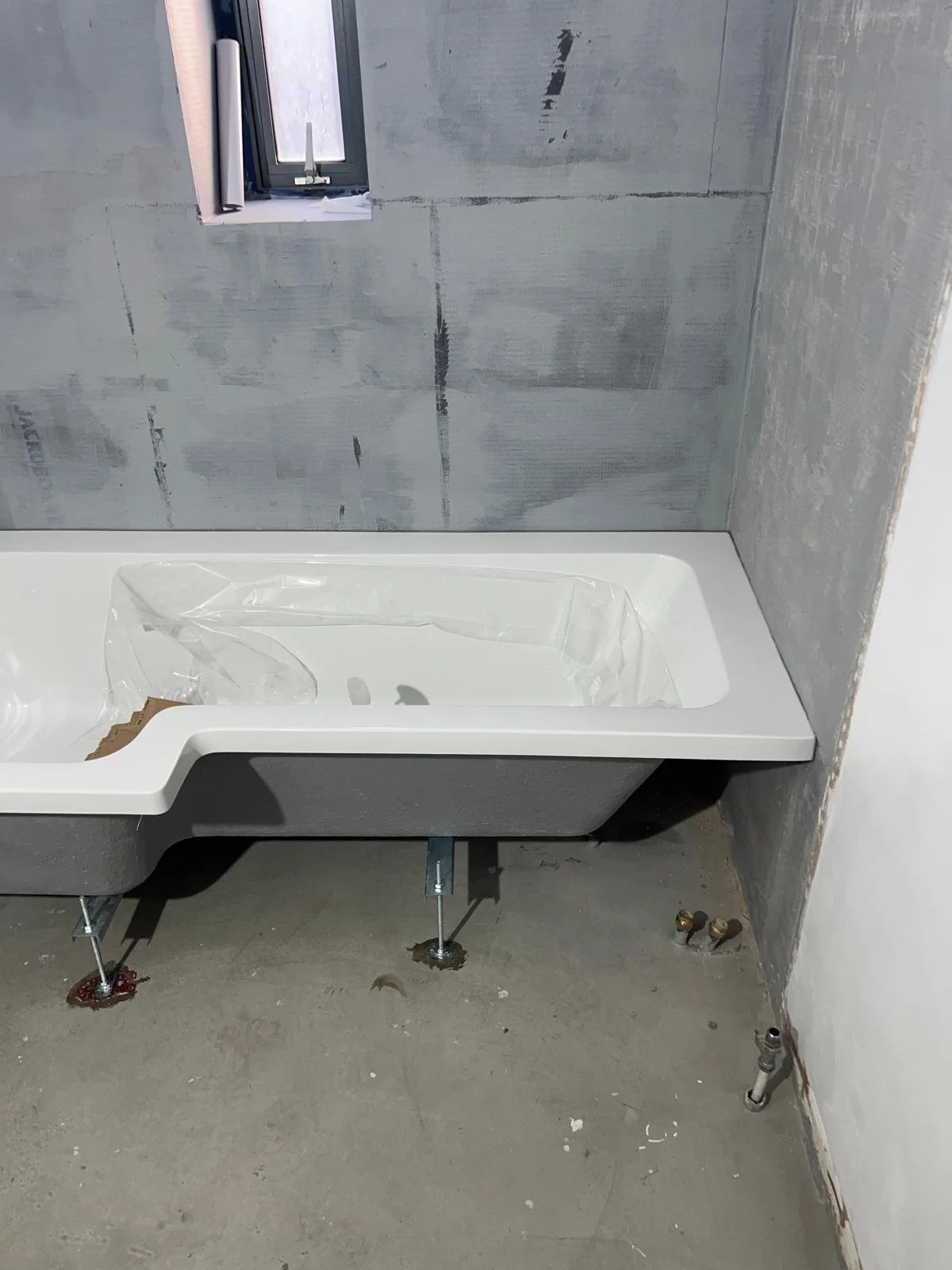

  • installation of new sanitaryware and finishes

Each component — both mechanical and visible — was designed to function as part of a single, integrated system.

This ensured:

  • balanced water distribution

  • stable system pressure

  • controlled temperature delivery

  • long-term durability of both the installation and the bathroom environment

What was previously concealed, inconsistent, and failing is now structured, controlled, and built to last.

Final Result

A fully re-engineered system, combined with a properly constructed bathroom environment.

Everything is now:

  • accessible

  • controlled

  • and built for long-term performance

What was once hidden and failing is now structured, reliable, and designed to last.

This project was never about fixing a leak.
It was about correcting the system that caused it.
